Church Refurbishment - Fall 2025-Winter 2026

Resurrection Church Pictures Before Refurbishment

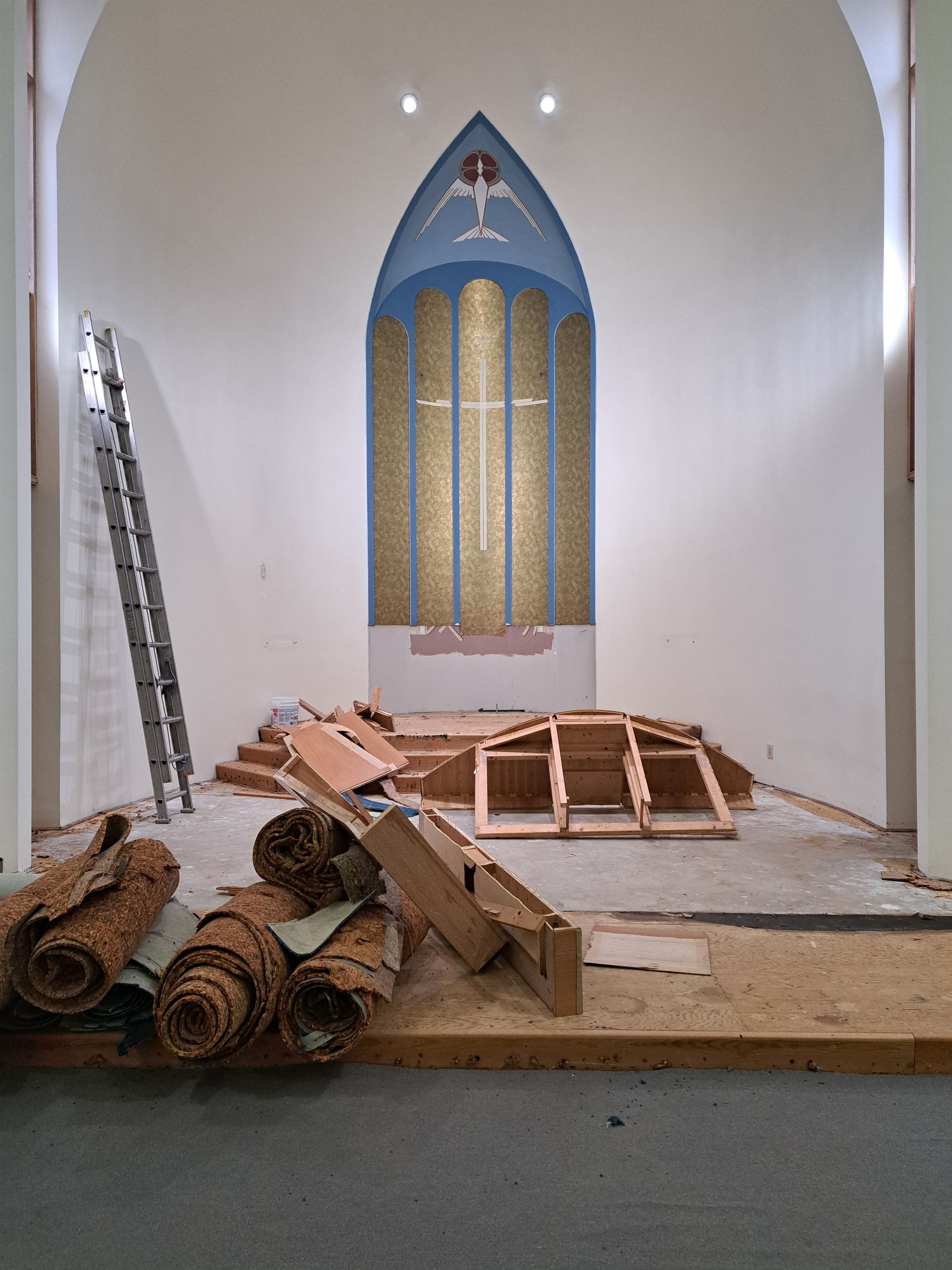

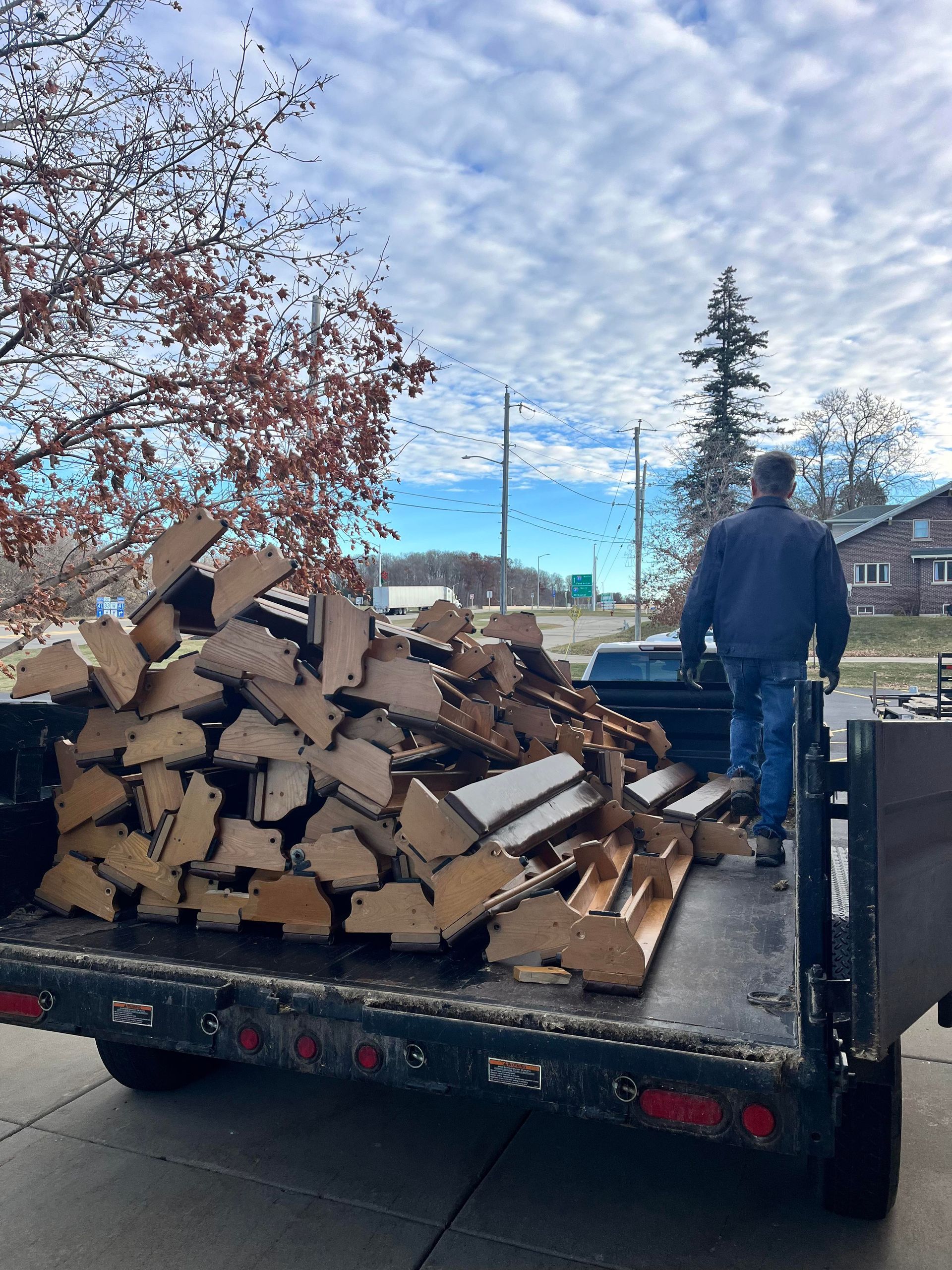

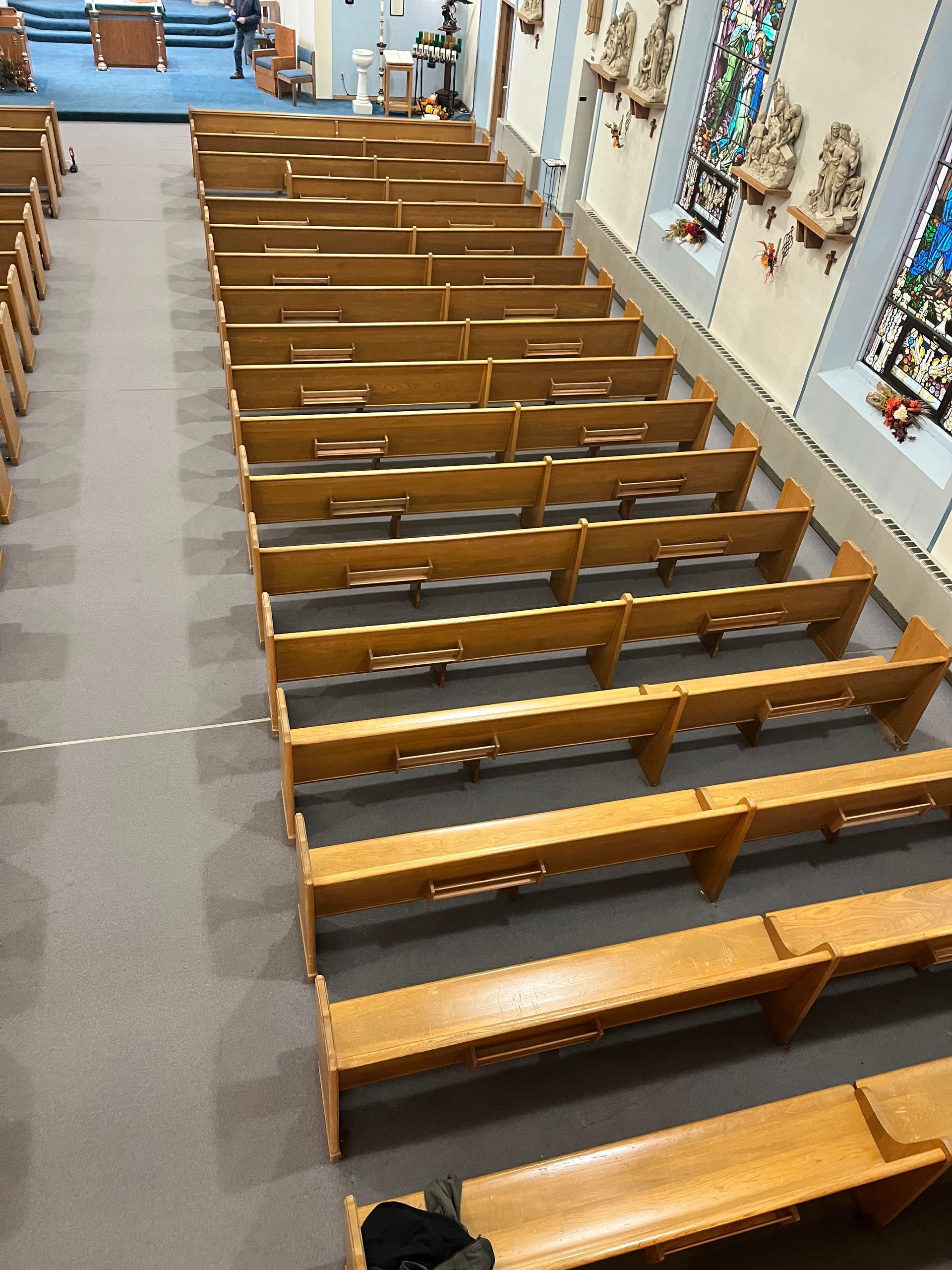

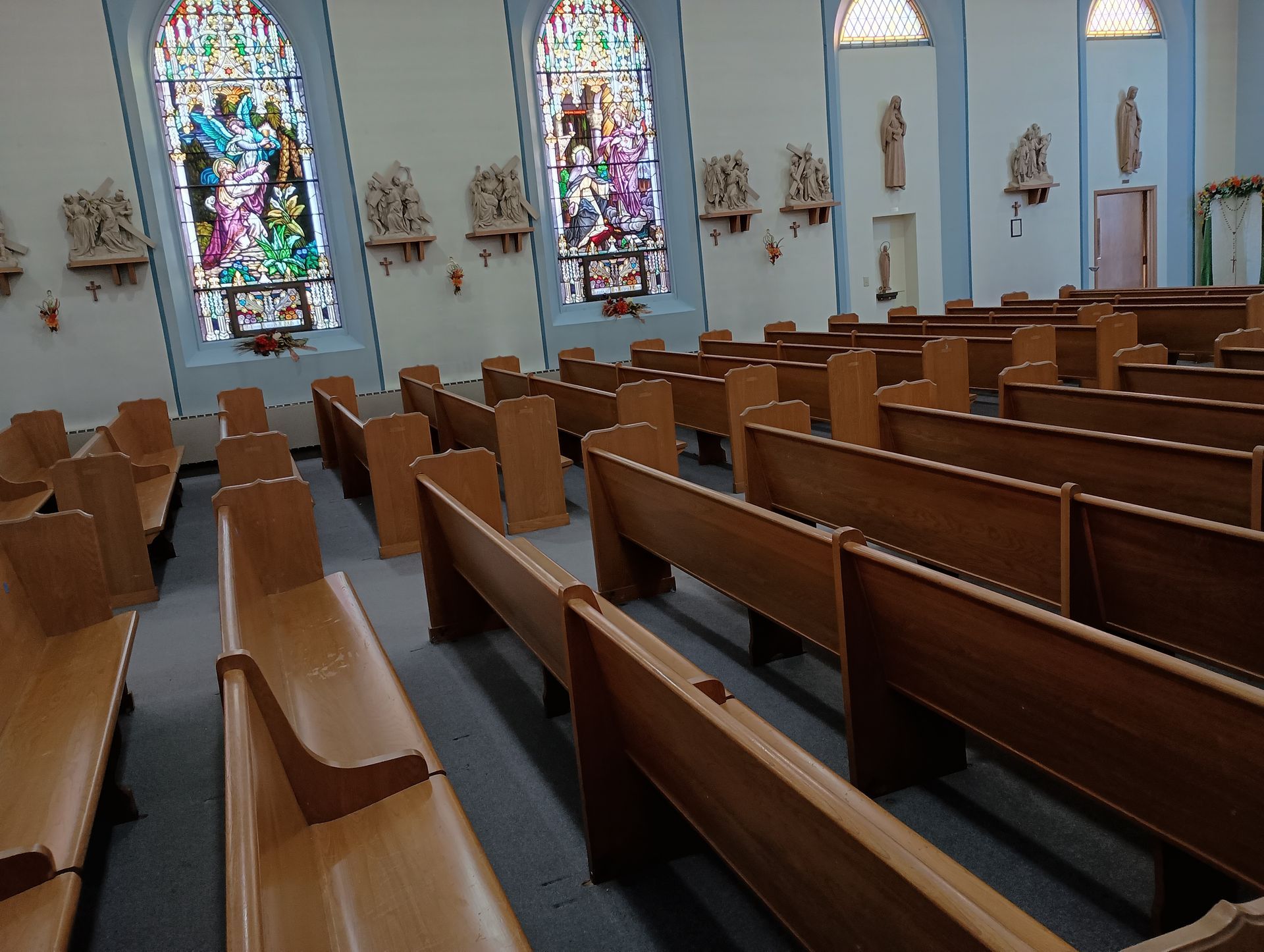

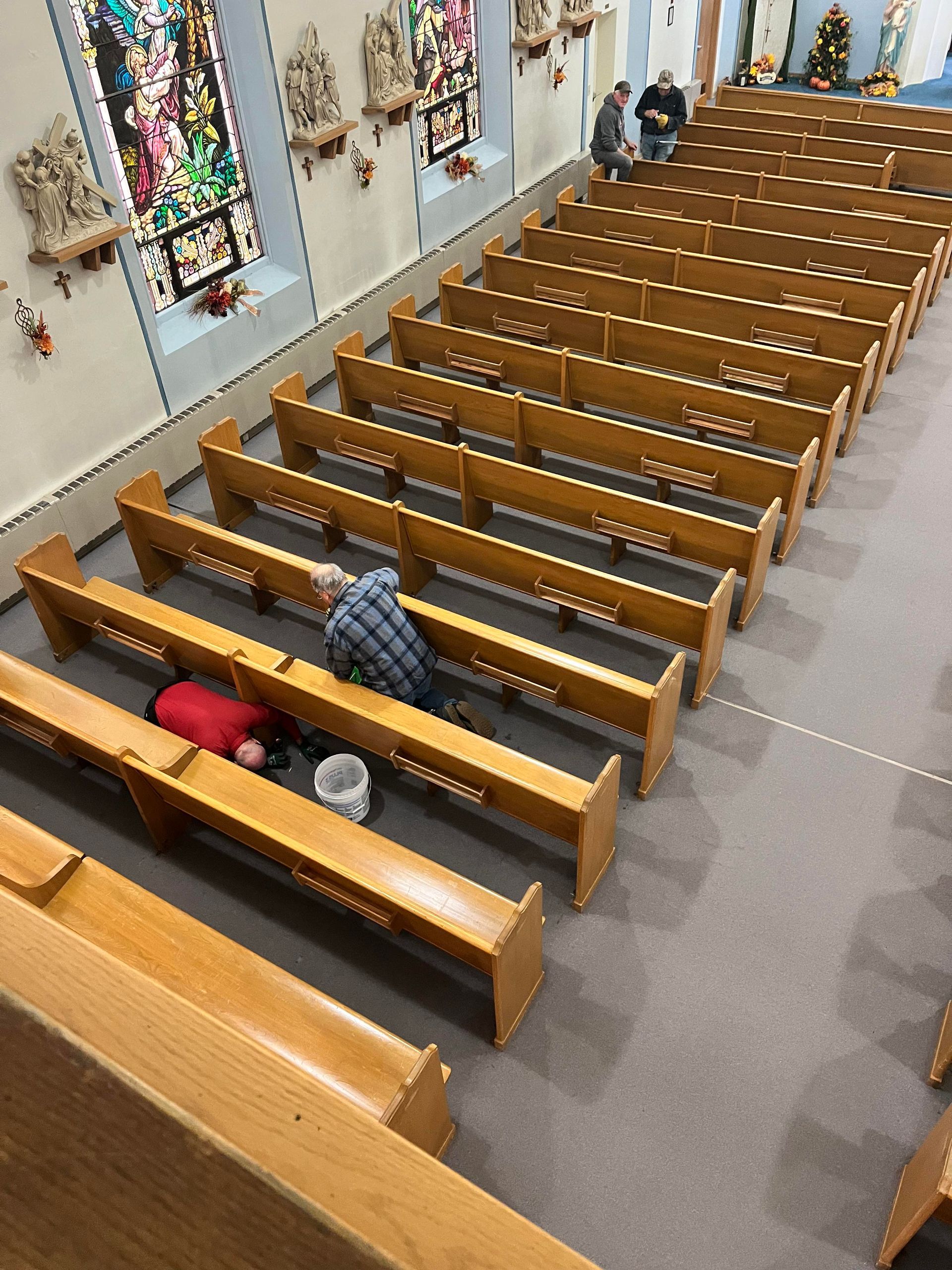

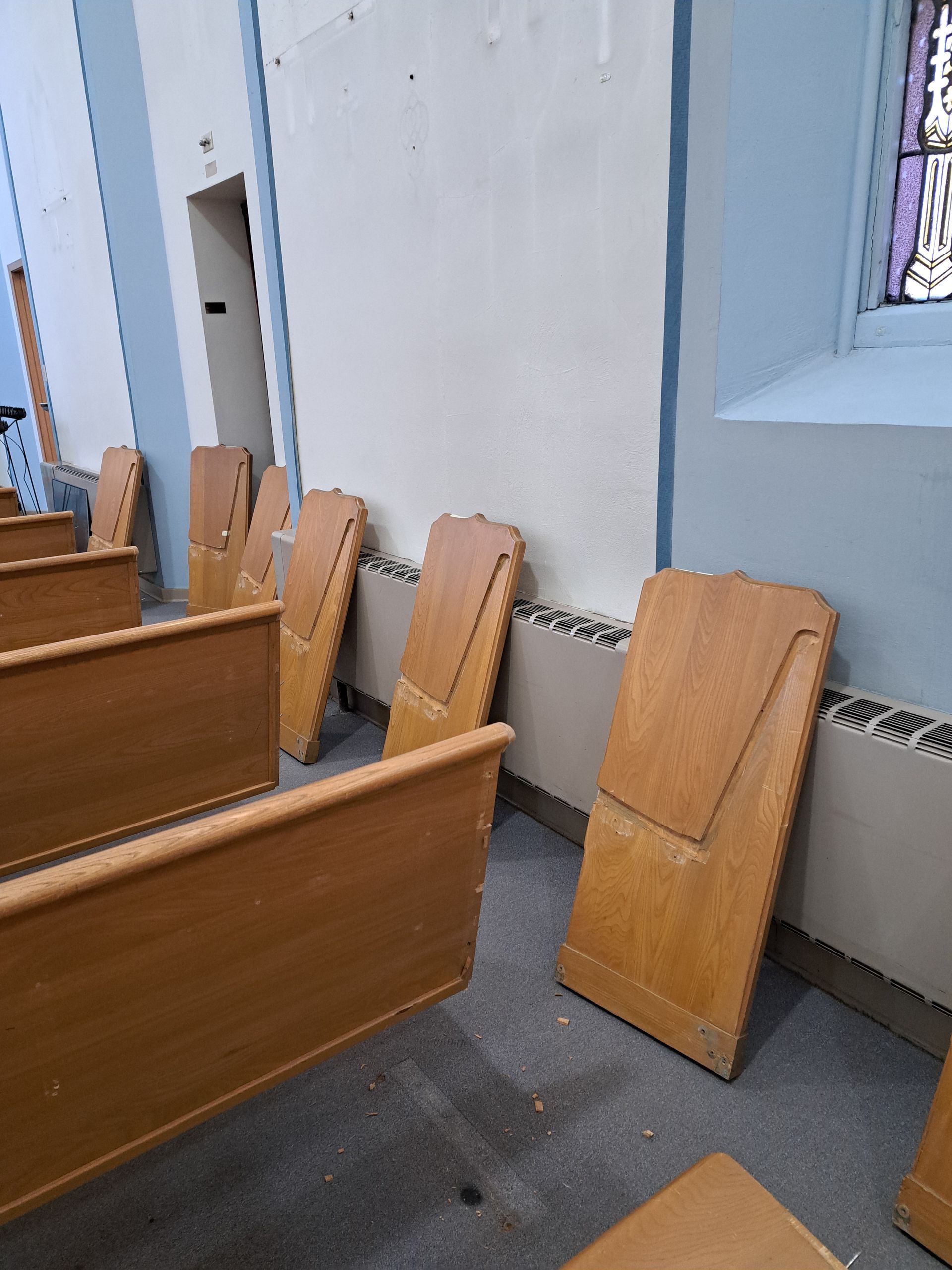

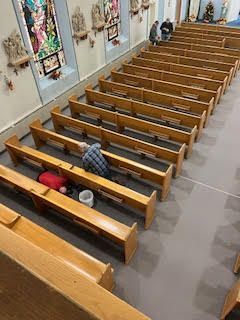

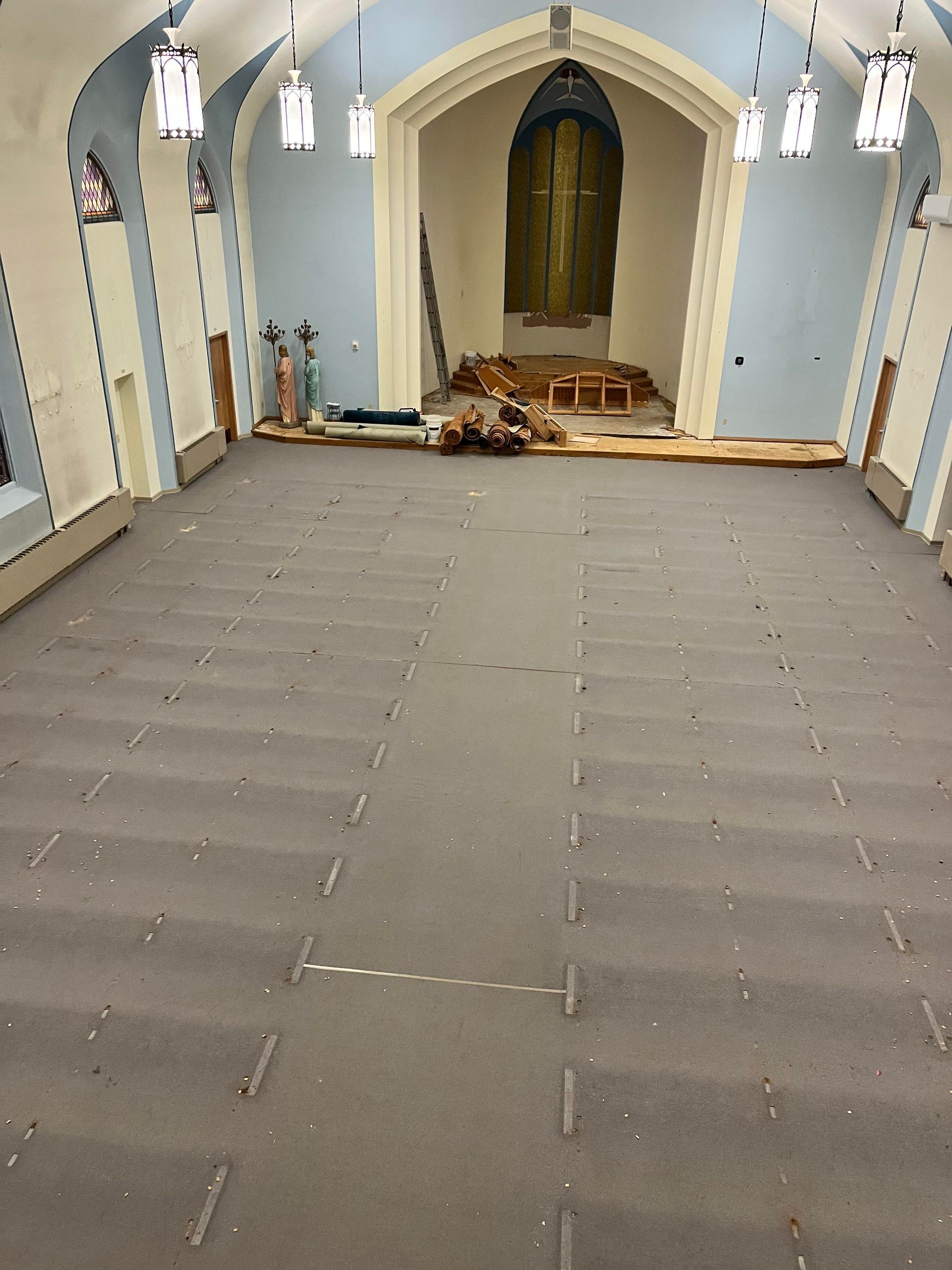

Nave and Sanctuary Cleared; Kneelers & Pews Removed - Nov. 17-18, 2025

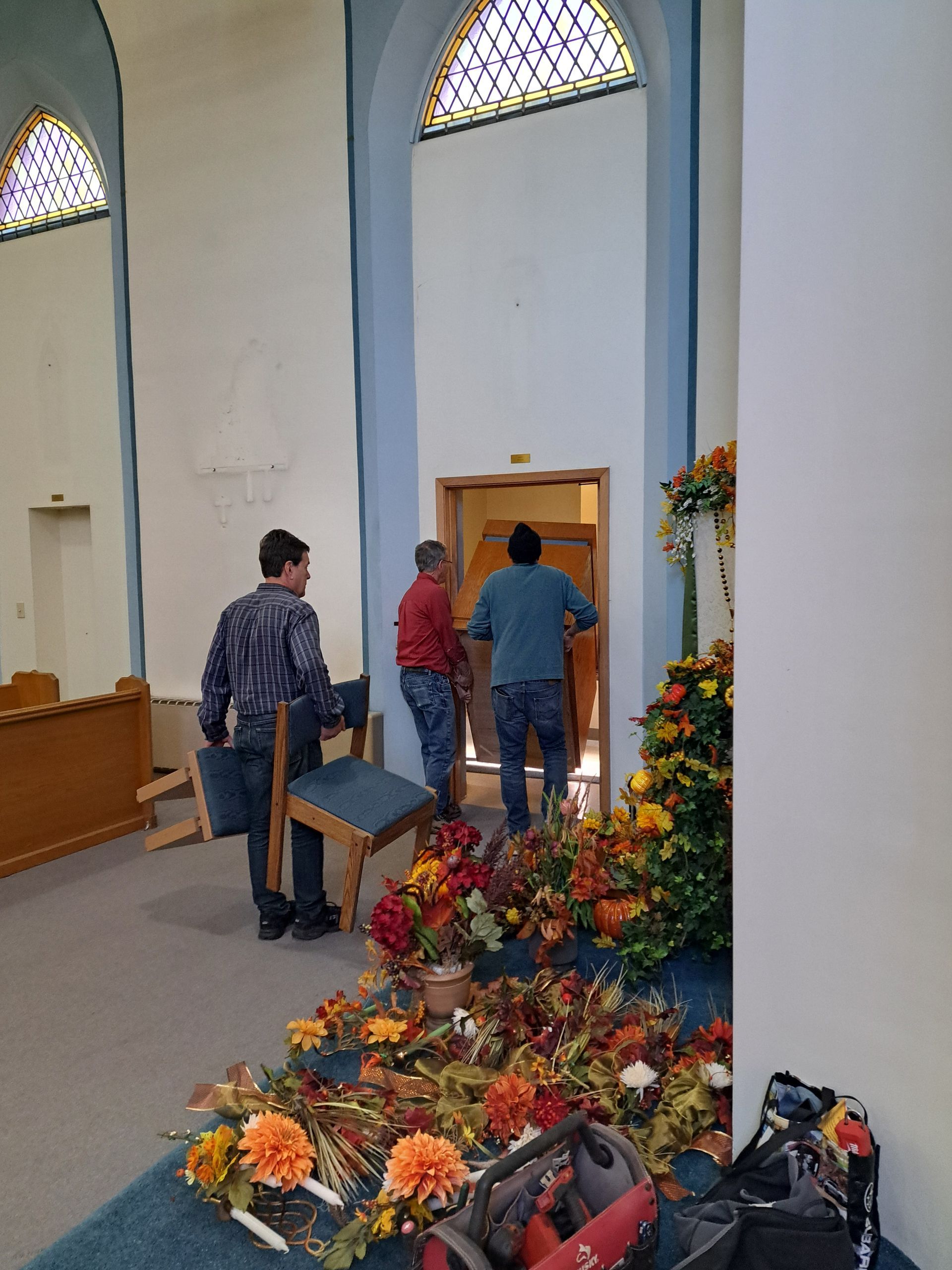

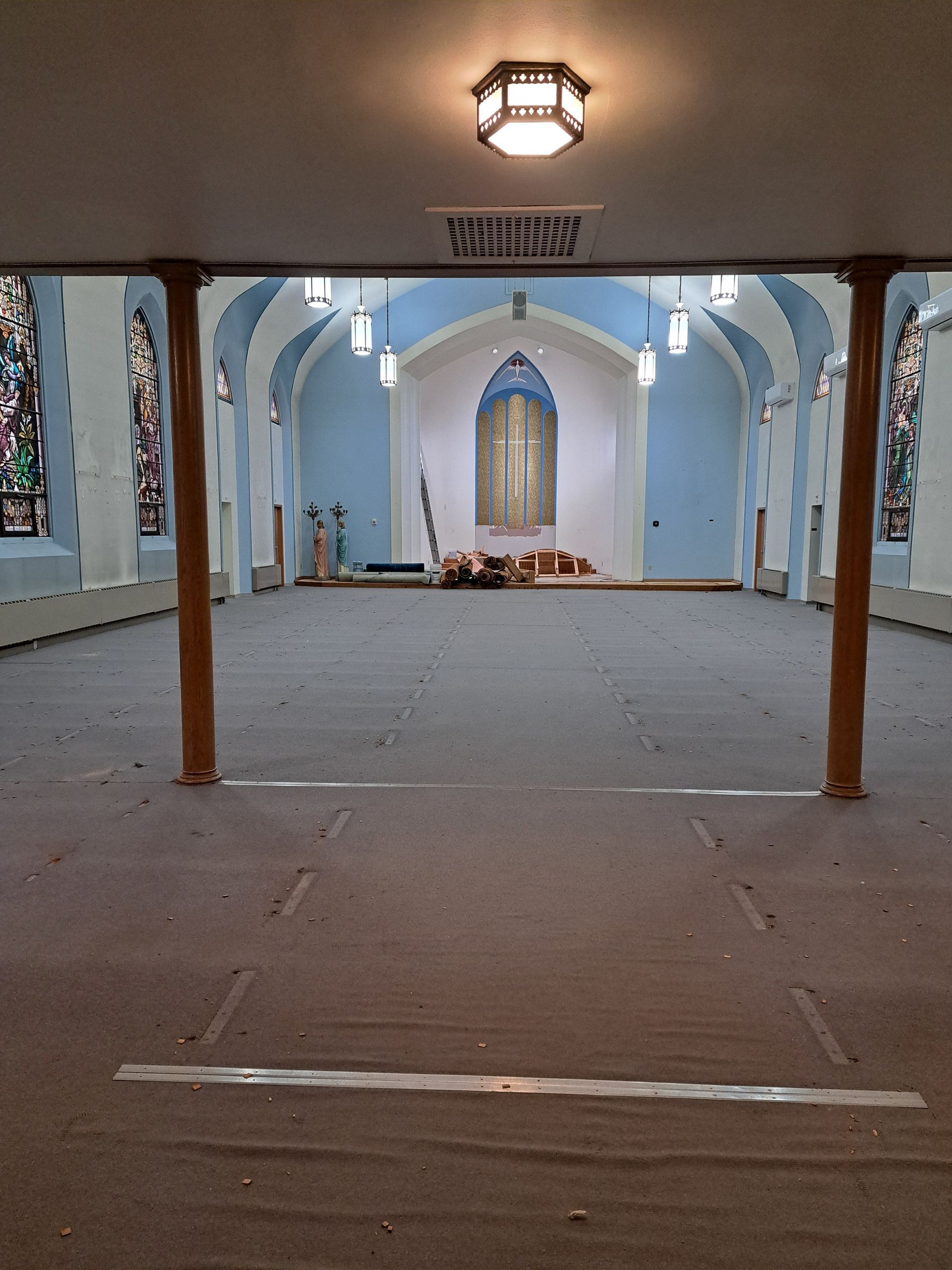

Our church beautification process began November 17, 2025. Parish volunteers helped to clear the church as much as possible to allow an open work area as our project got underway. Many hands make light work, as the saying goes. Thanks to all who helped!

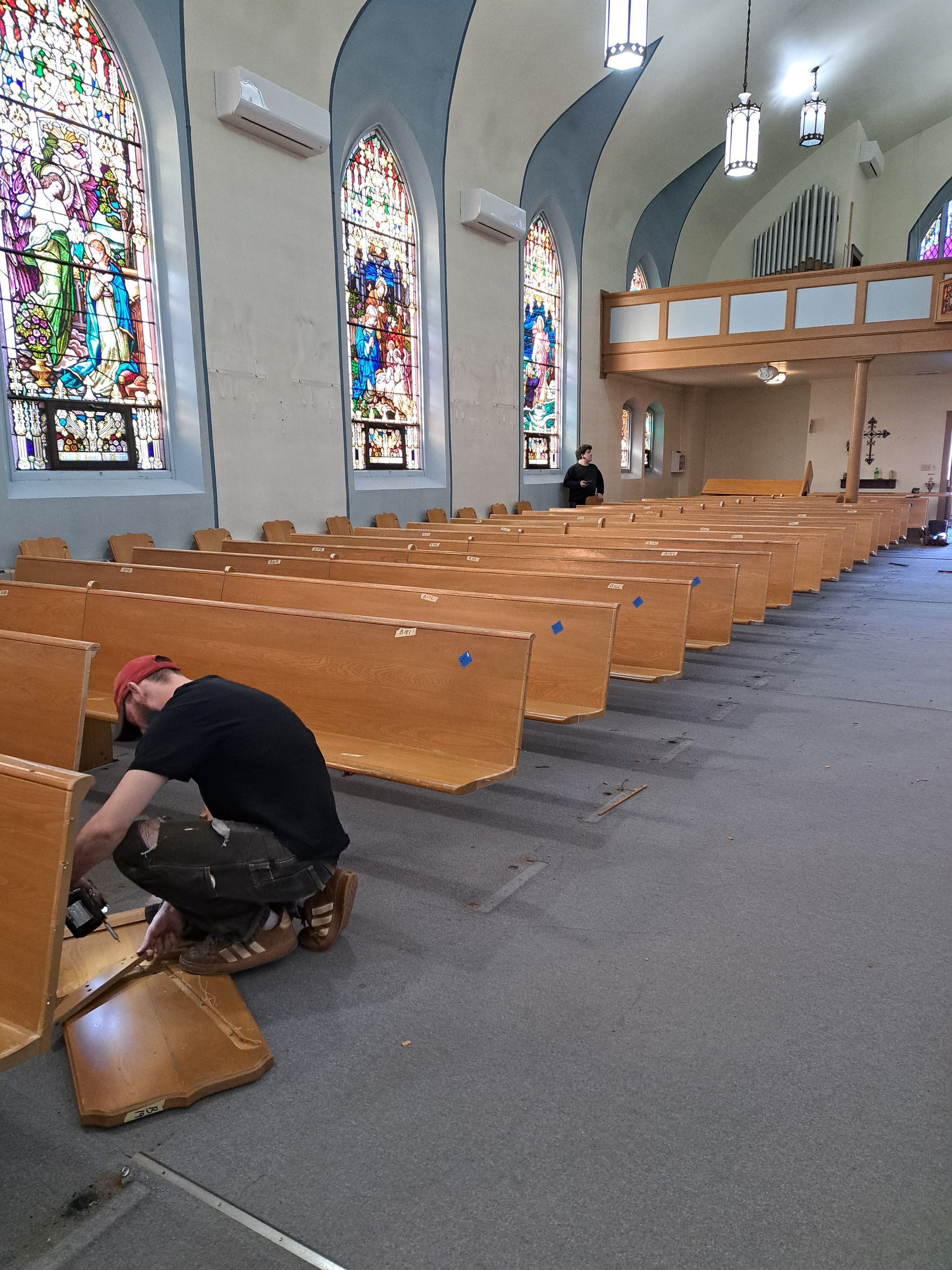

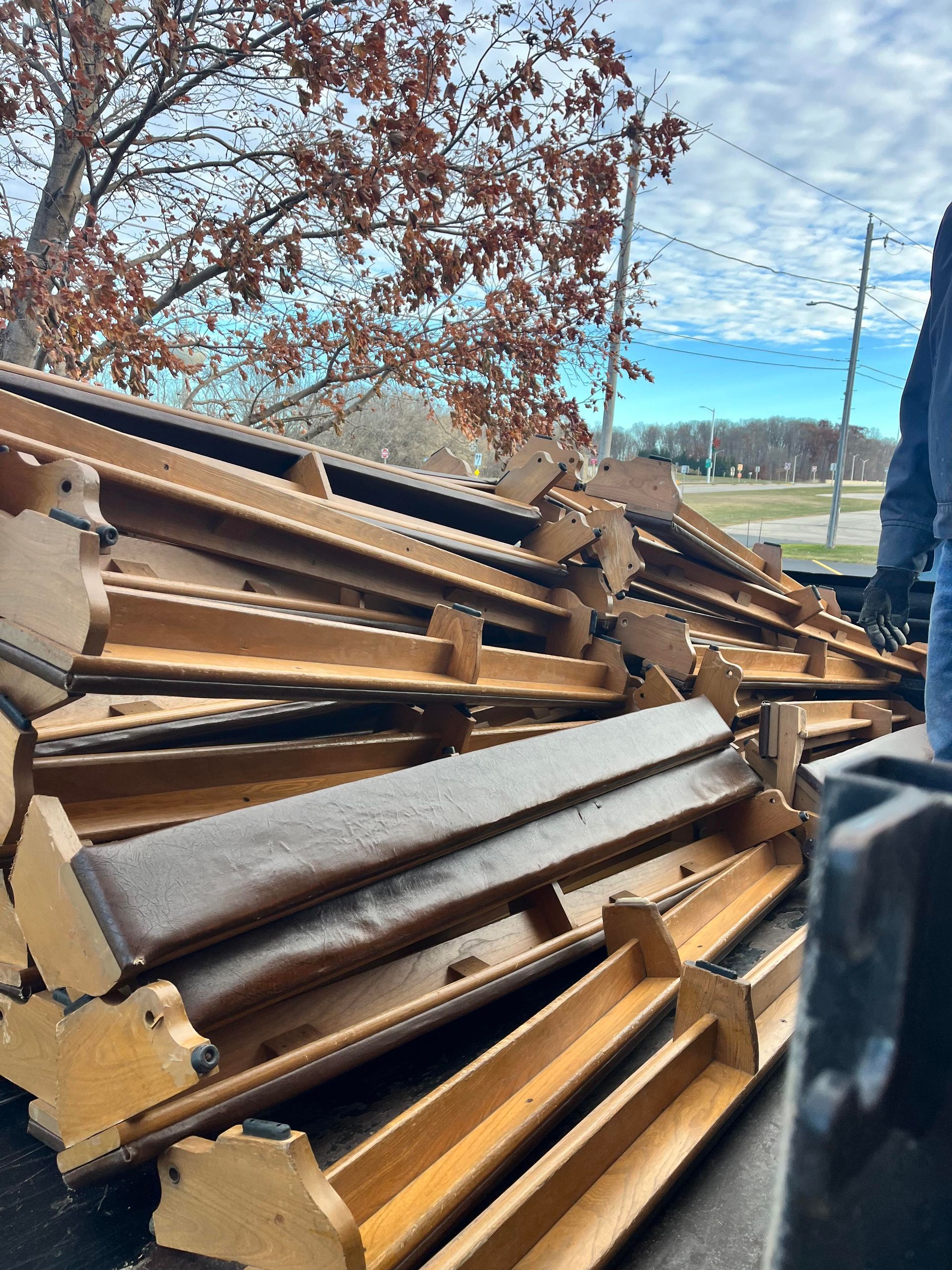

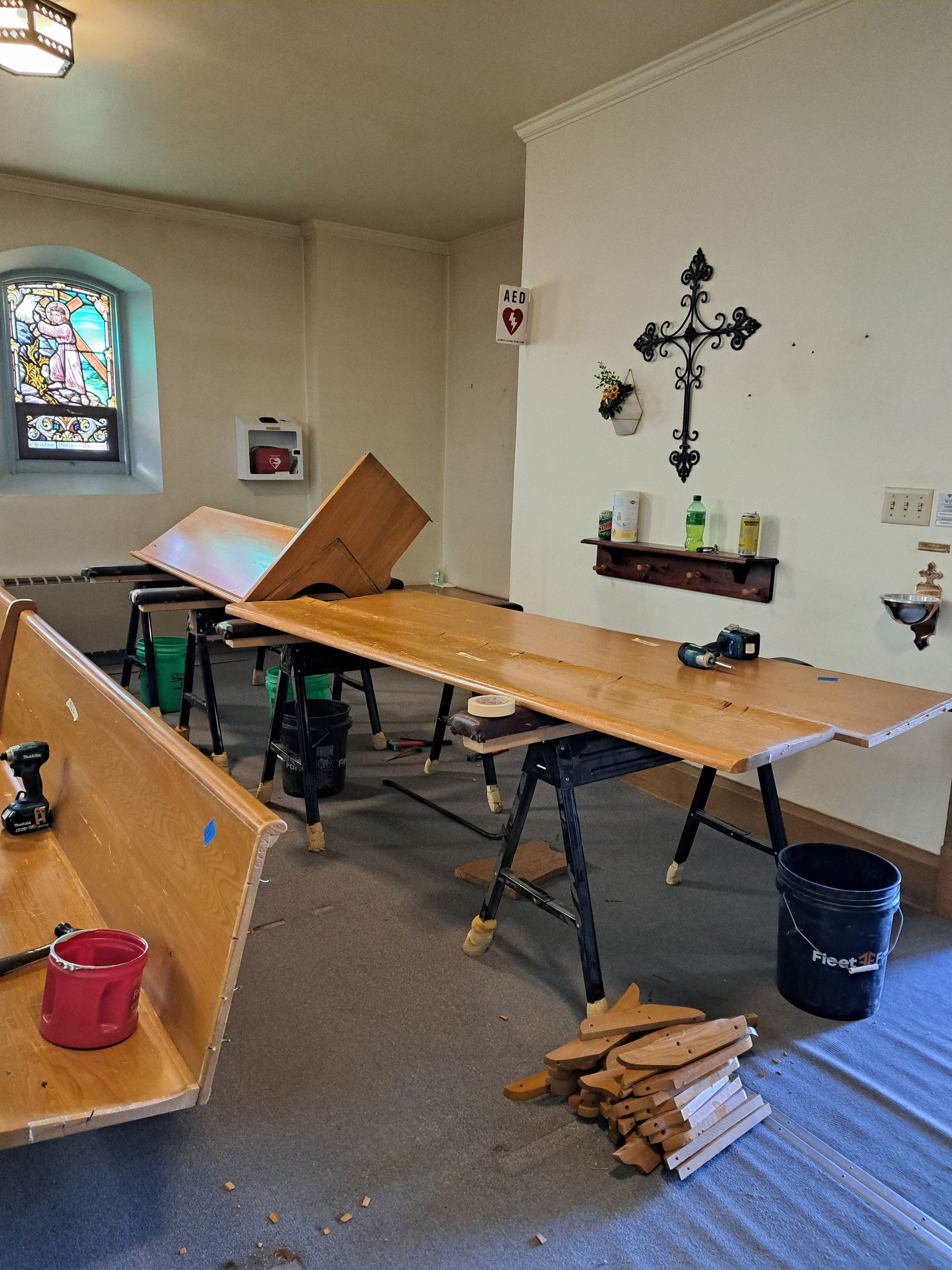

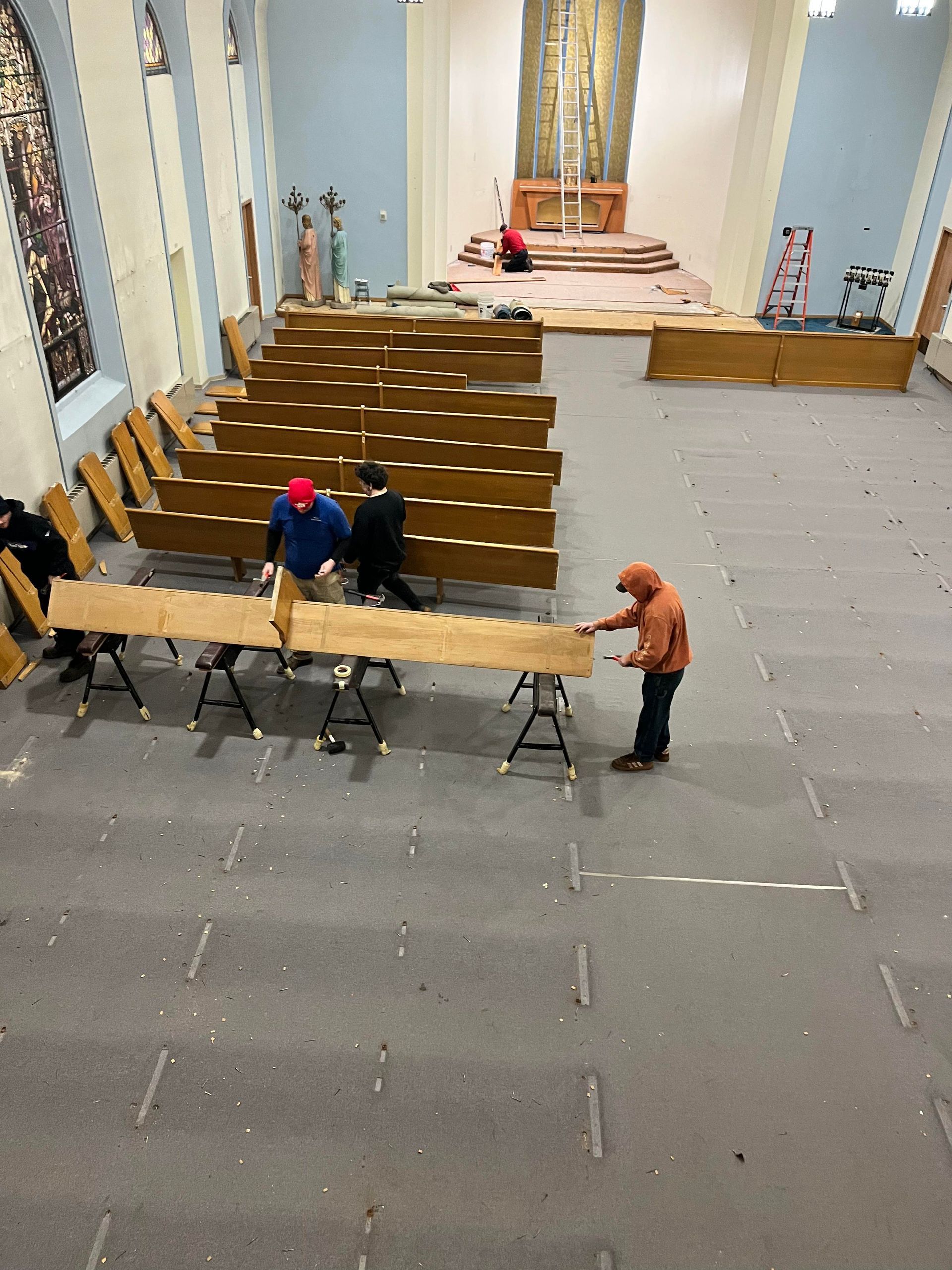

Wood Renovators was on-site to remove our pews. Removal started with marking all pew pieces before disassembly. Pew parts were then transported to their Waupaca facility for stripping, repairs and refinishing.

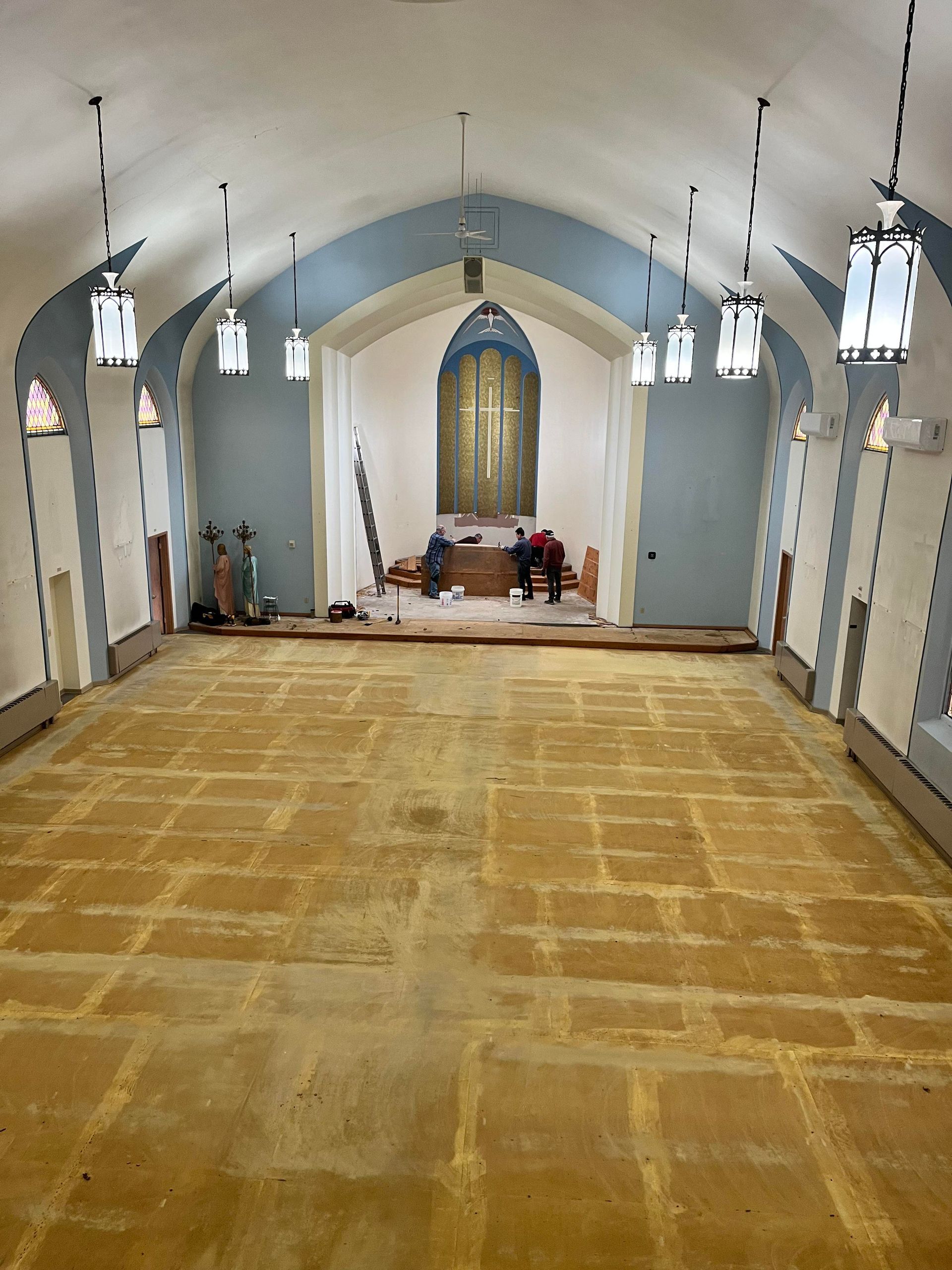

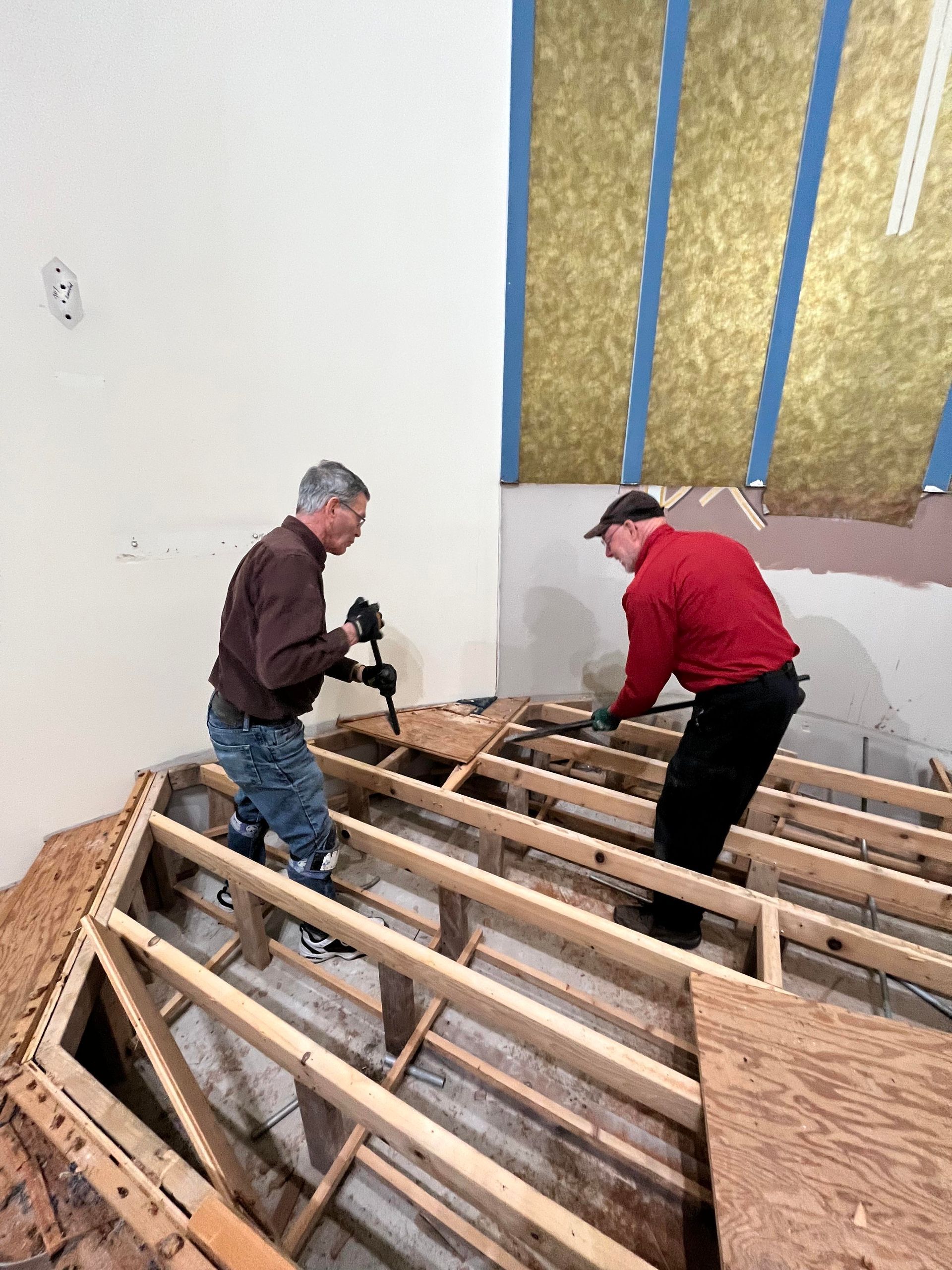

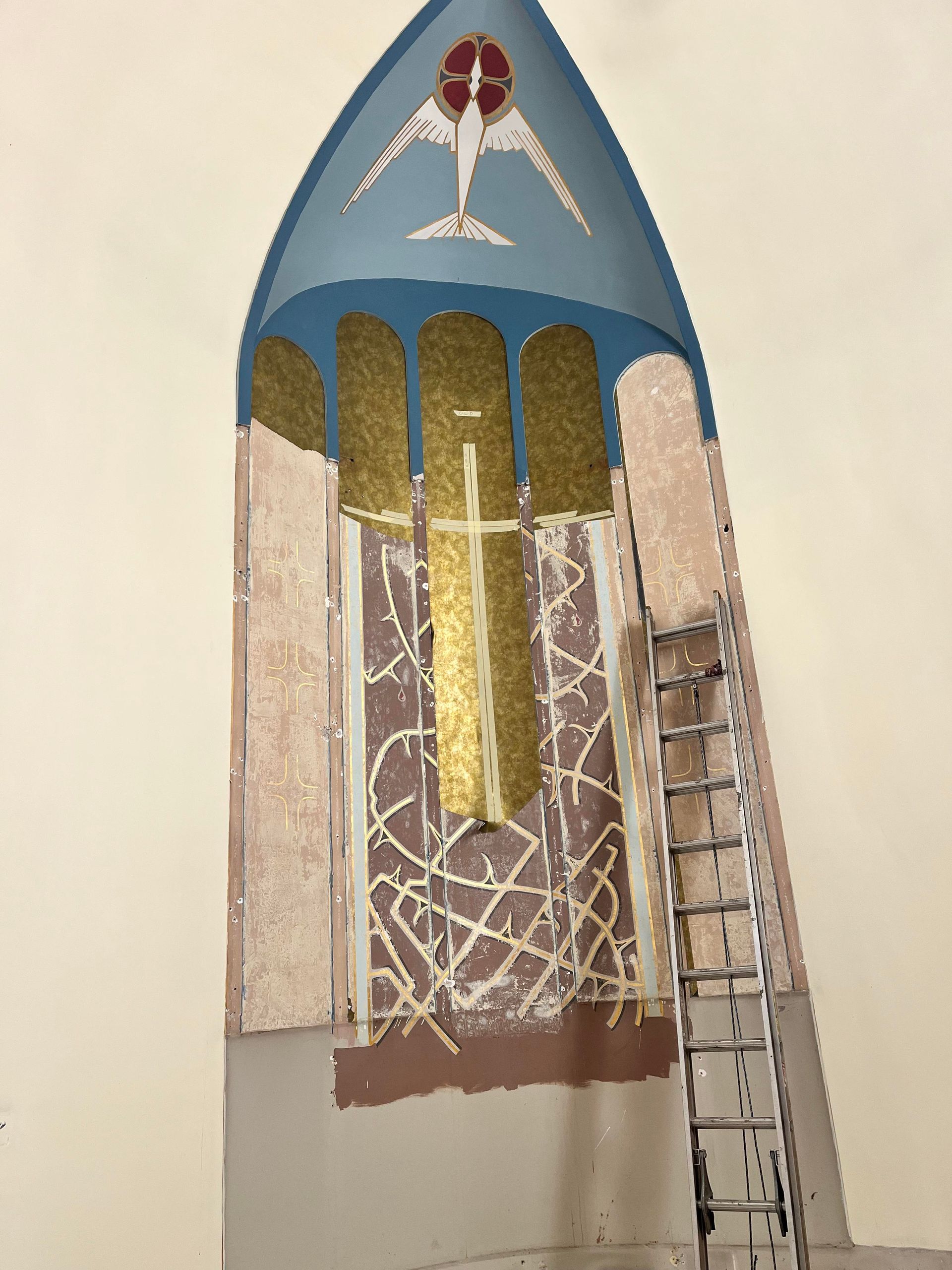

Carpet in Nave and Steps in Sanctuary Removed - Nov. 19, 2025

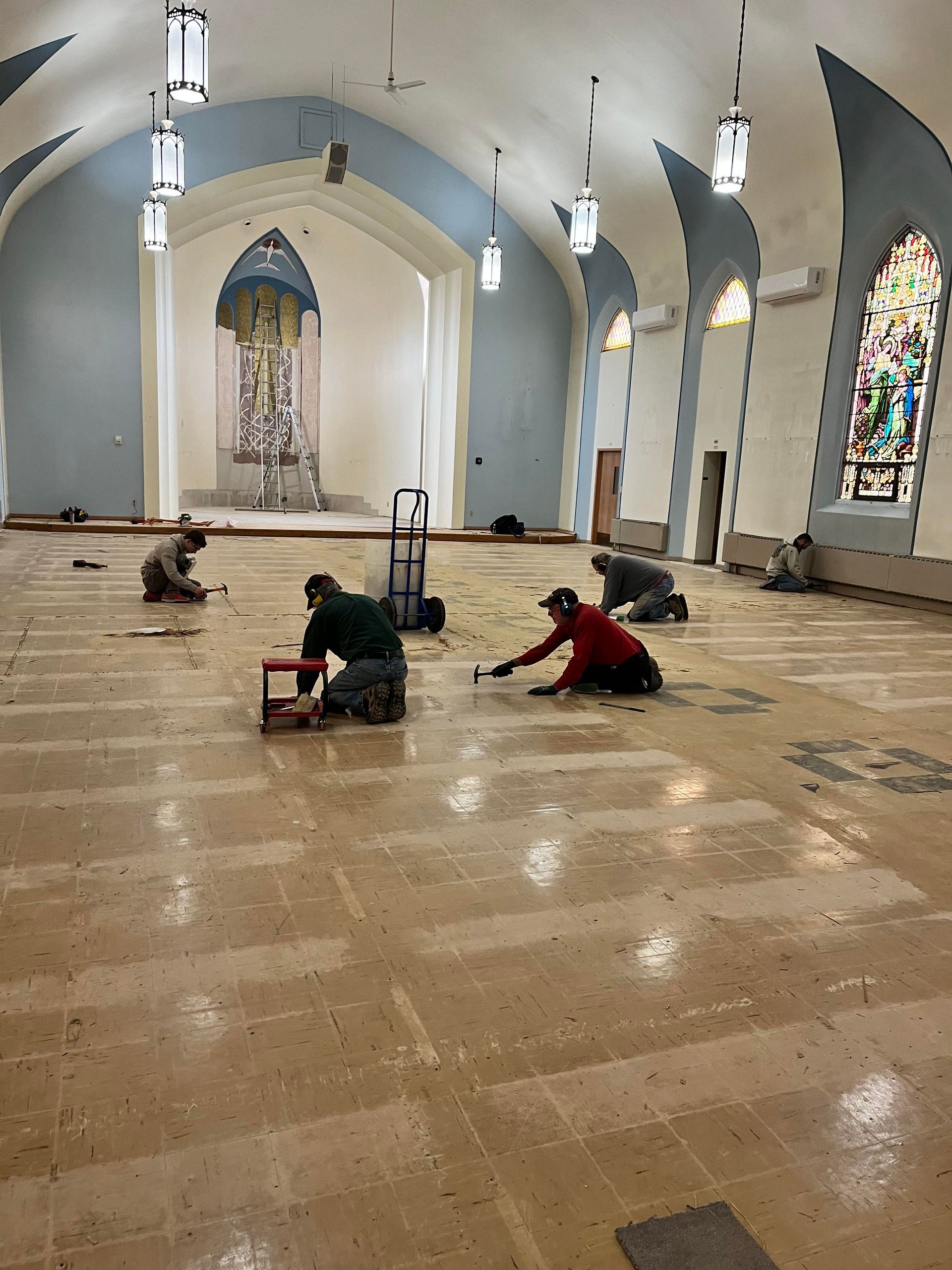

Prepping the floor prior to scaffolding - Nov. 24, 2025

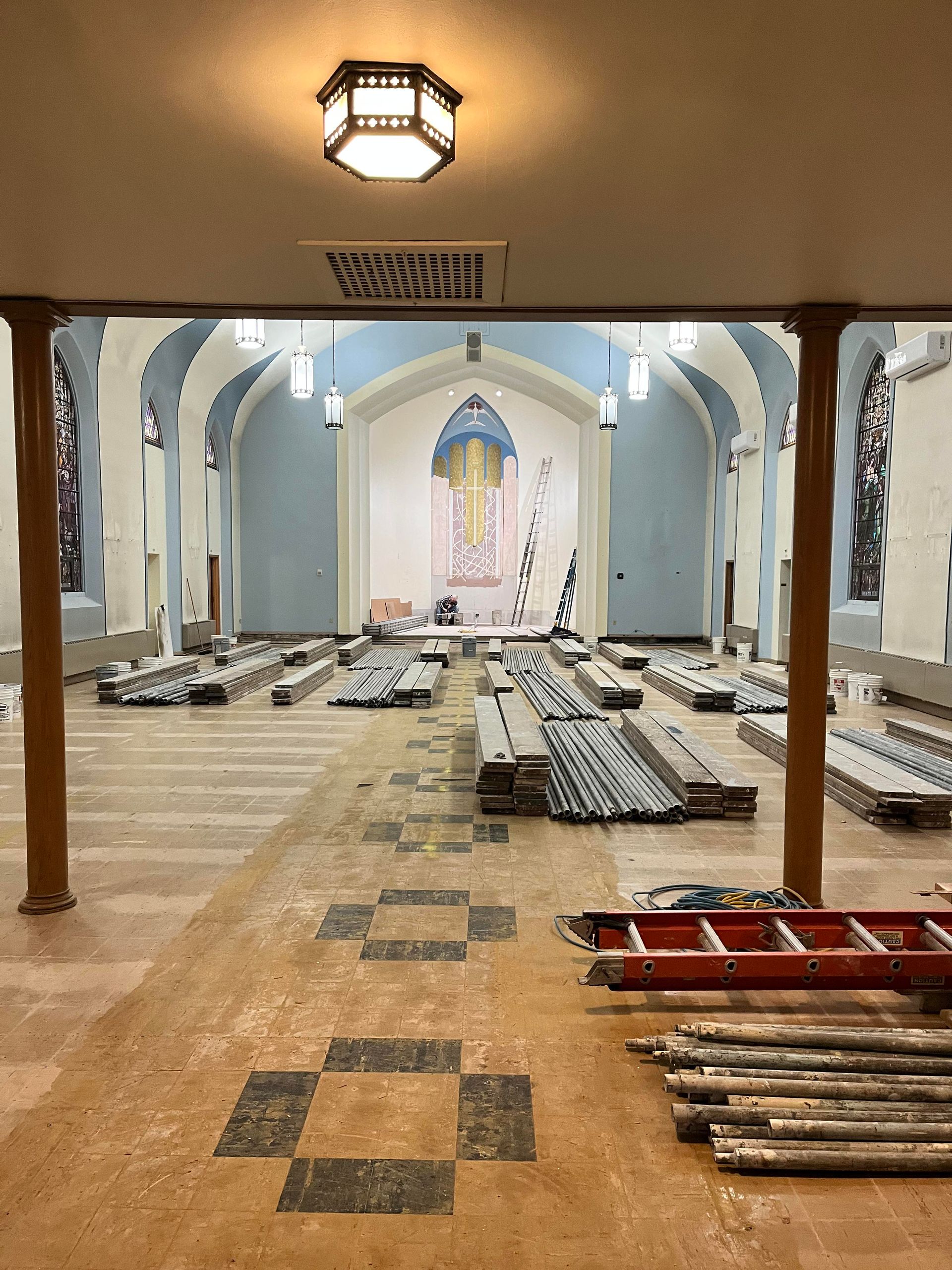

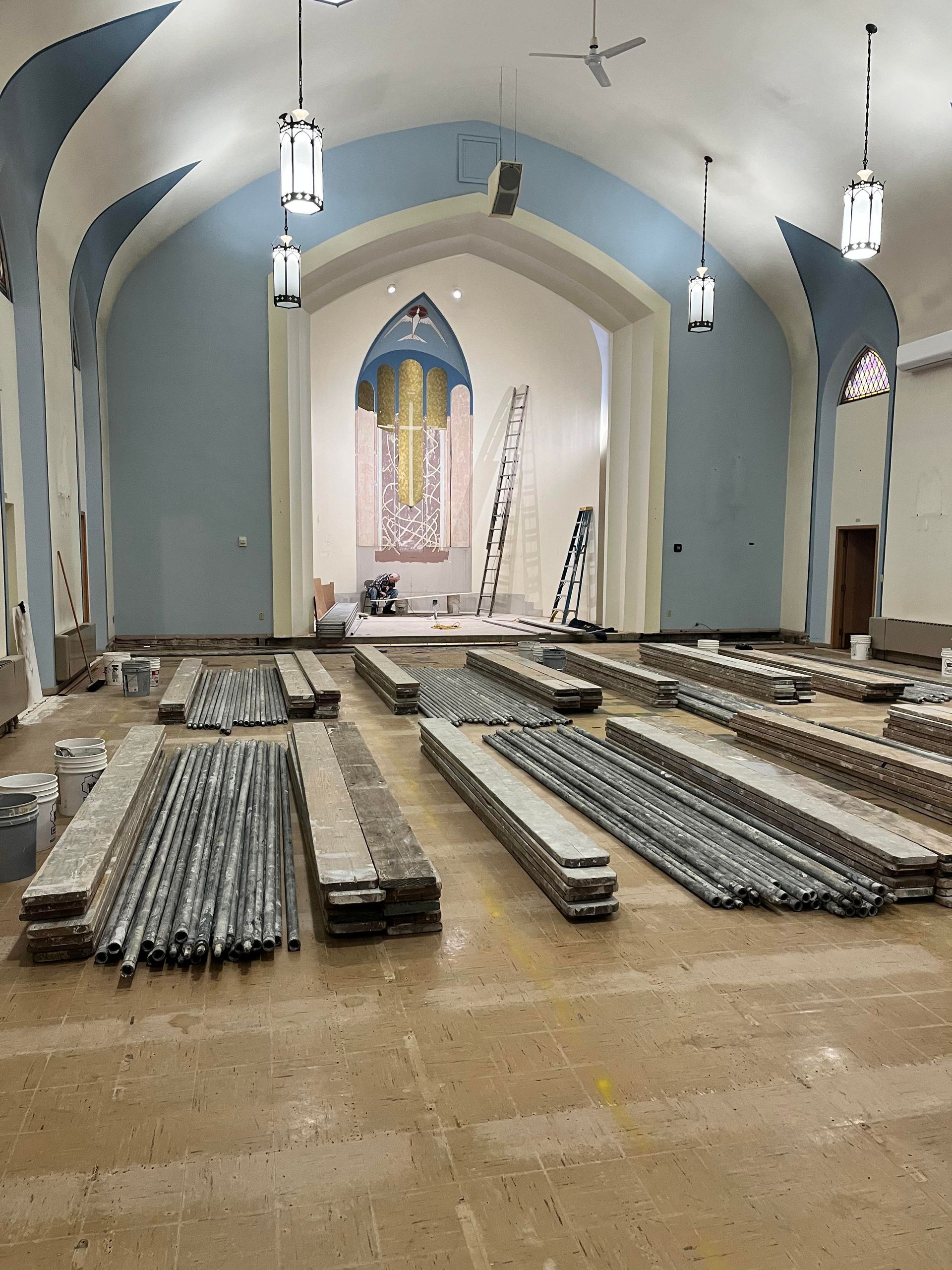

Scaffolding arrived and was unloaded with the help of volunteers - Dec. 1, 2025

Riehle Decorating arrived on Monday, December 1, to begin the process of repairing the plaster and painting the church interior. Several parish volunteers helped to unload the scaffolding pieces.

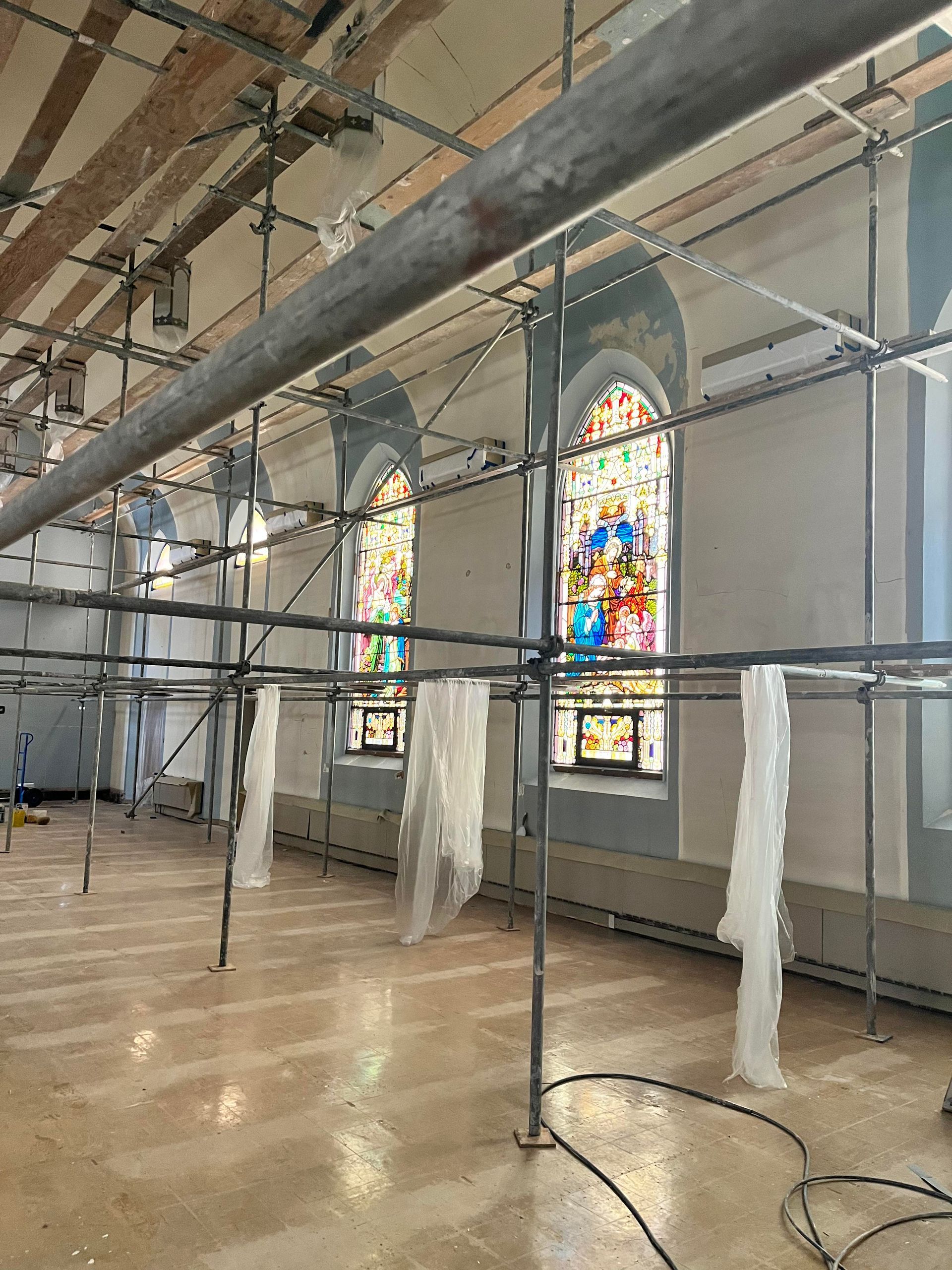

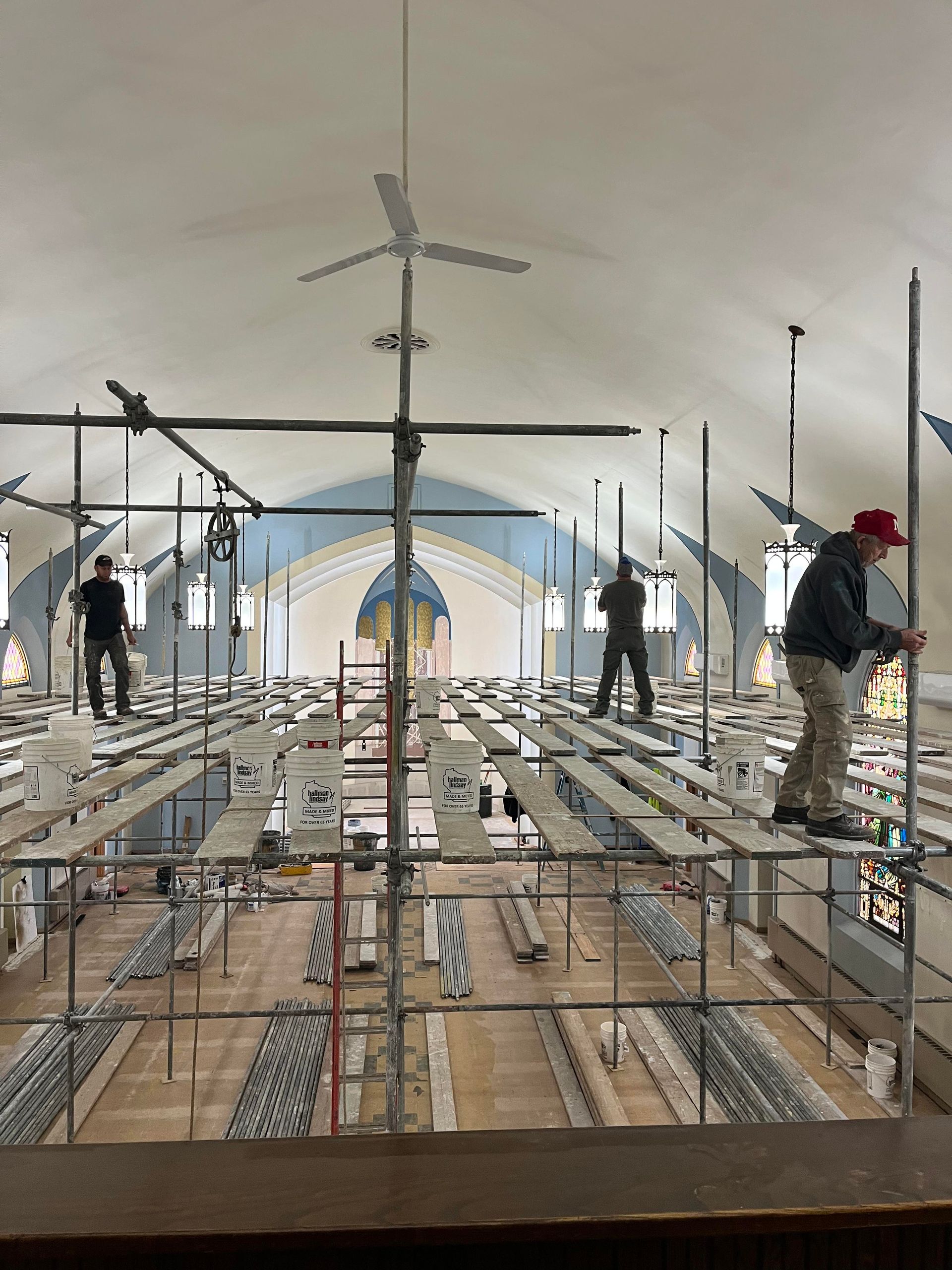

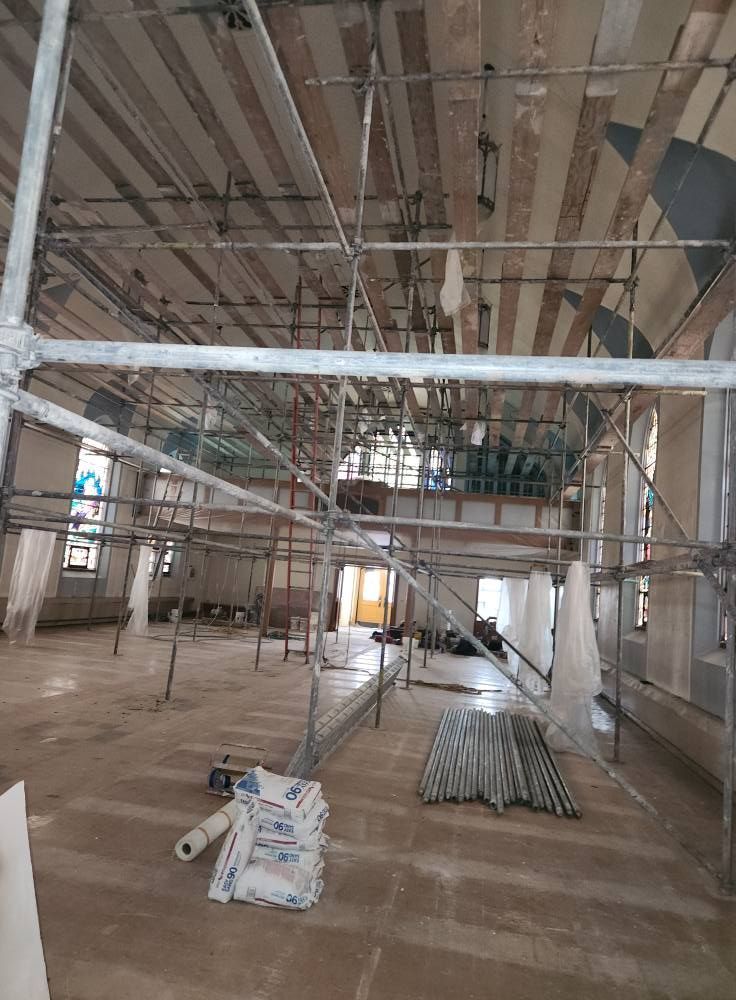

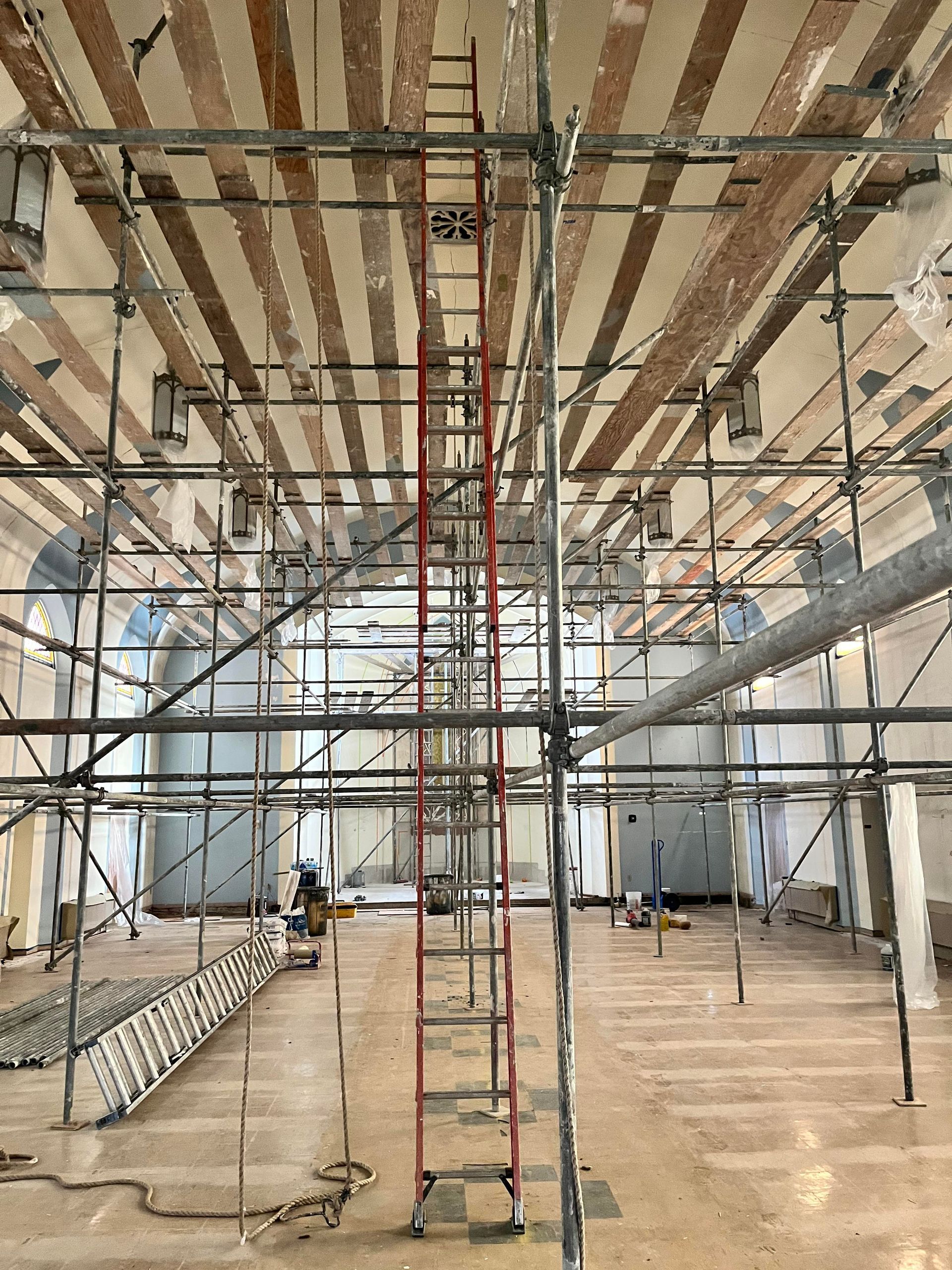

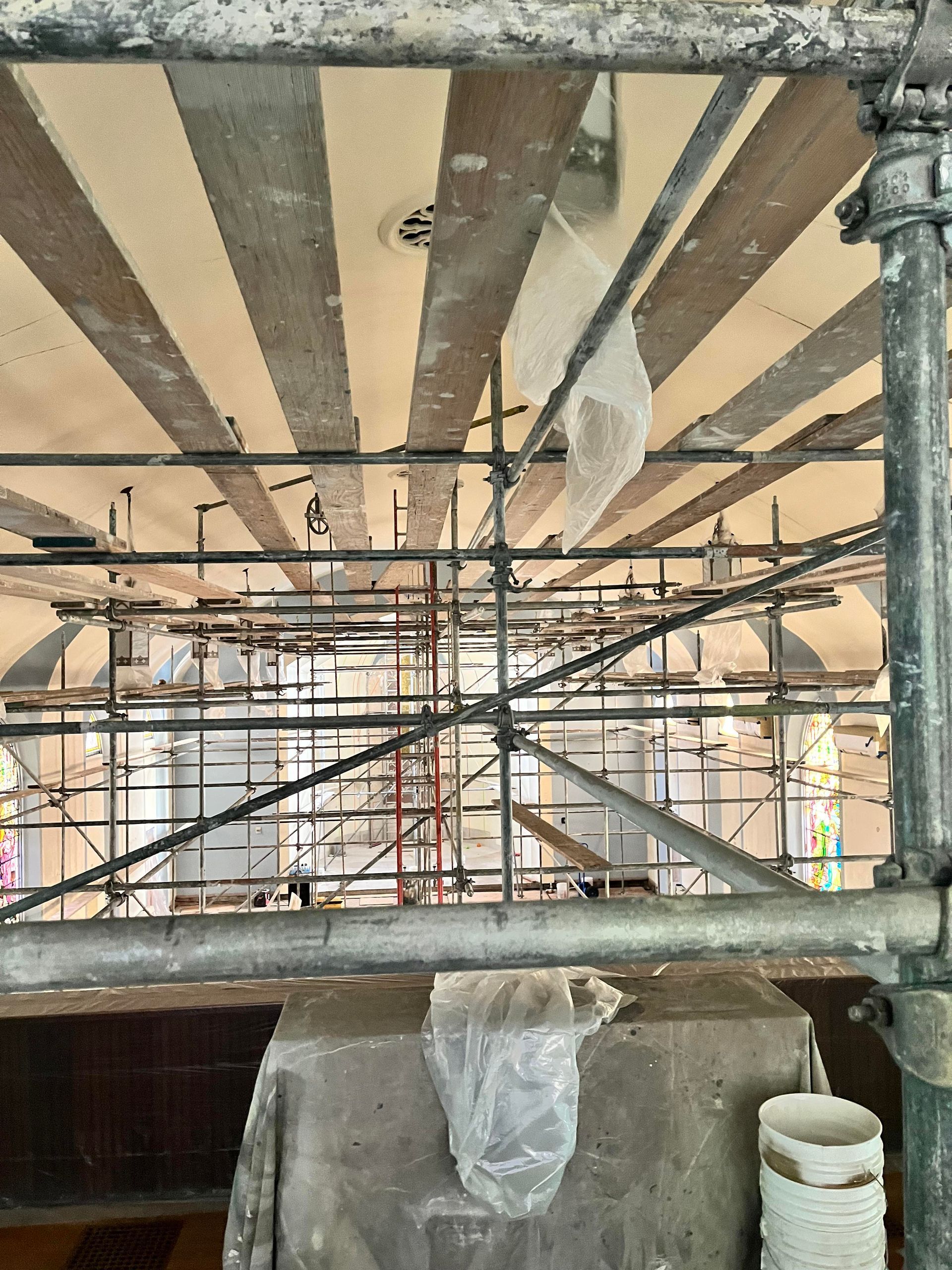

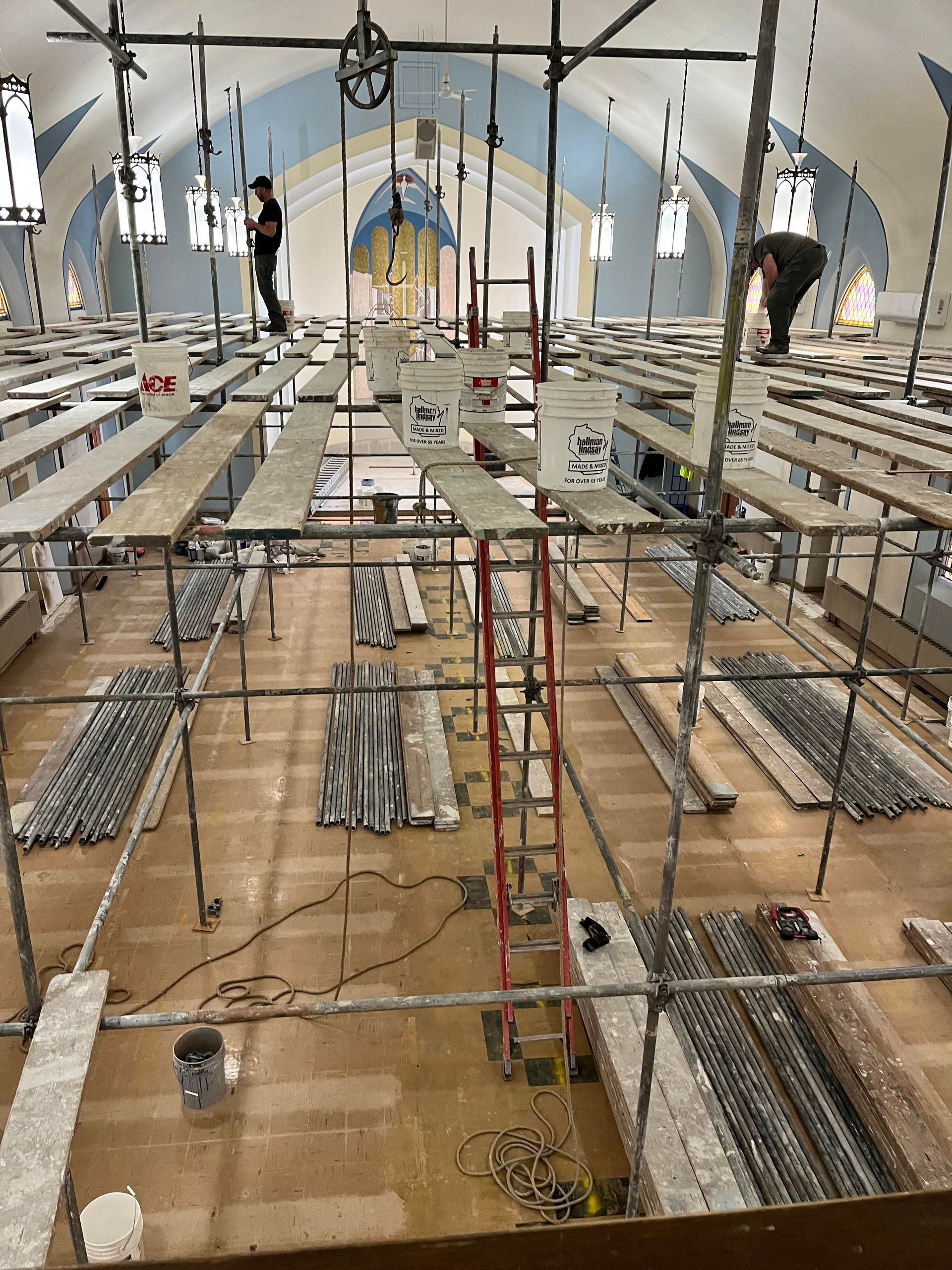

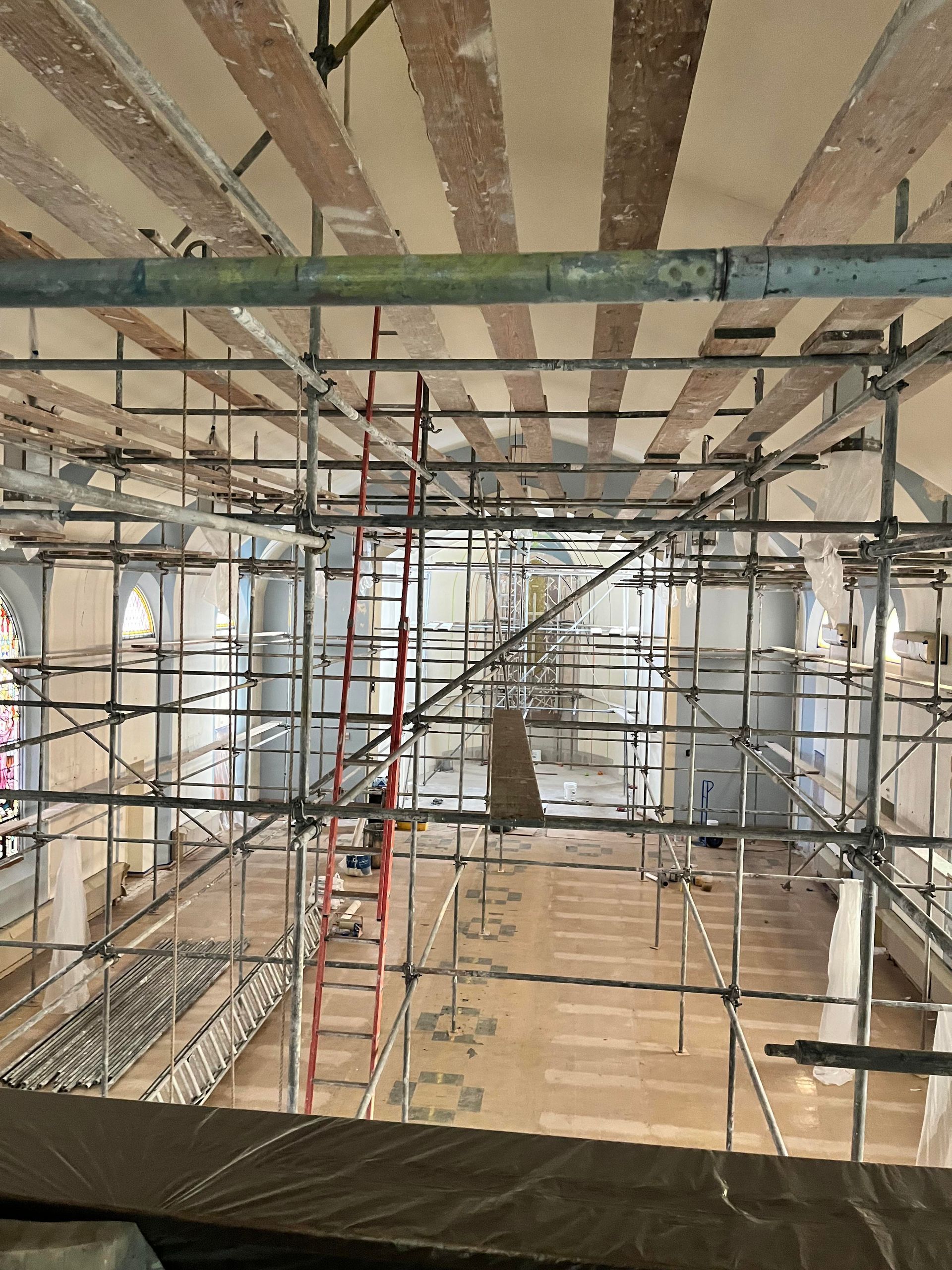

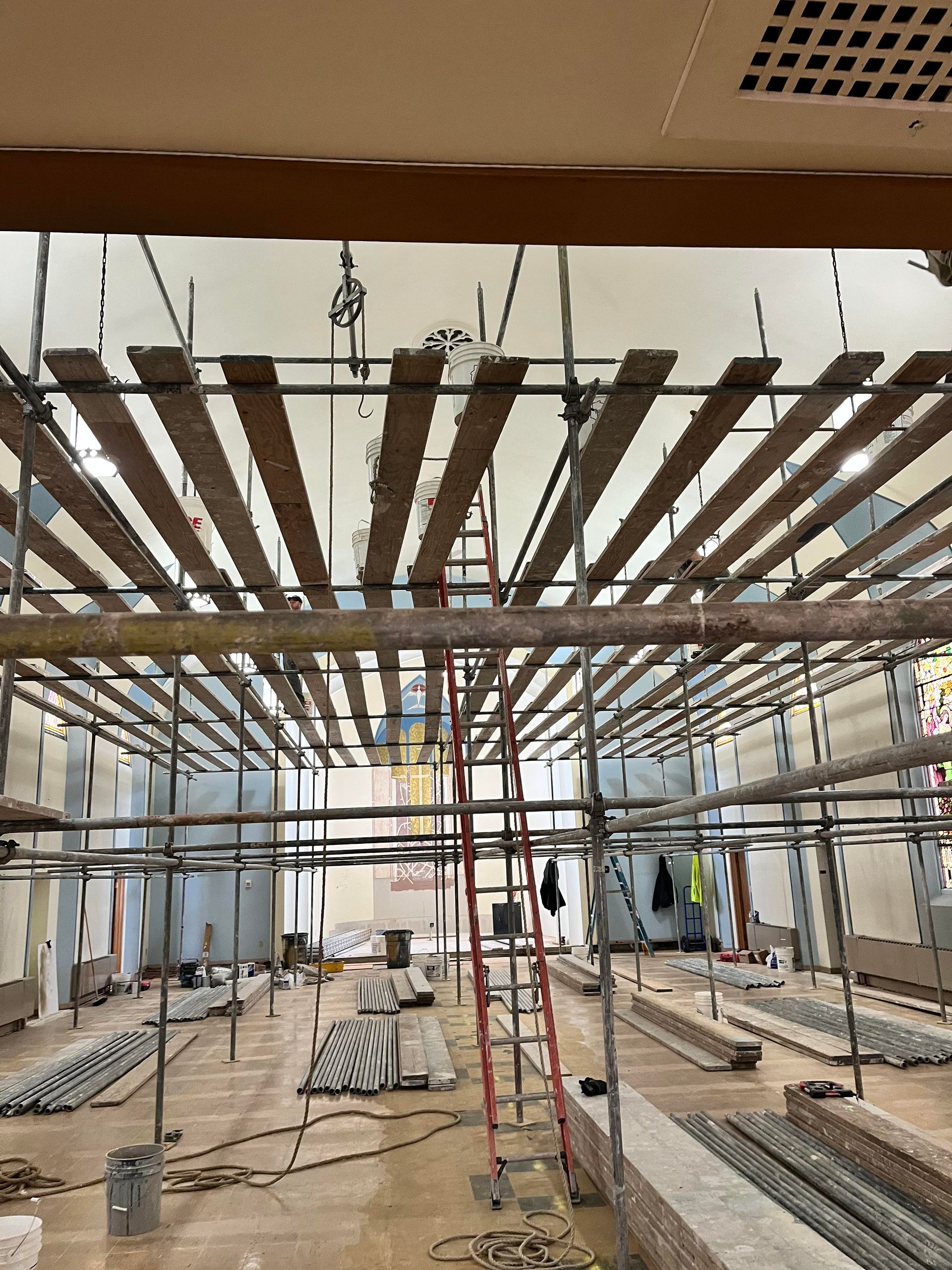

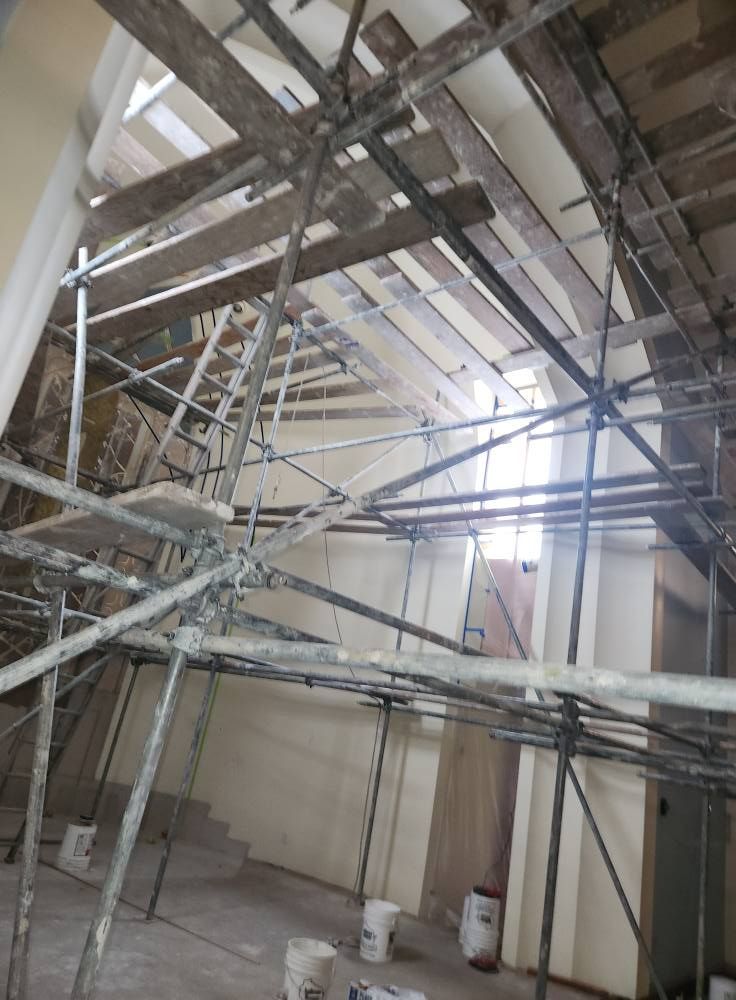

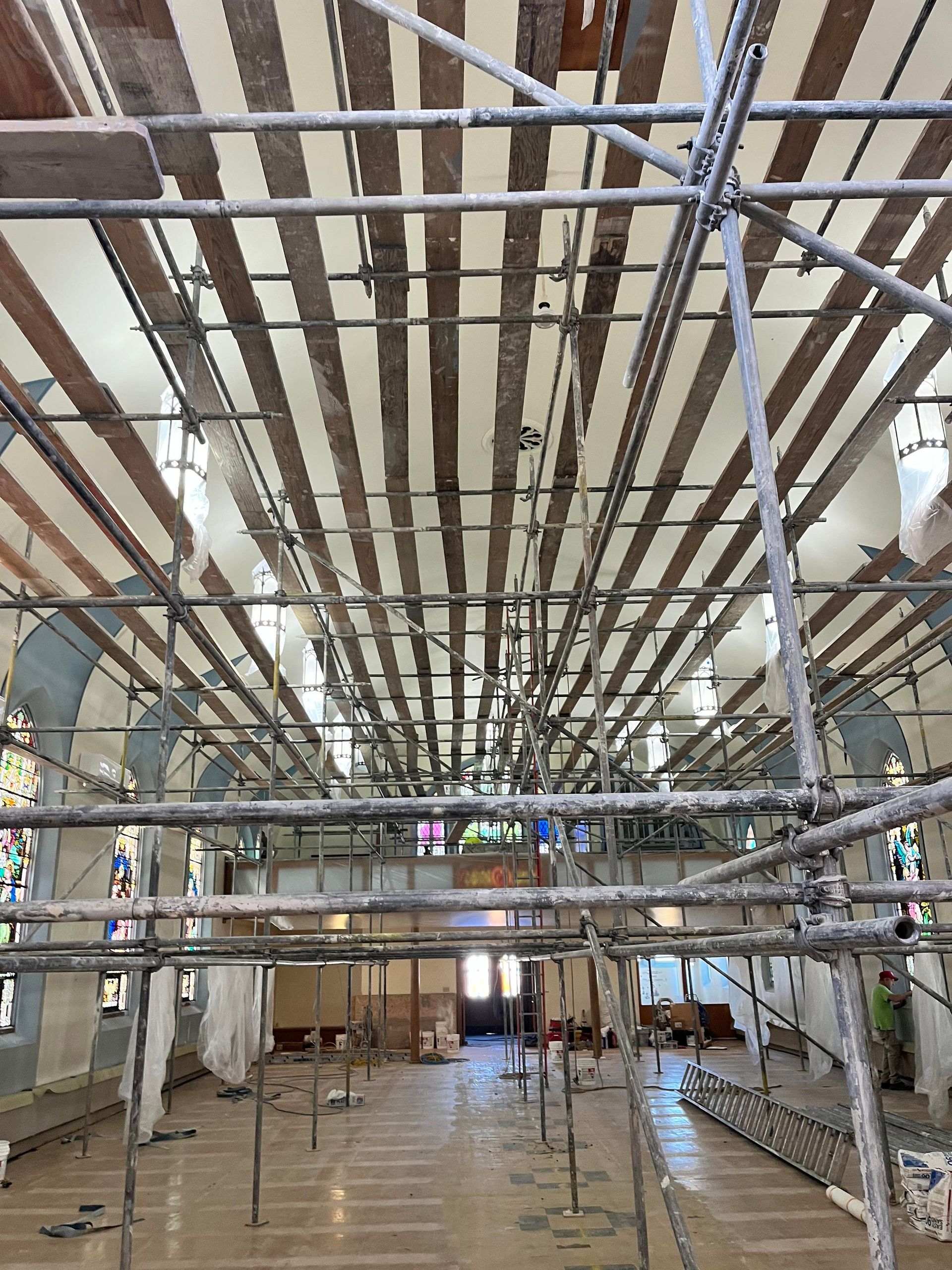

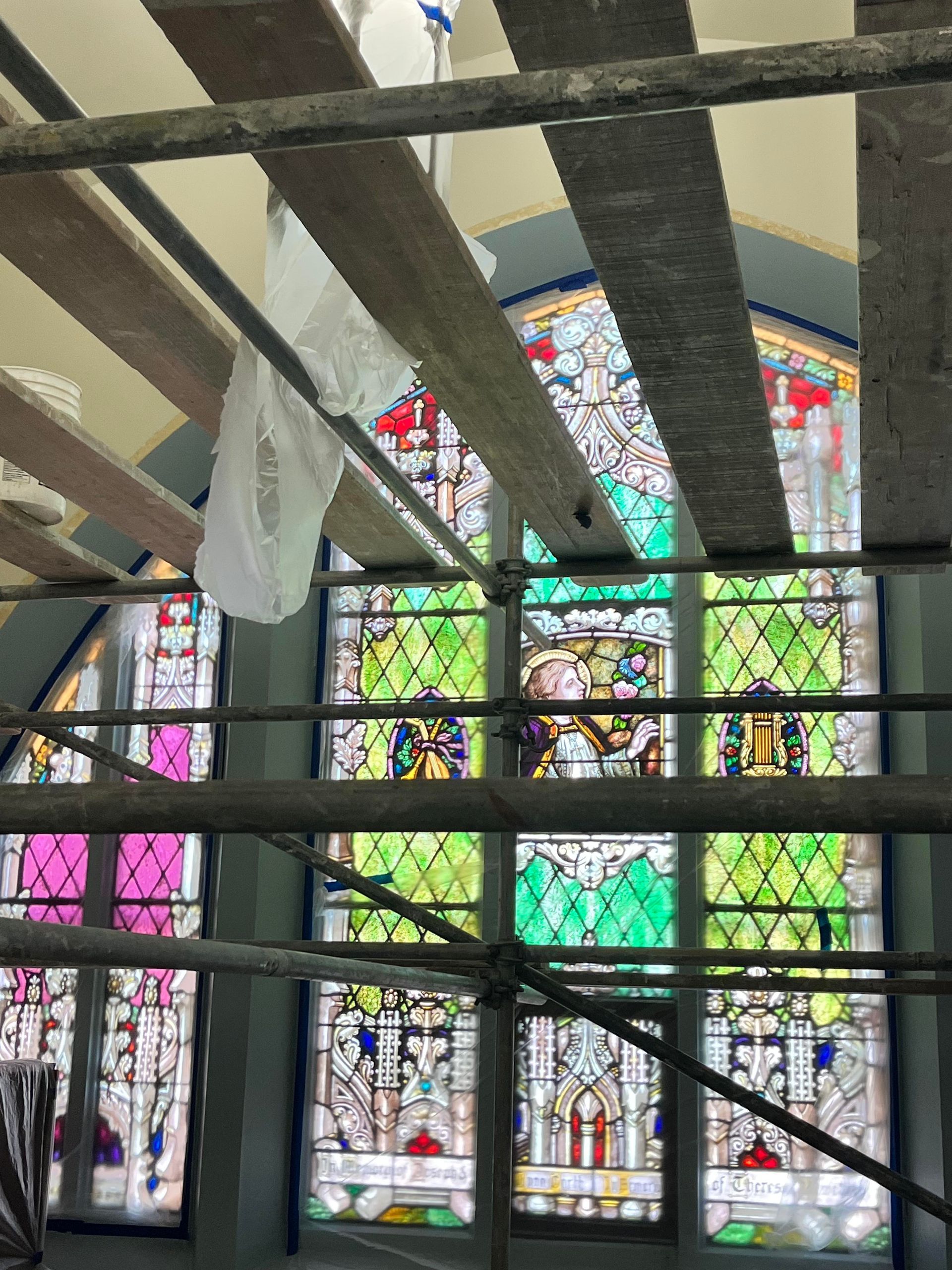

Riehle Decorating set up the scaffolding  - Dec. 2-5, 2025

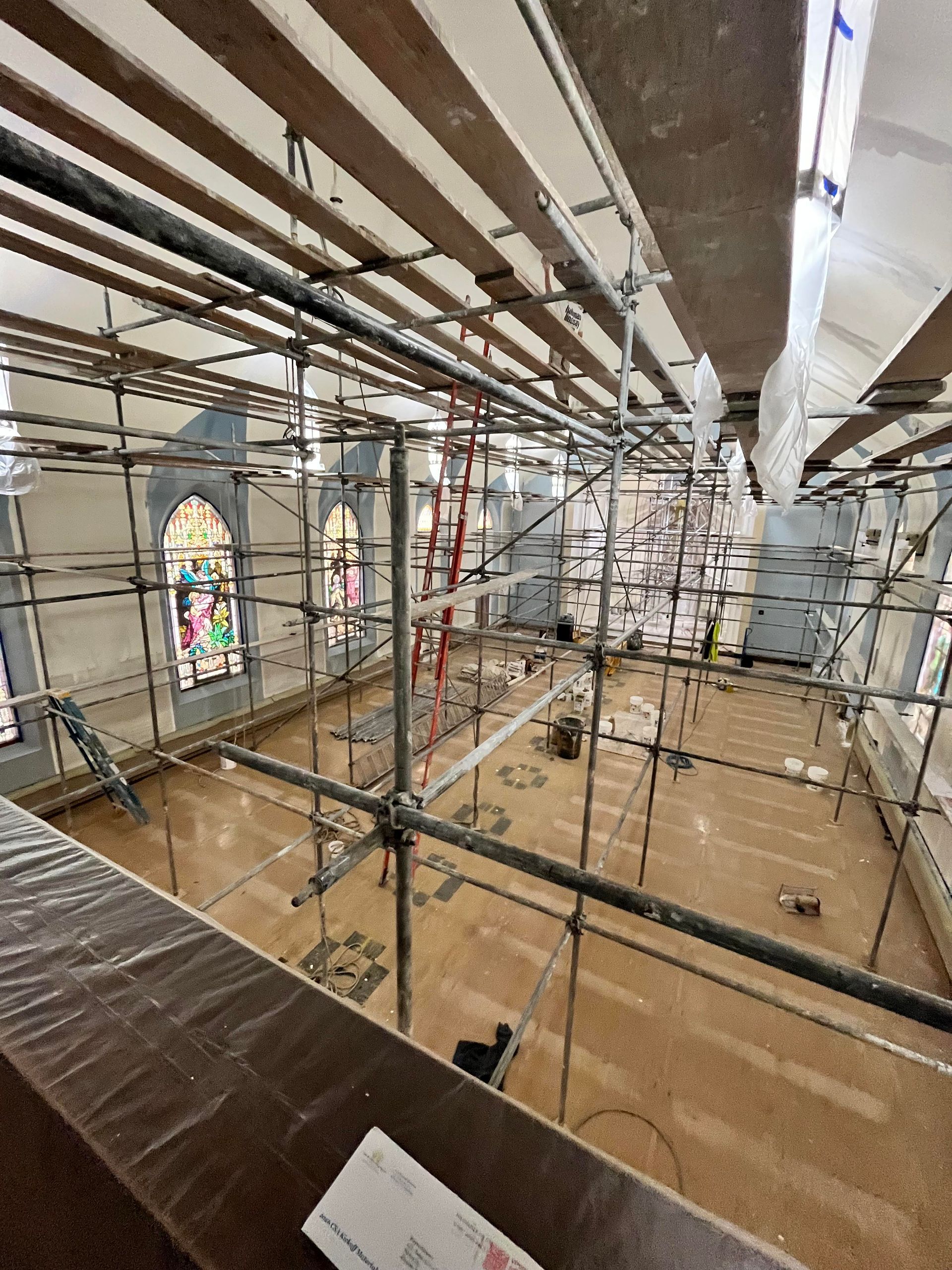

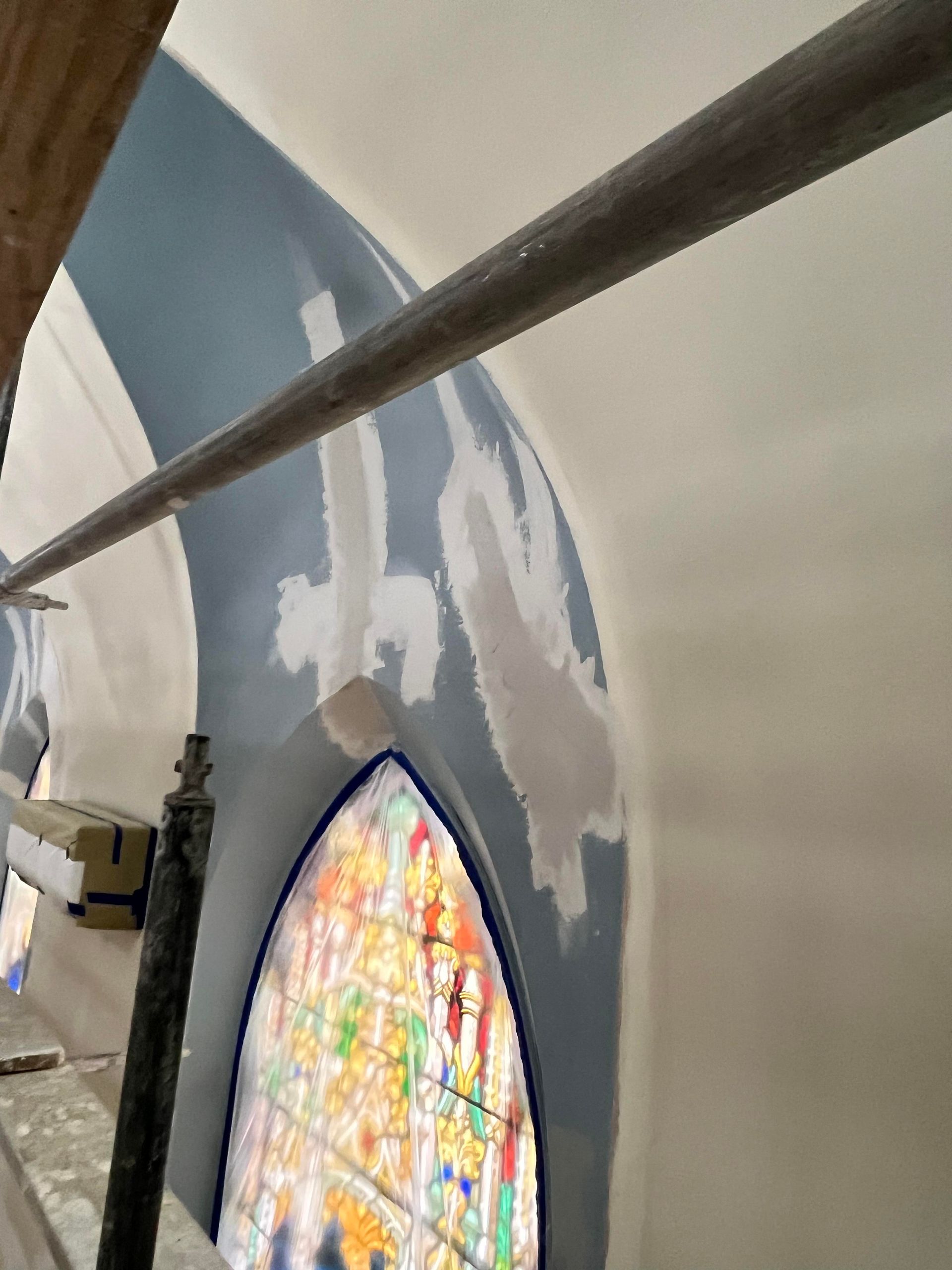

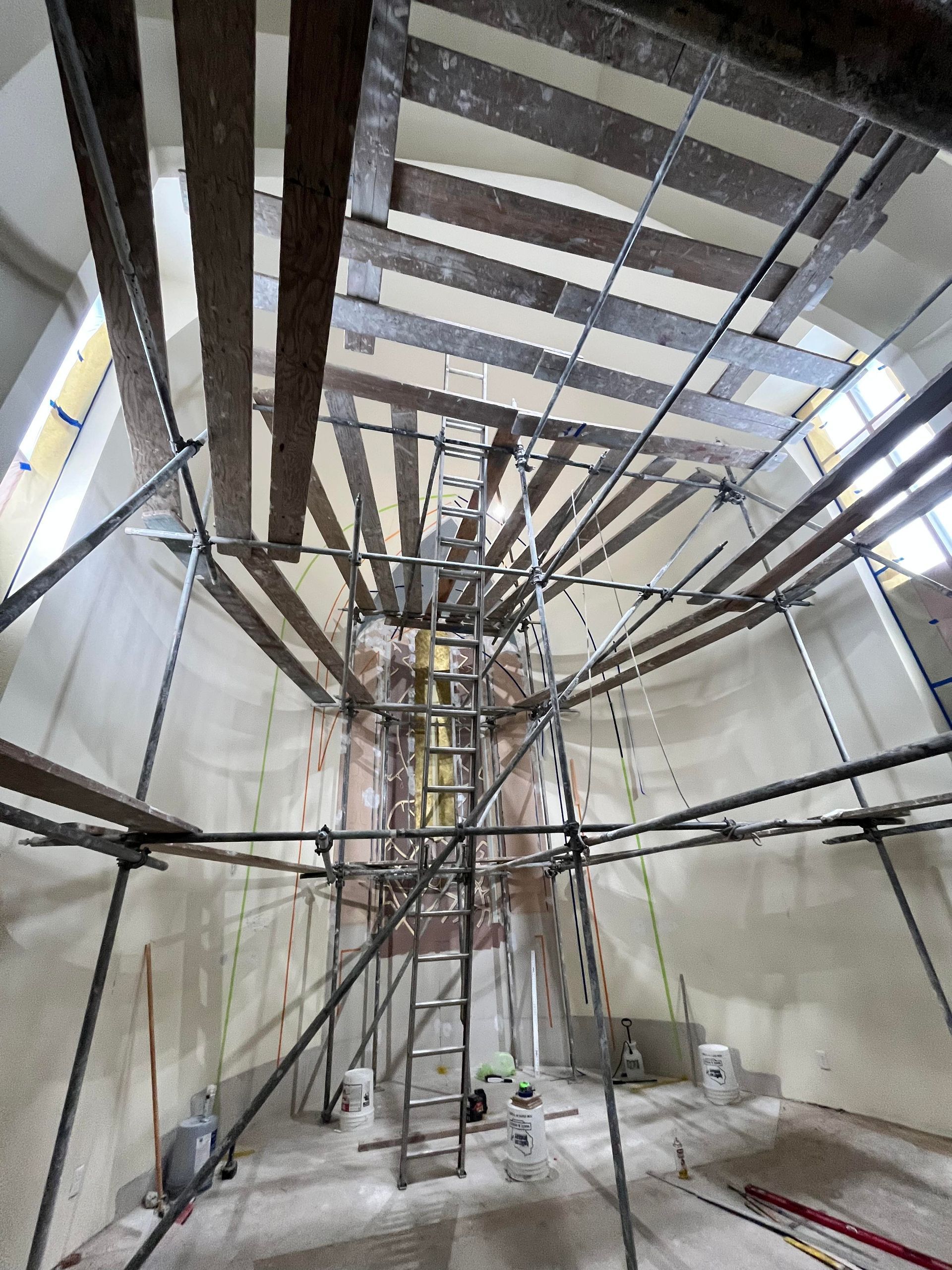

Repairing loose plaster and loose paint - Dec. 9, 2025

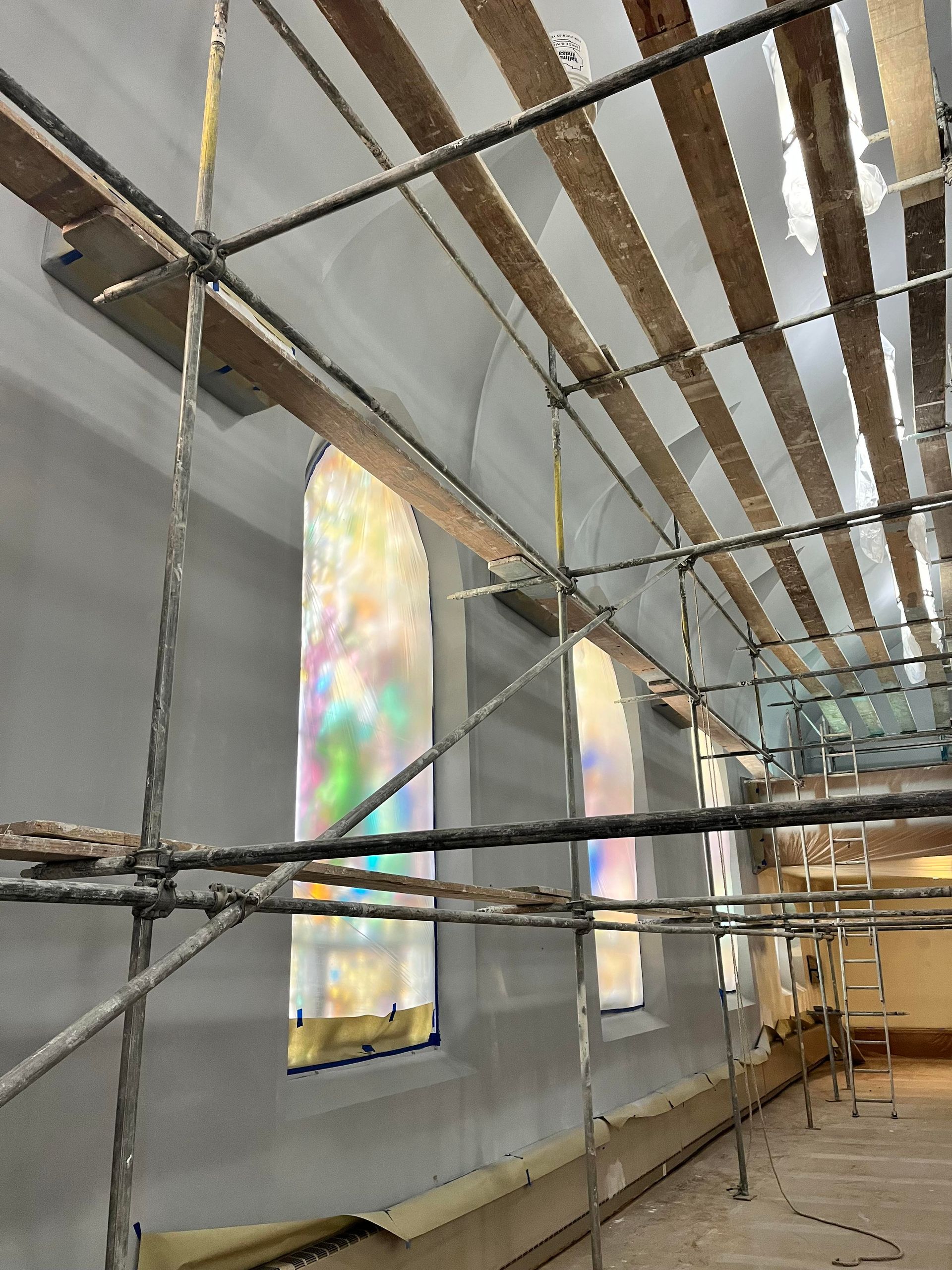

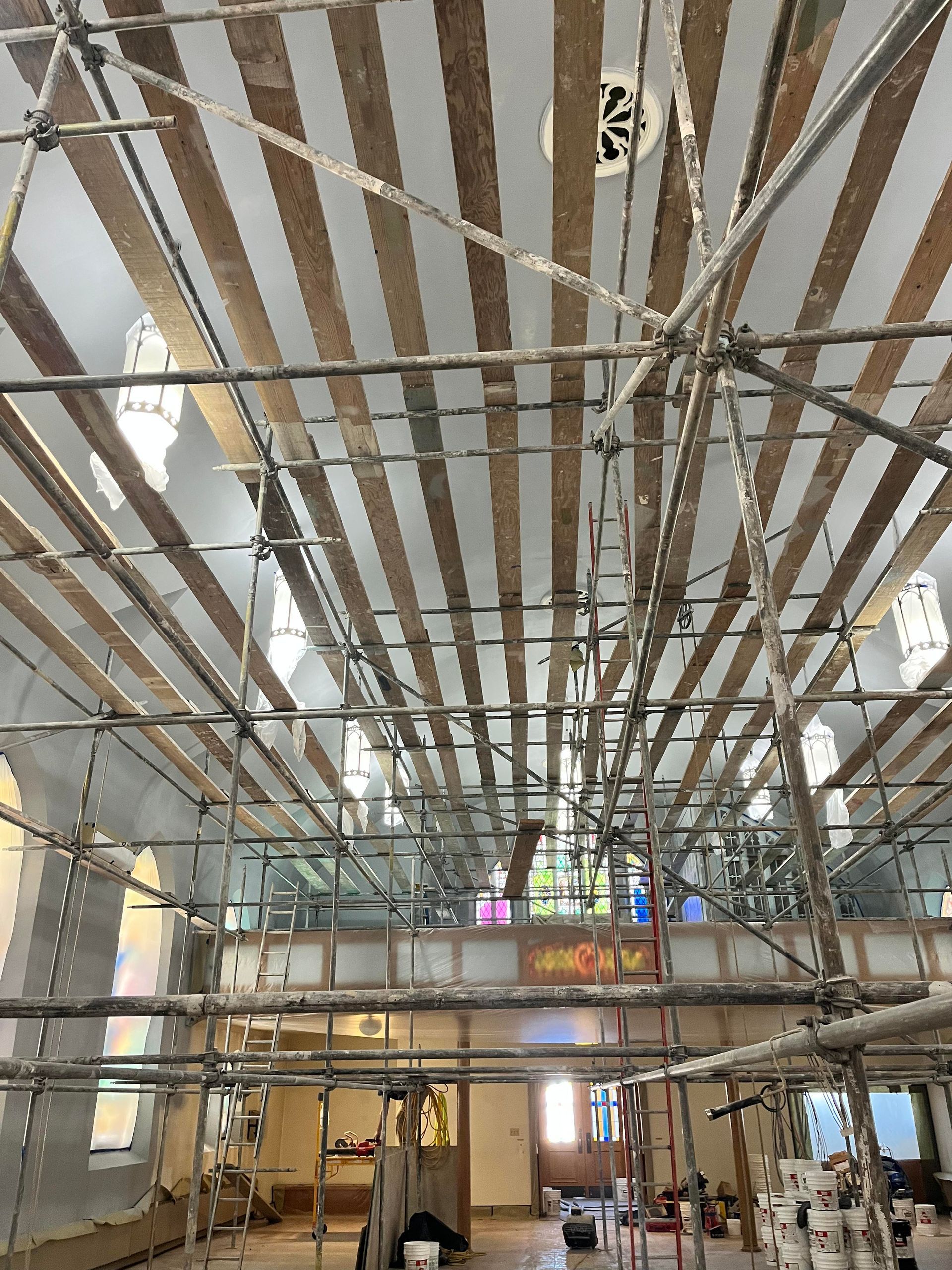

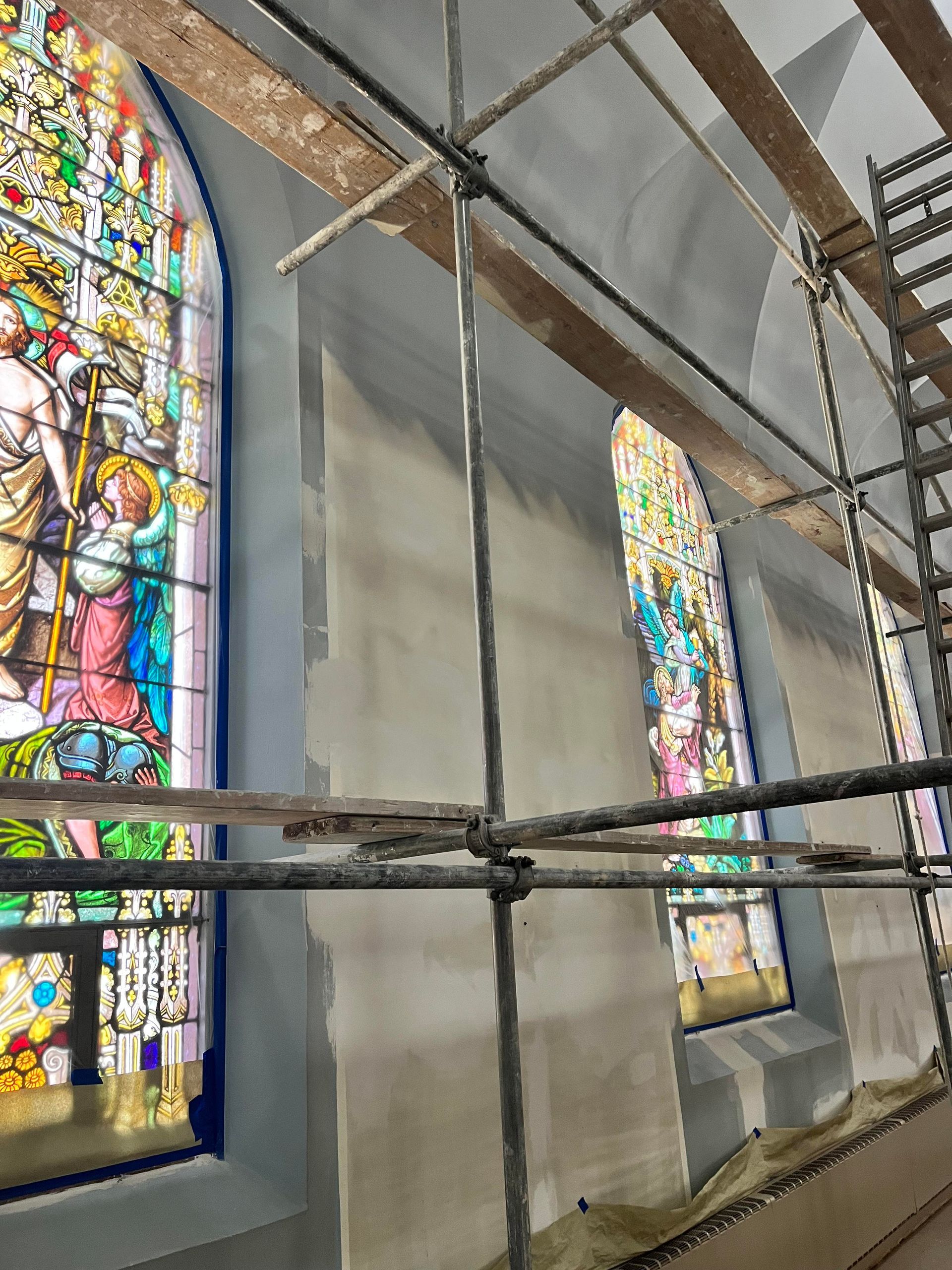

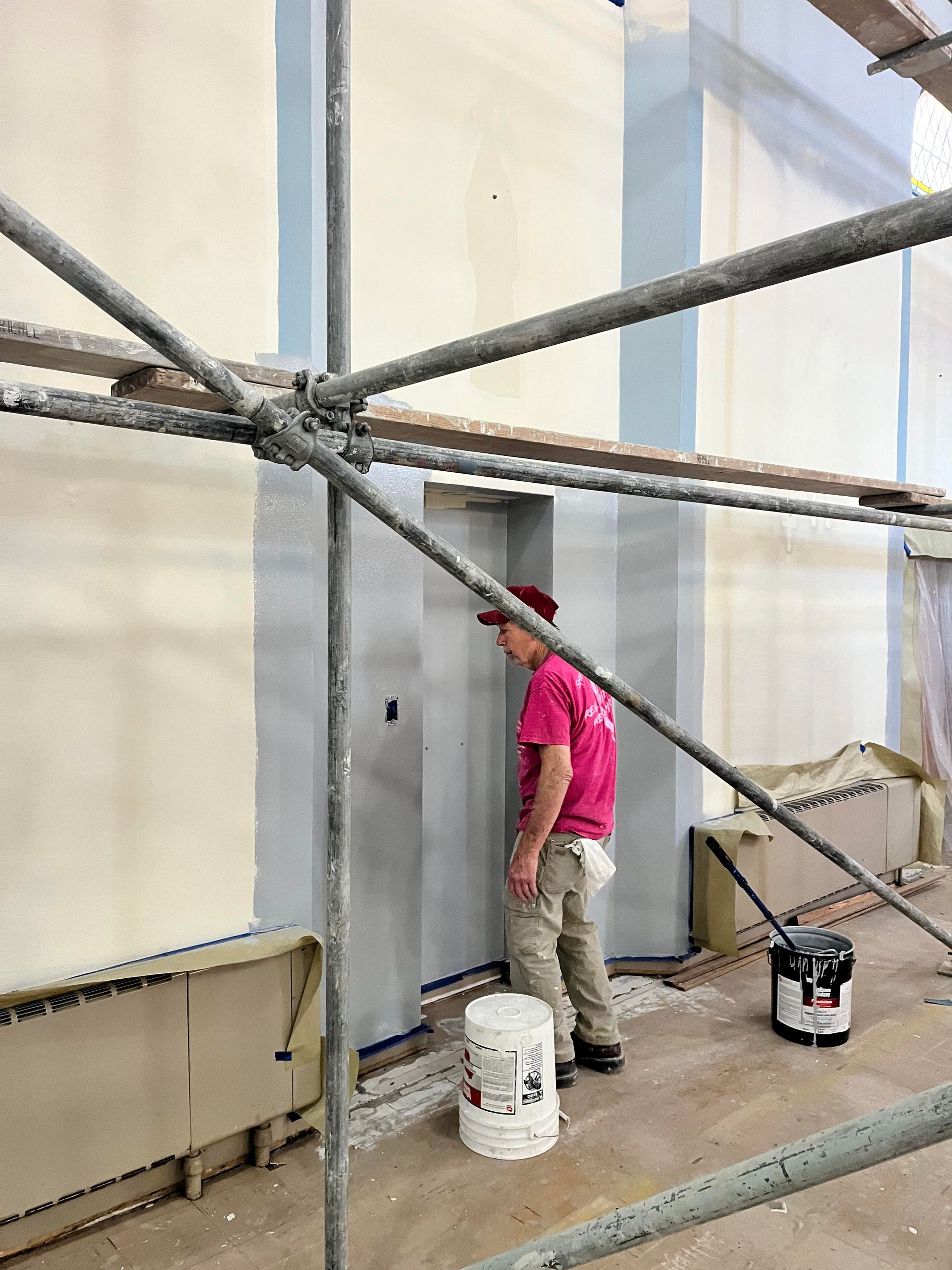

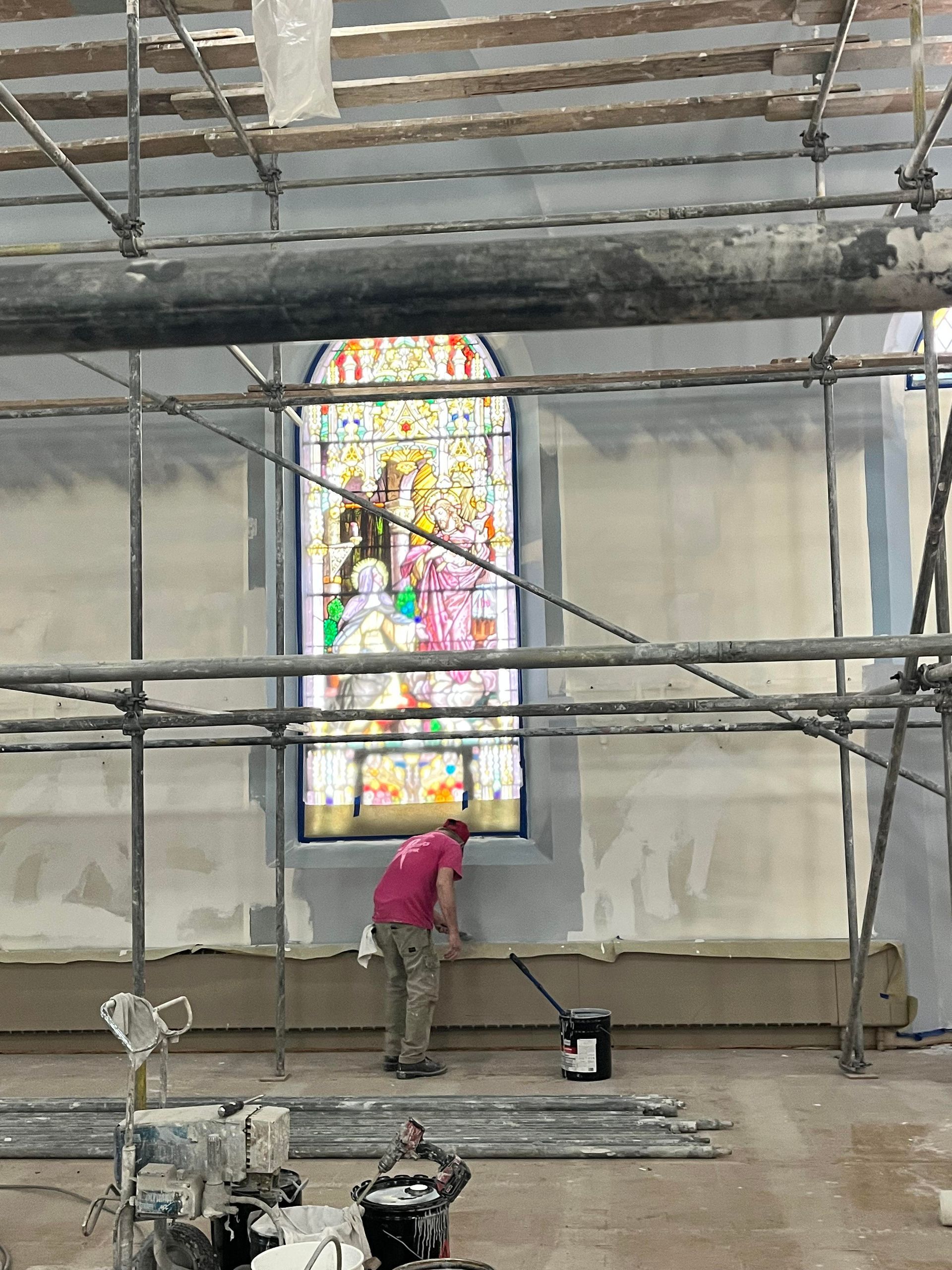

Applying an oil base seal coat to walls and ceiling - Dec. 11, 2025

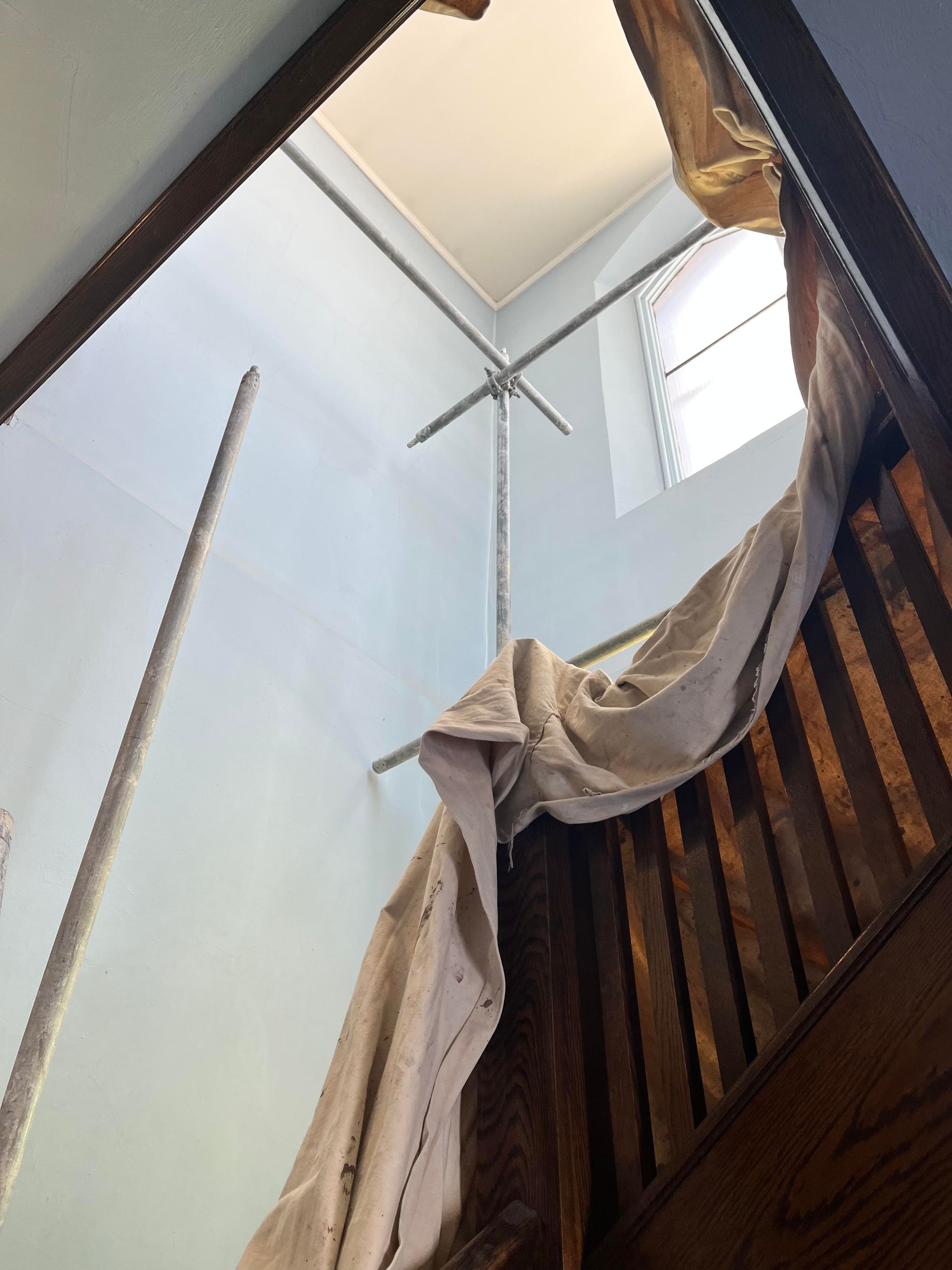

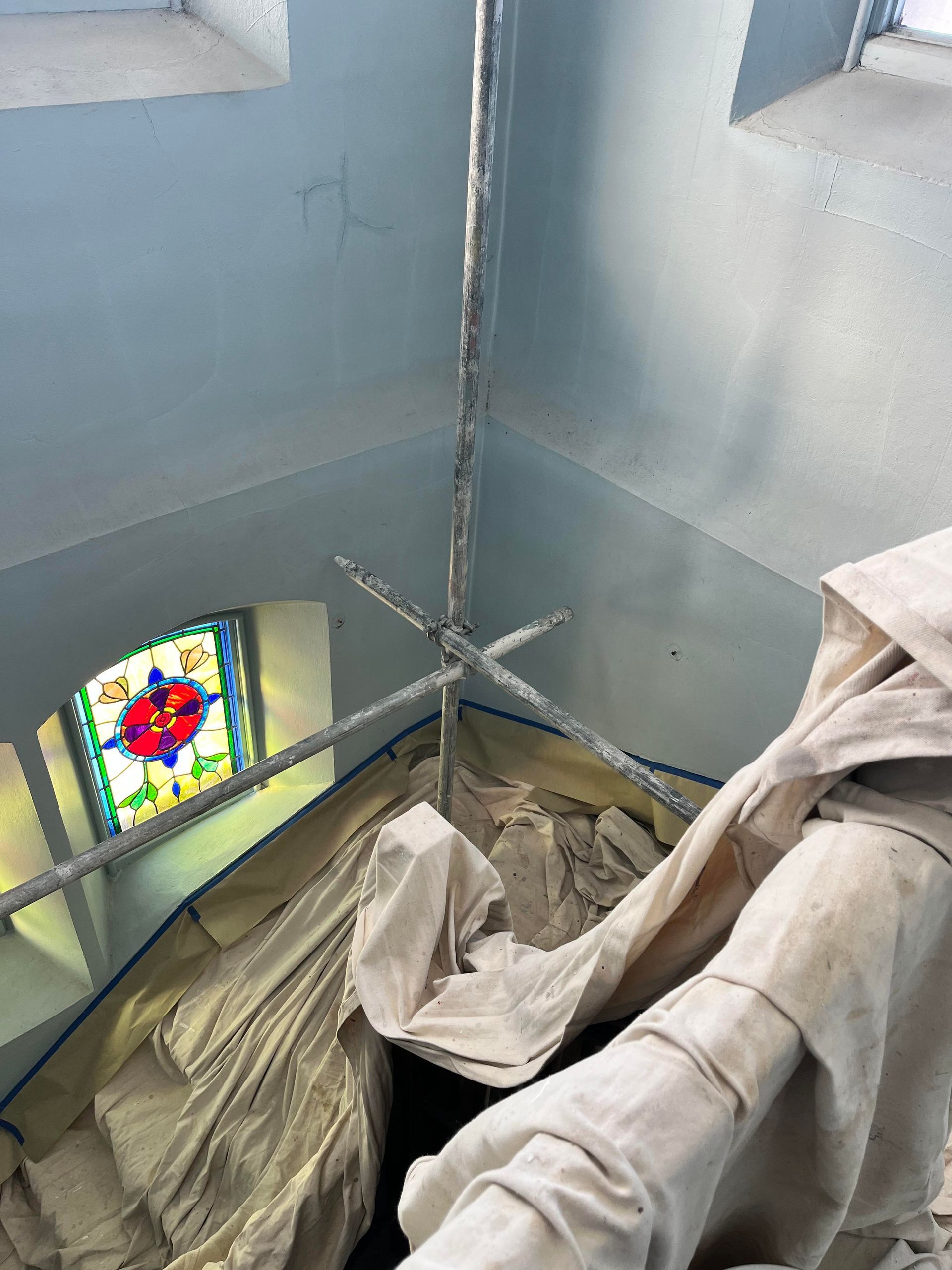

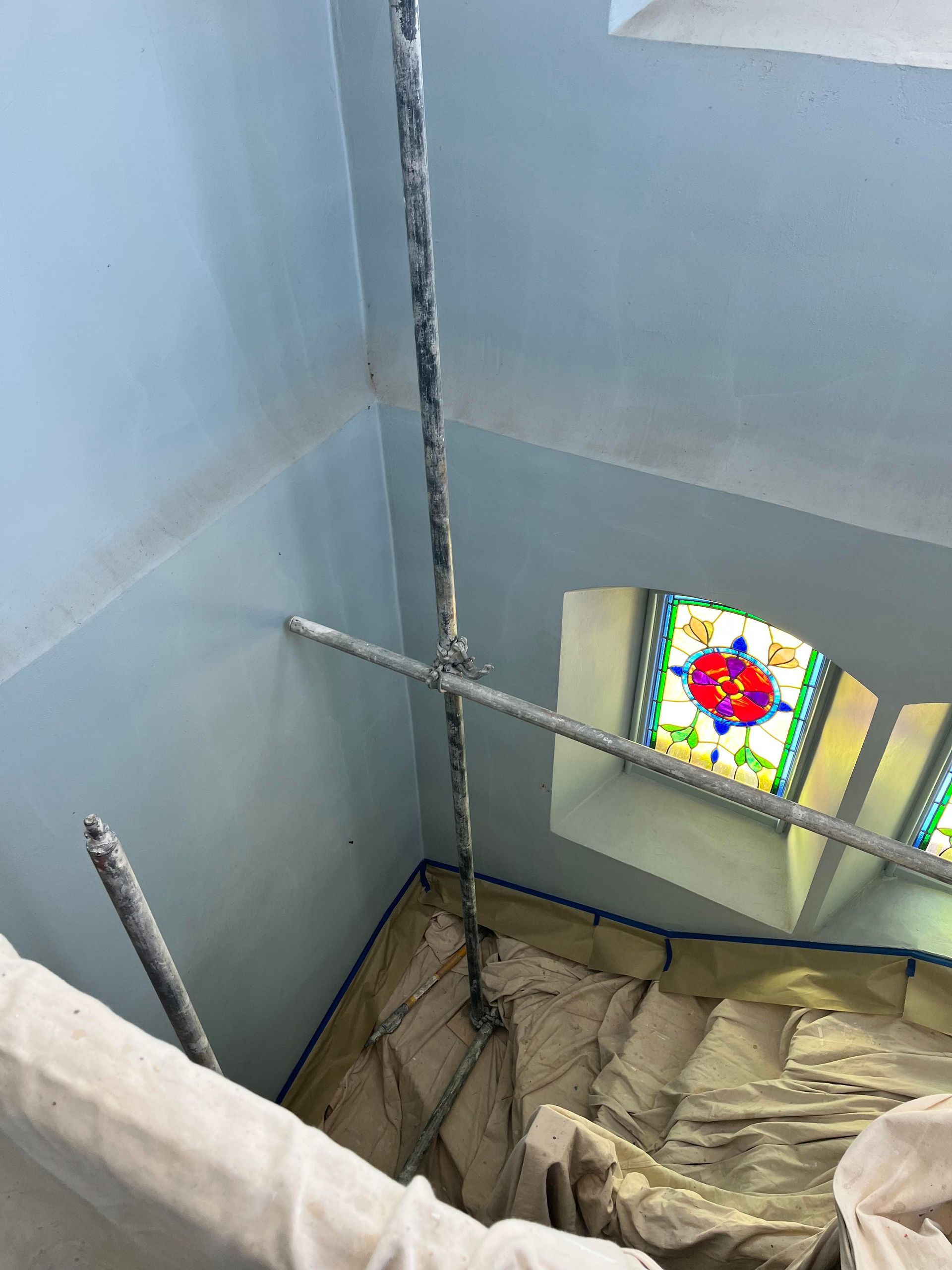

Scaffolding in the stairwell of the bell tower - Dec. 11, 2025

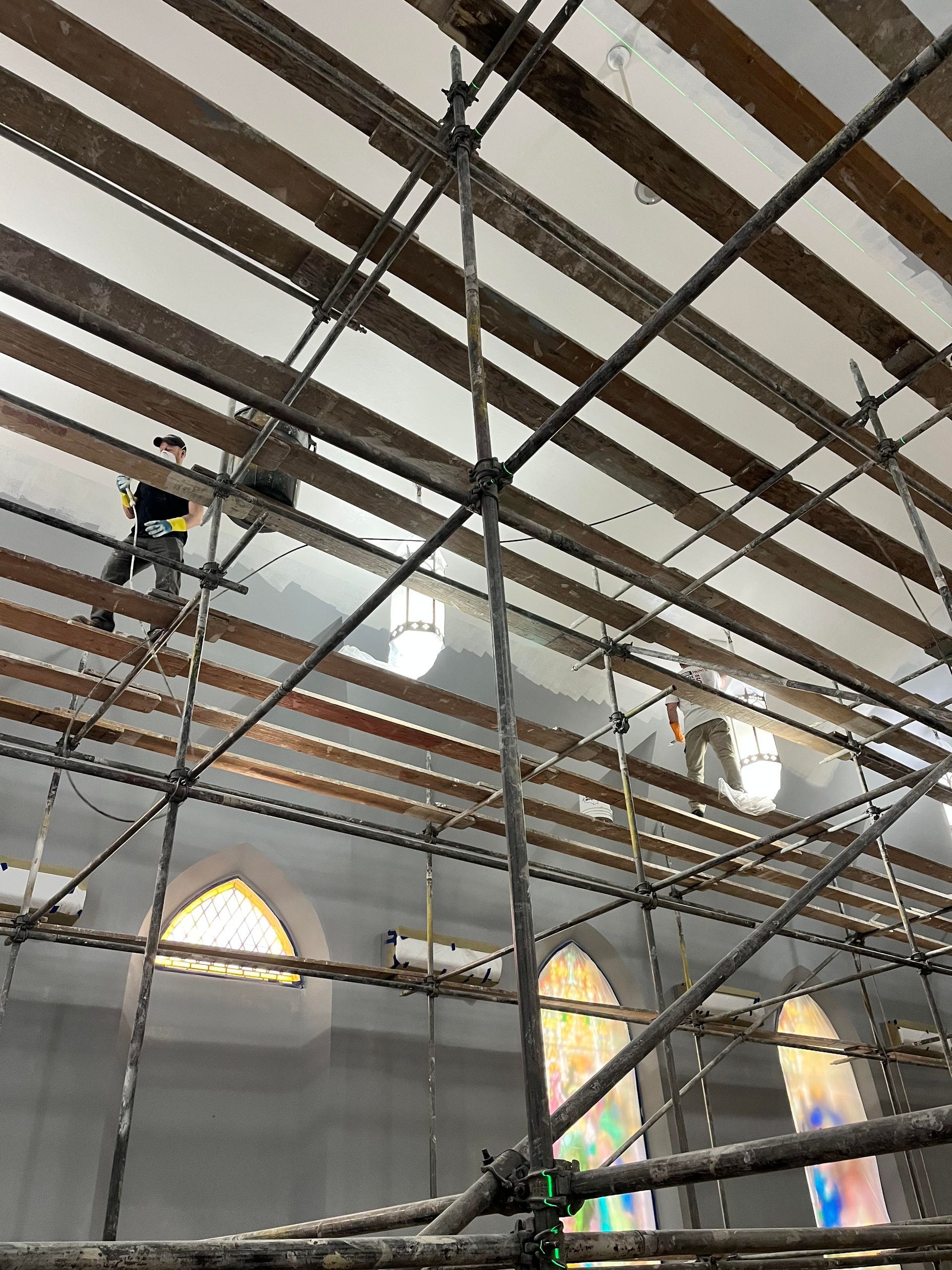

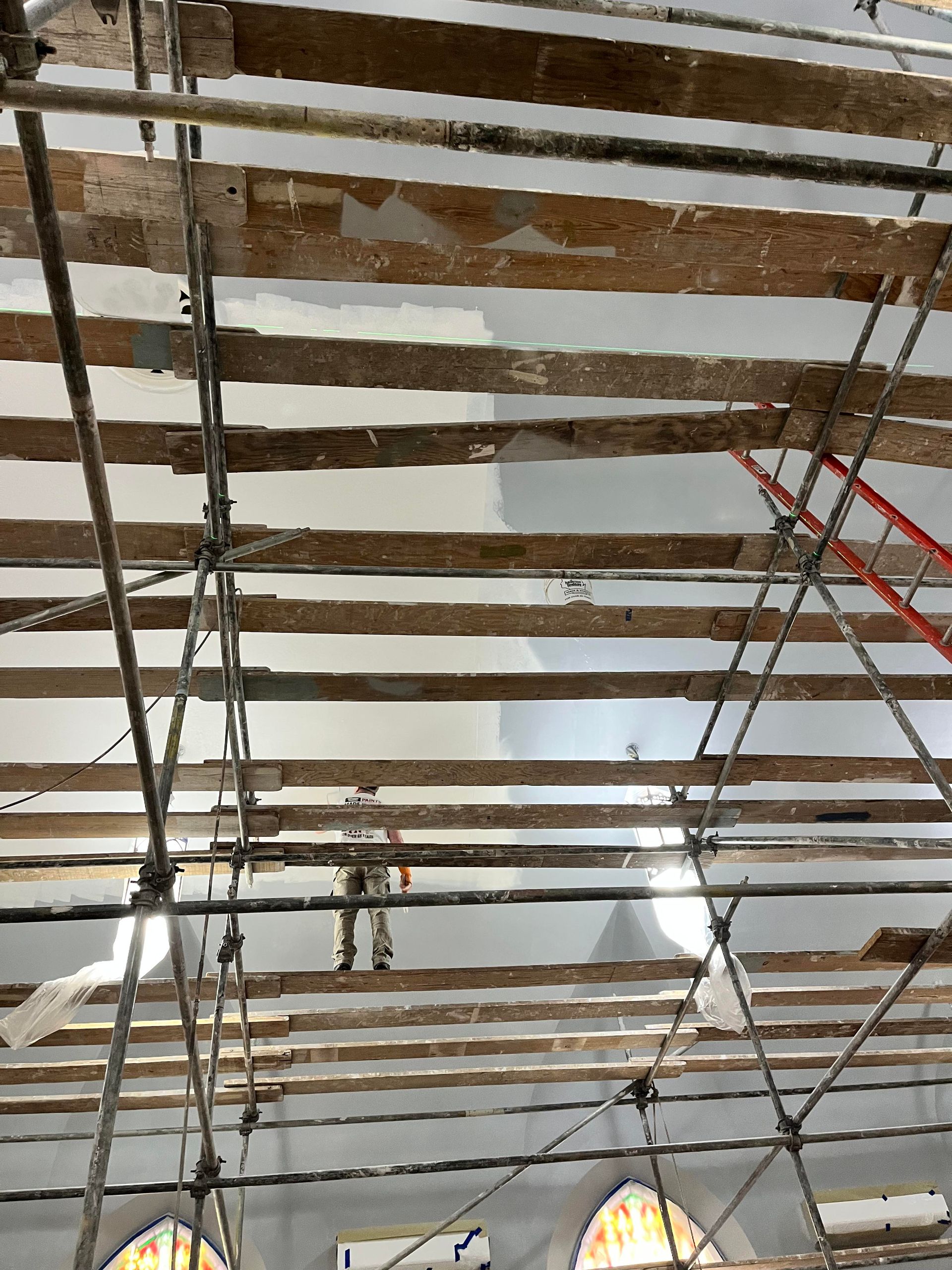

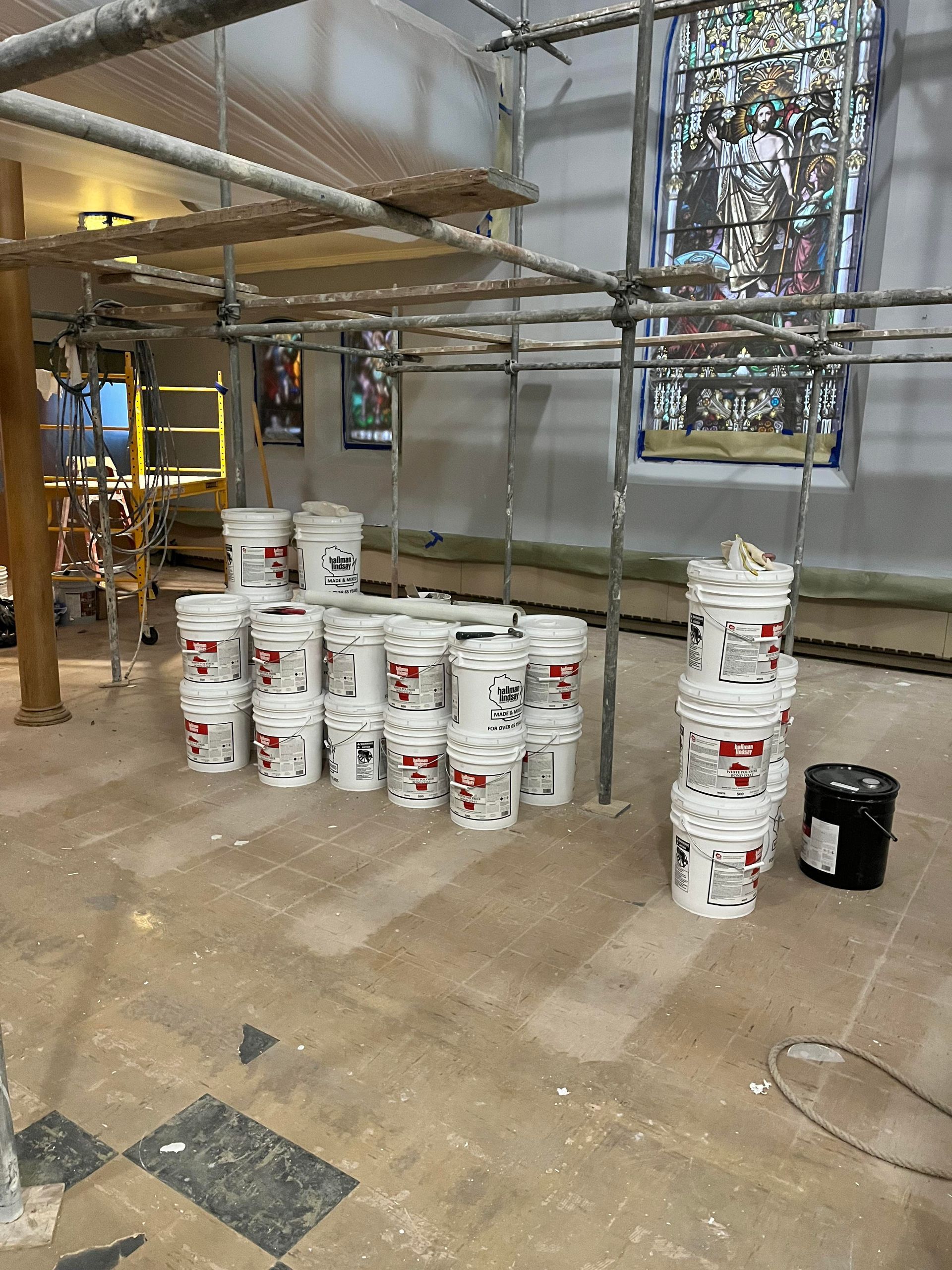

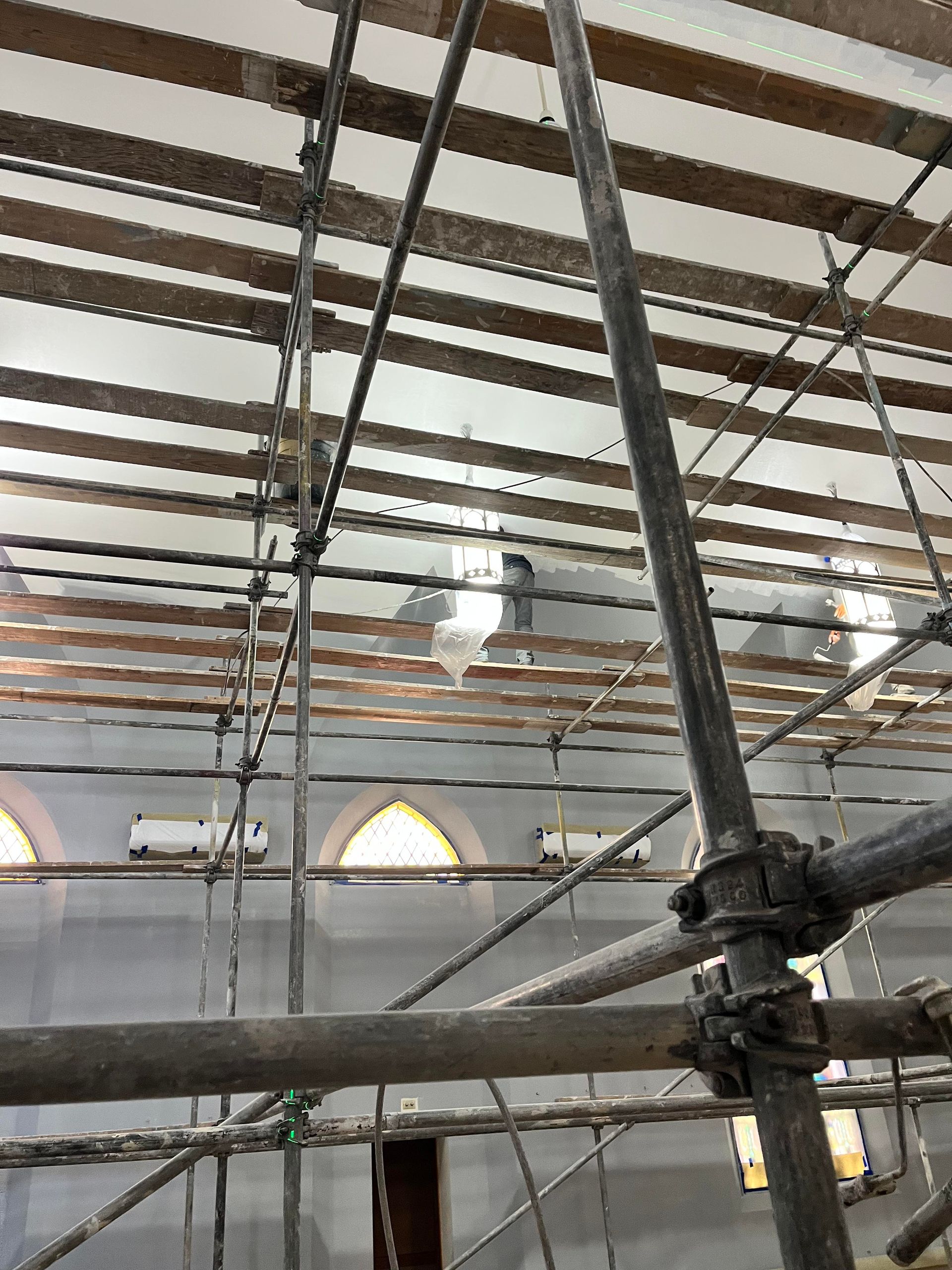

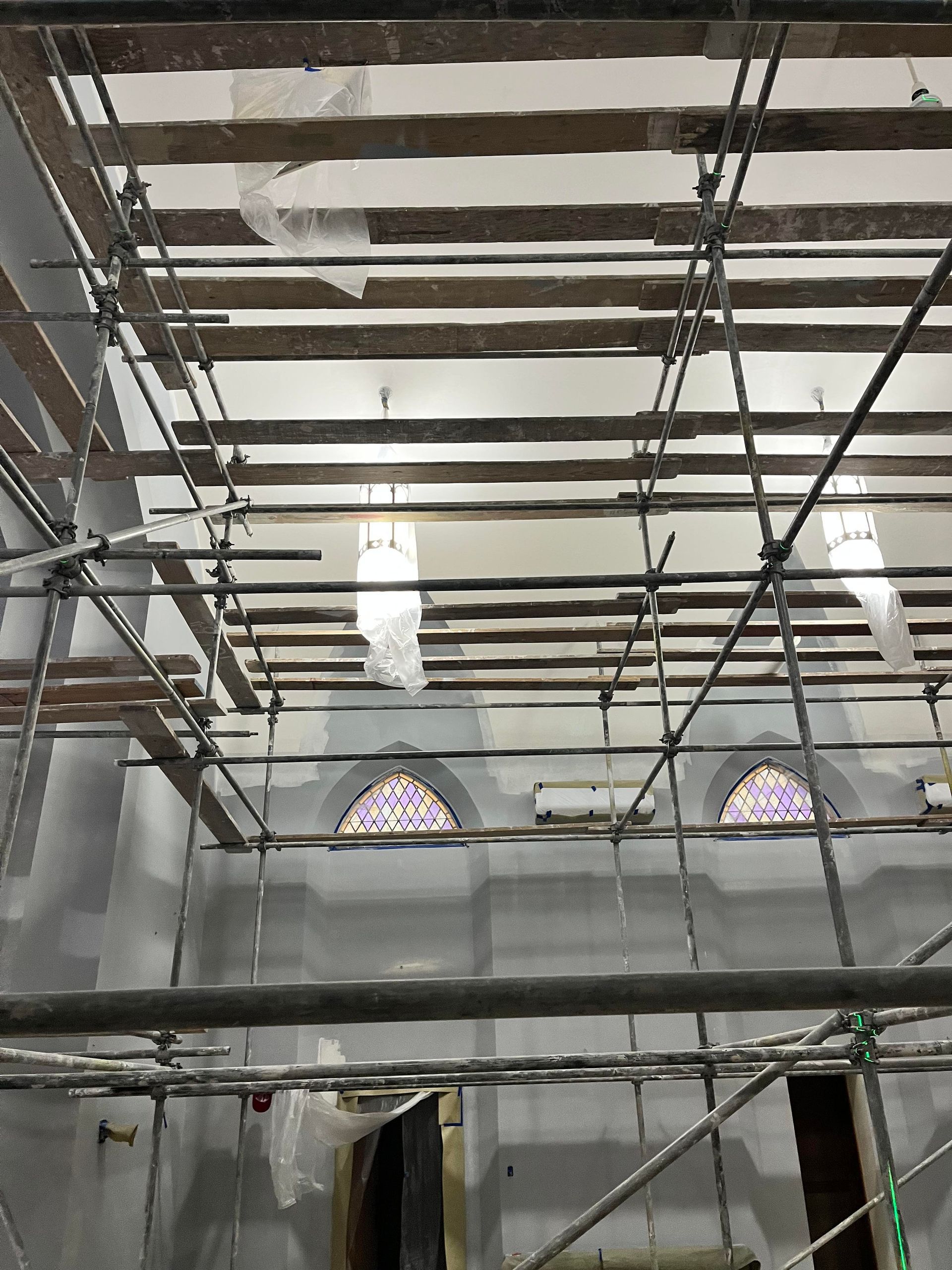

Applying glue and fiberglass to the ceiling - Dec. 15, 2025

Over 35 5-gallon pails of glue will be applied to the ceiling and walls. Sheets of fiberglass material will be applied over the glue.

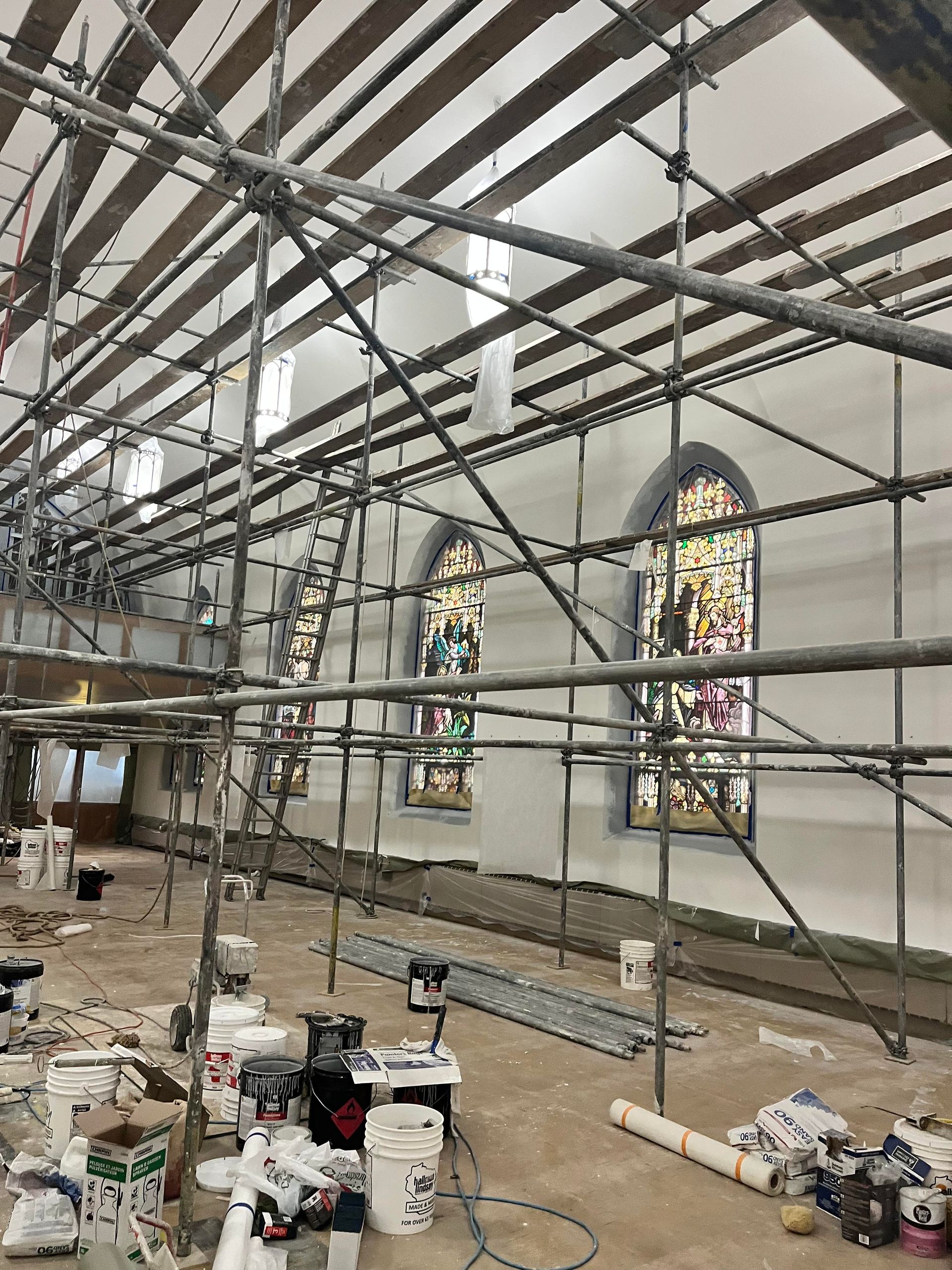

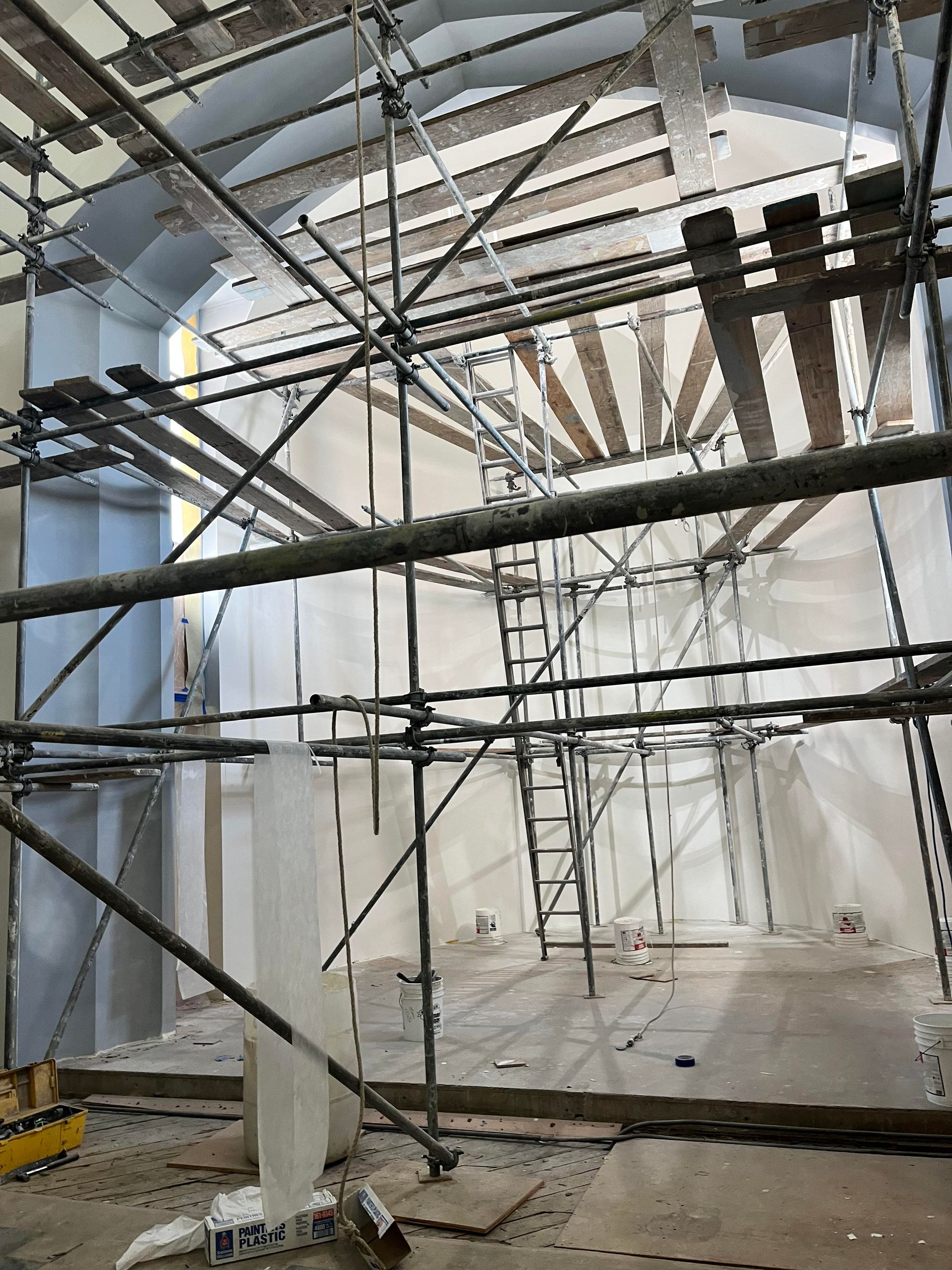

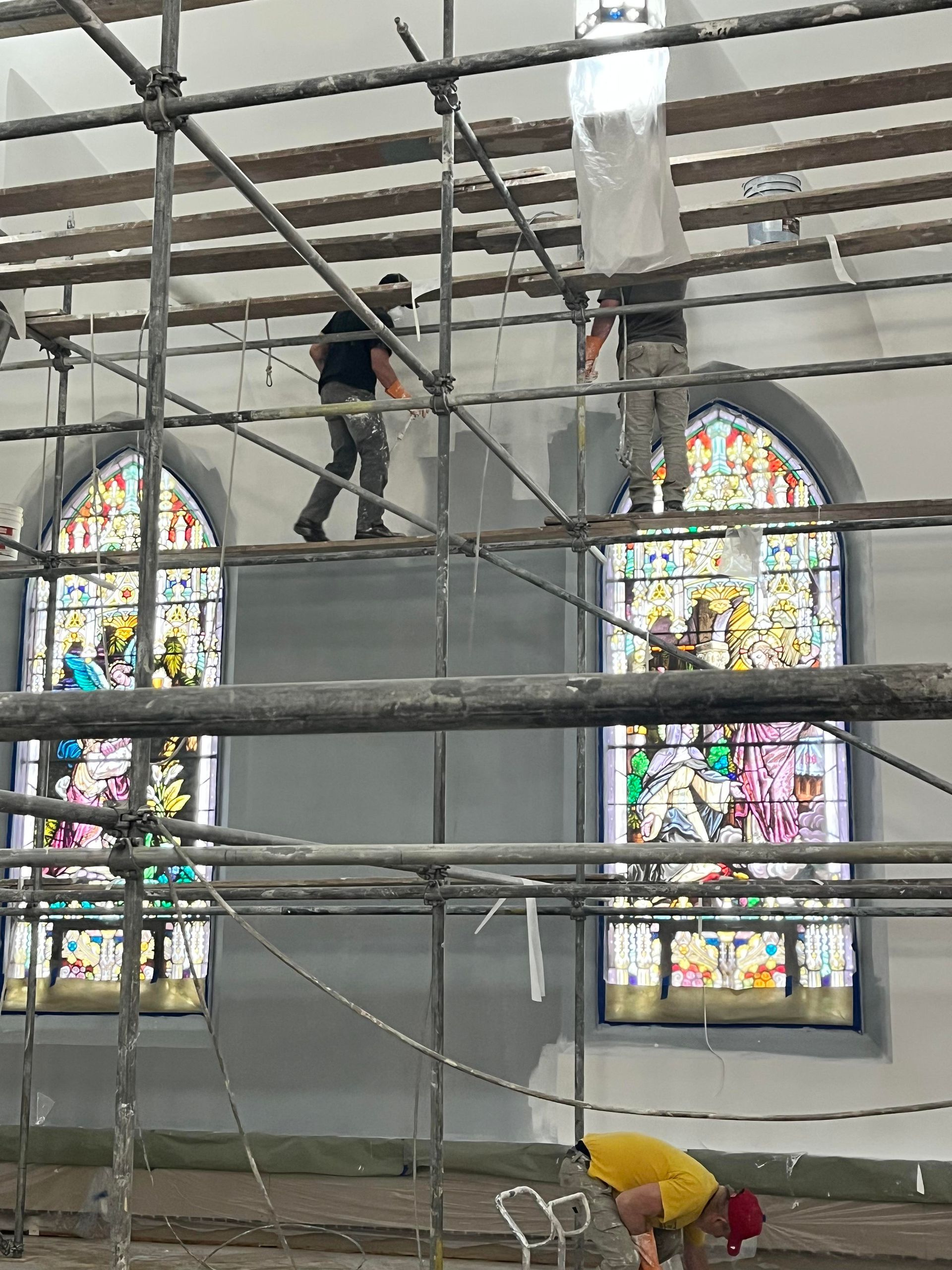

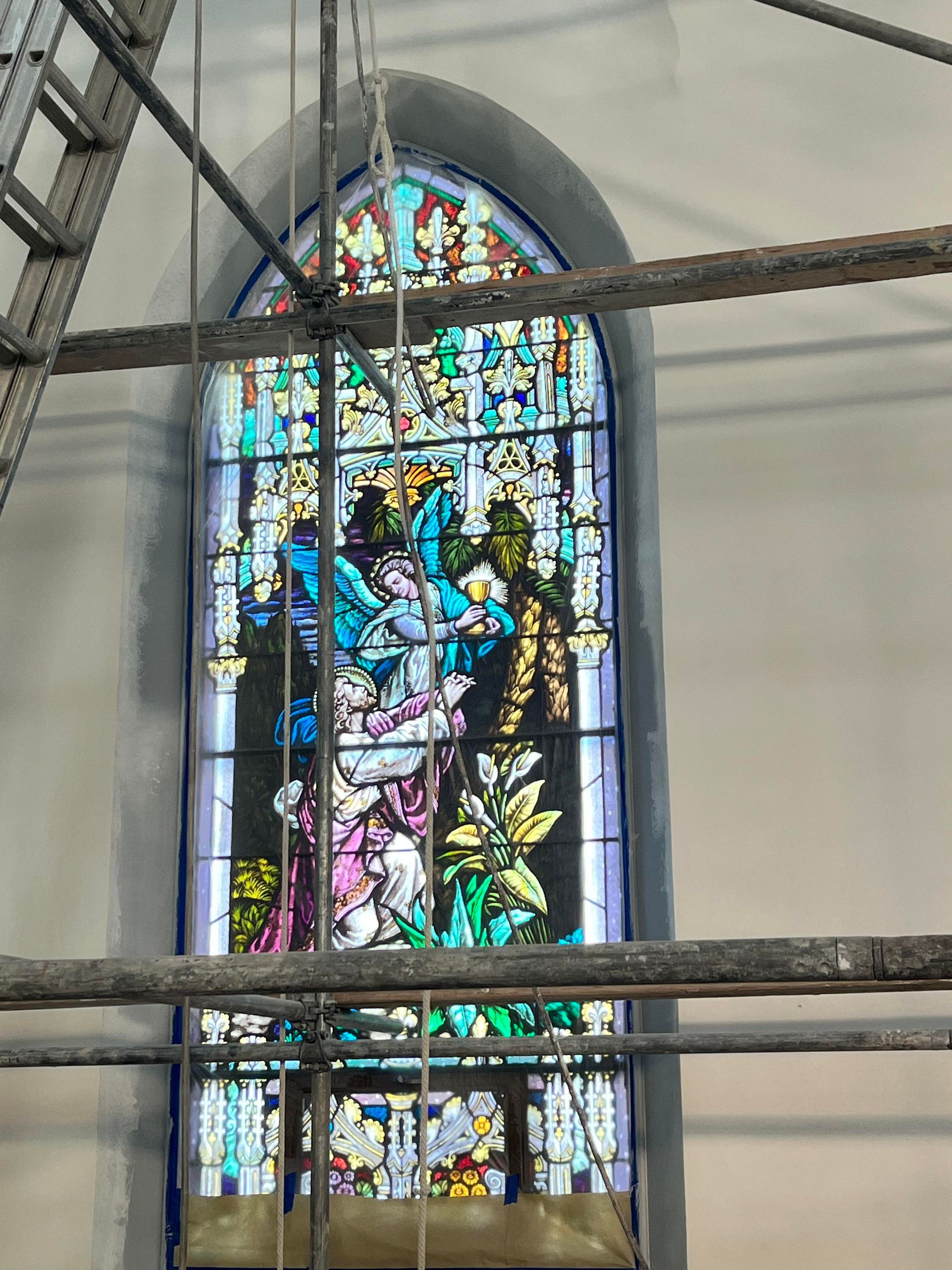

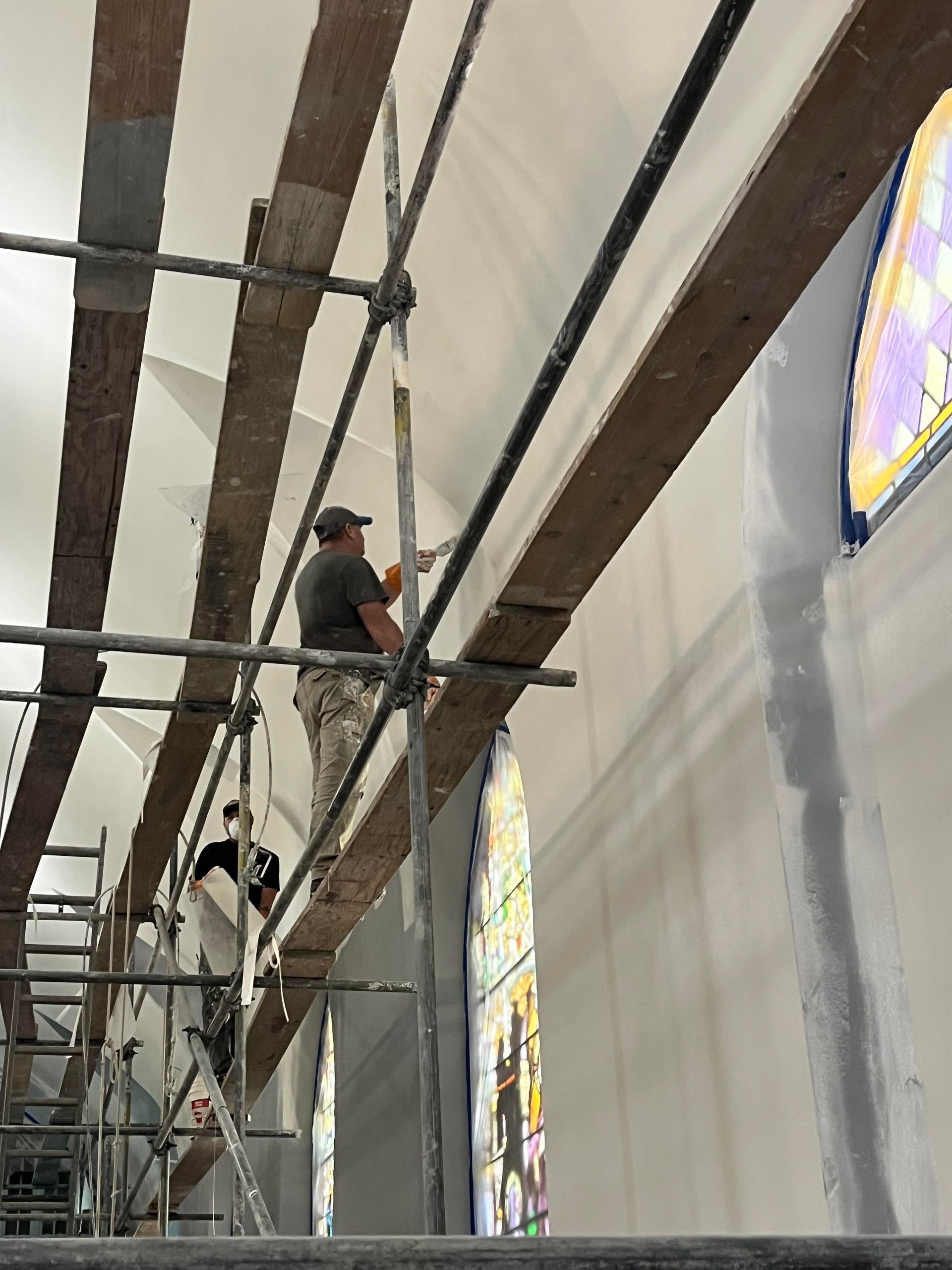

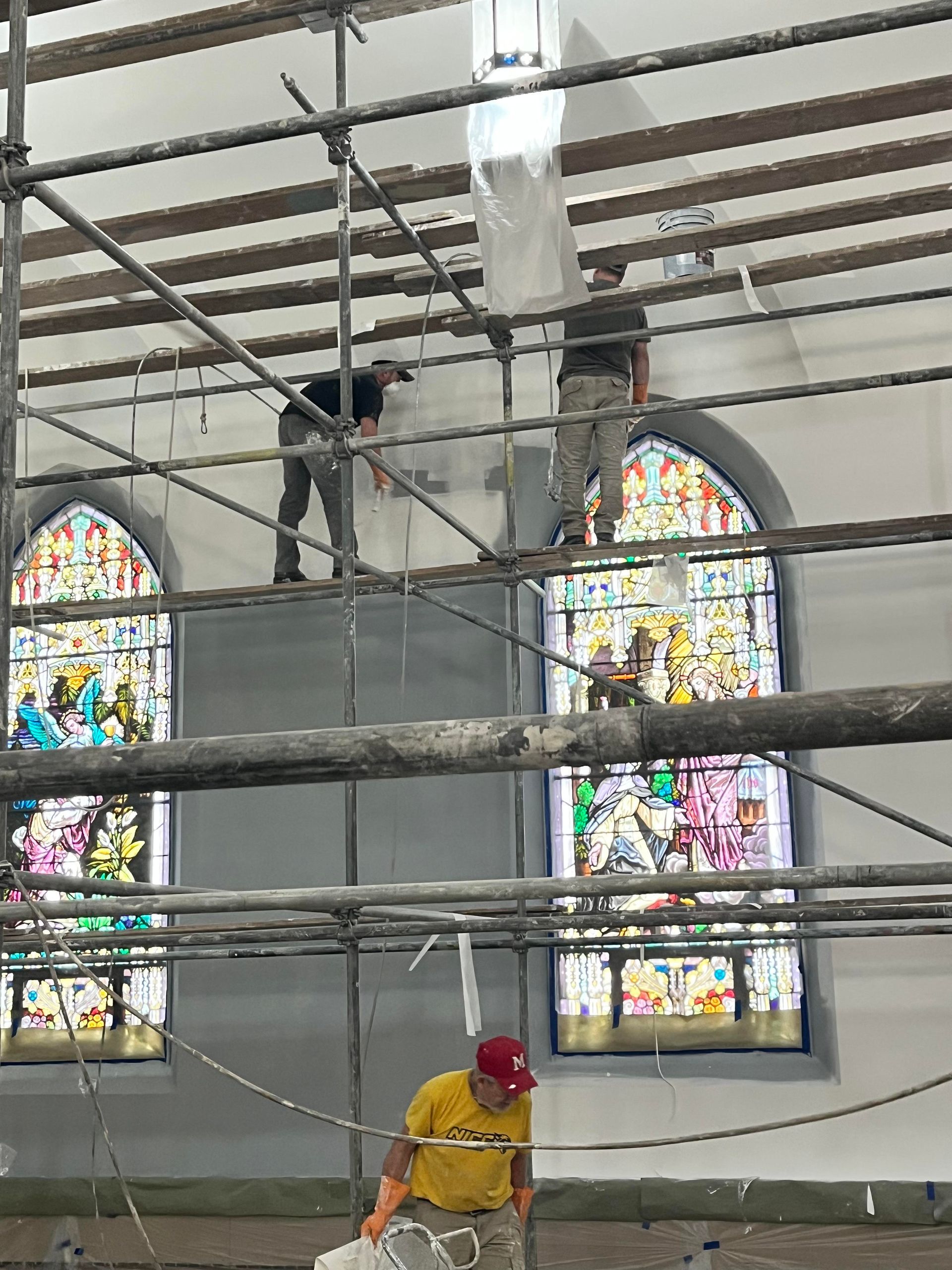

Applying glue and fiberglass to the east wall of church and the sanctuary - Dec. 17, 2025

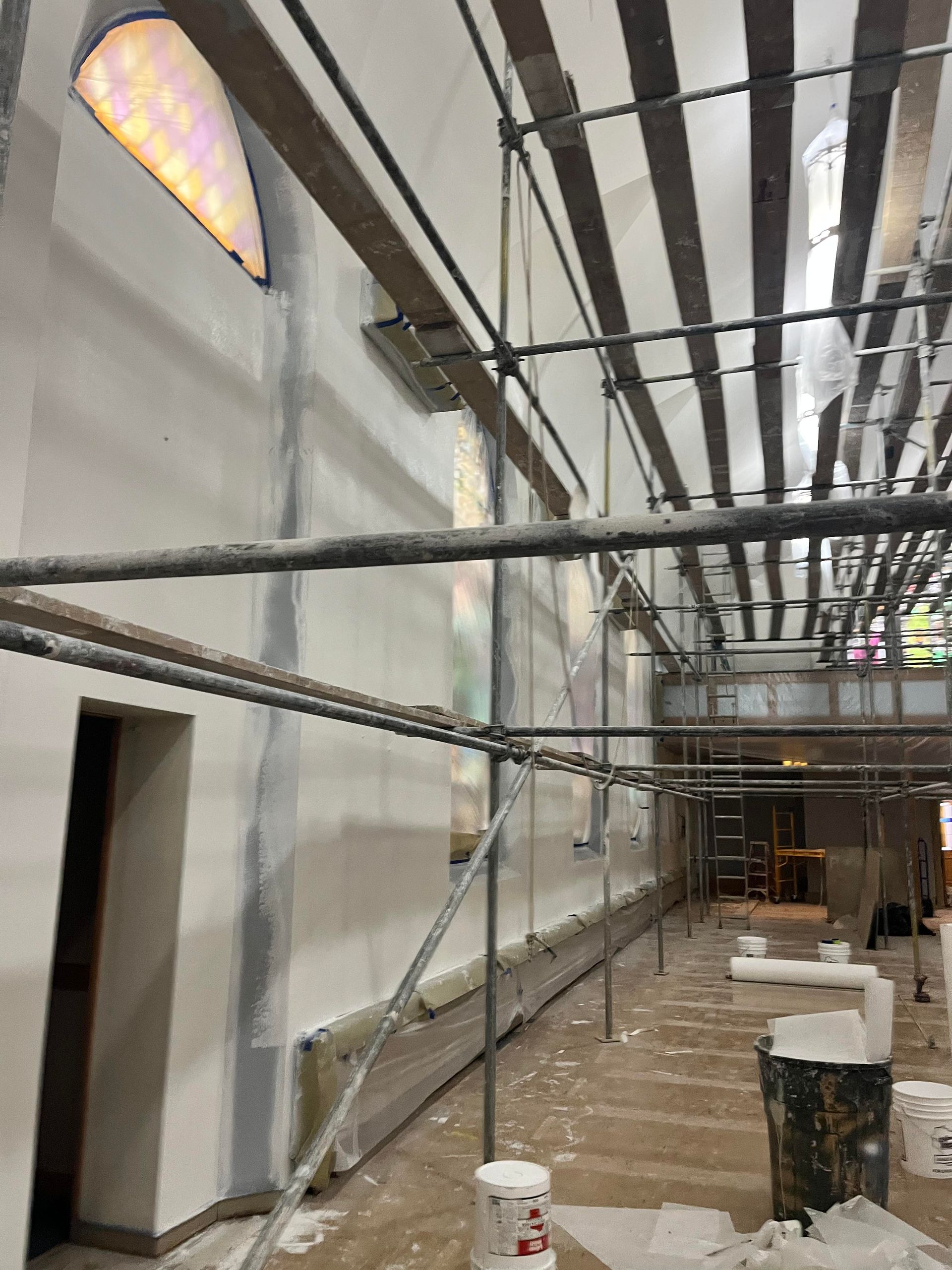

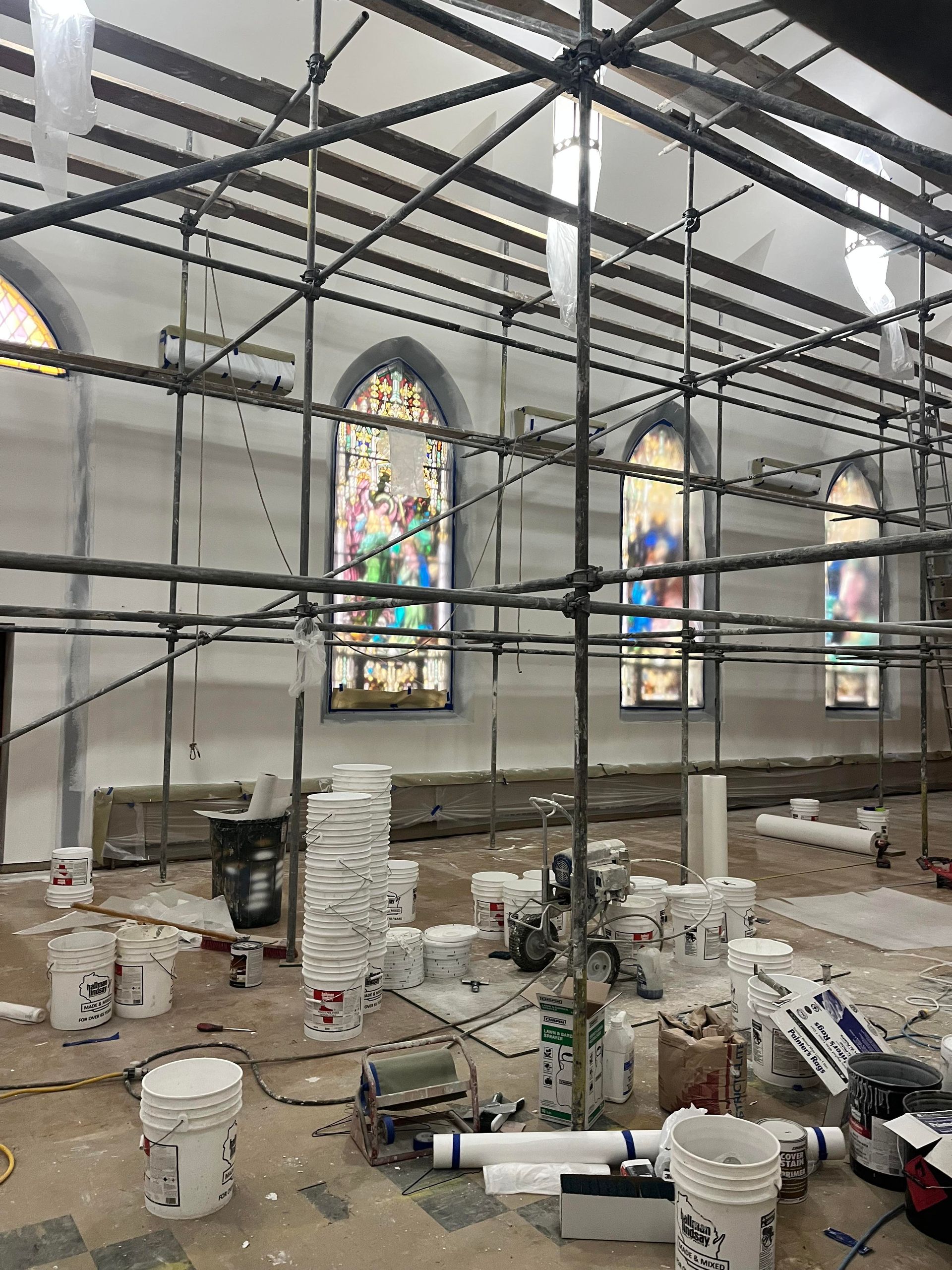

Glue and fiberglass applied to the east and west walls of church - Dec. 18, 2025

Over 80% of the church has the fiberglass layer installed.

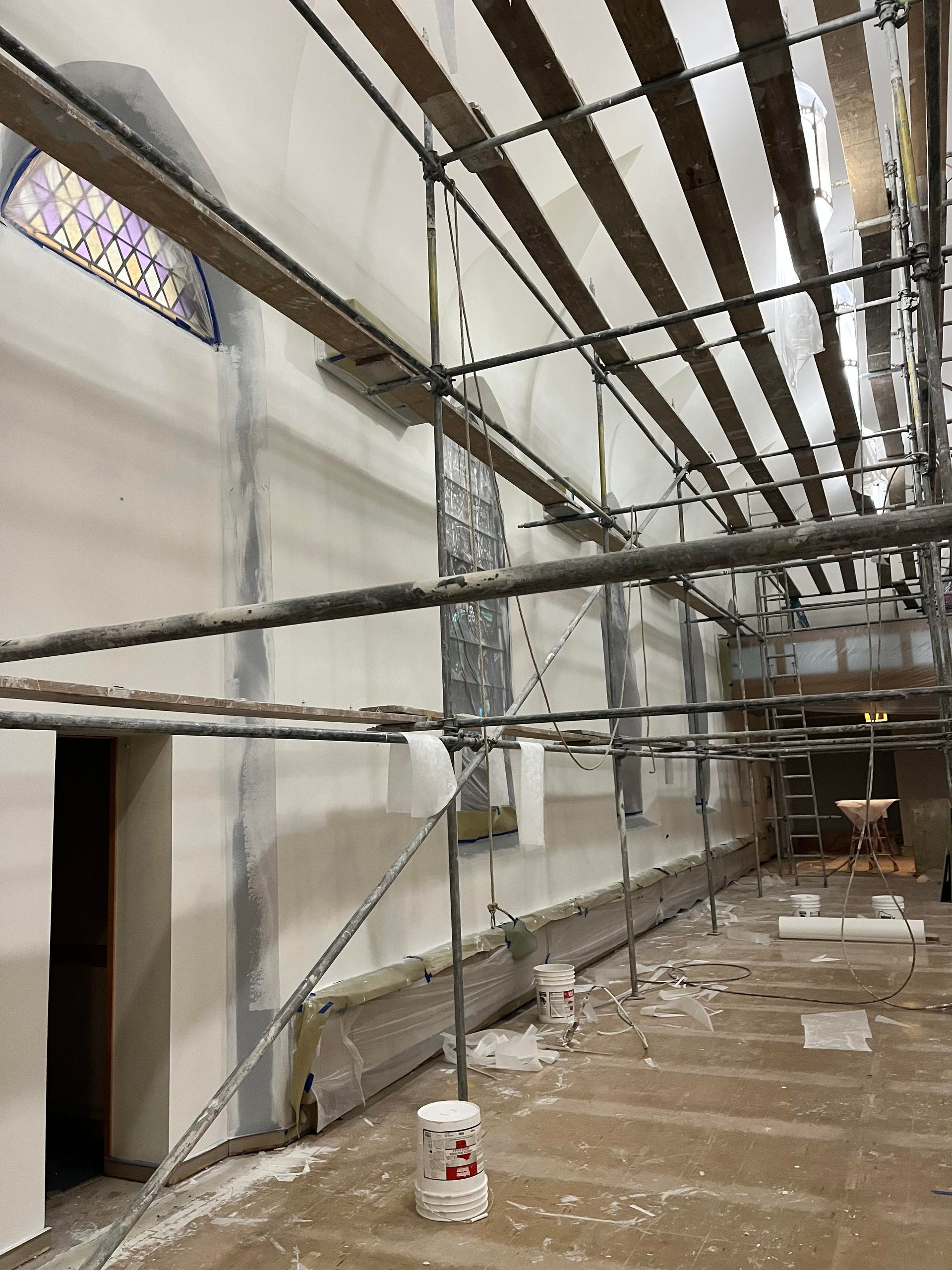

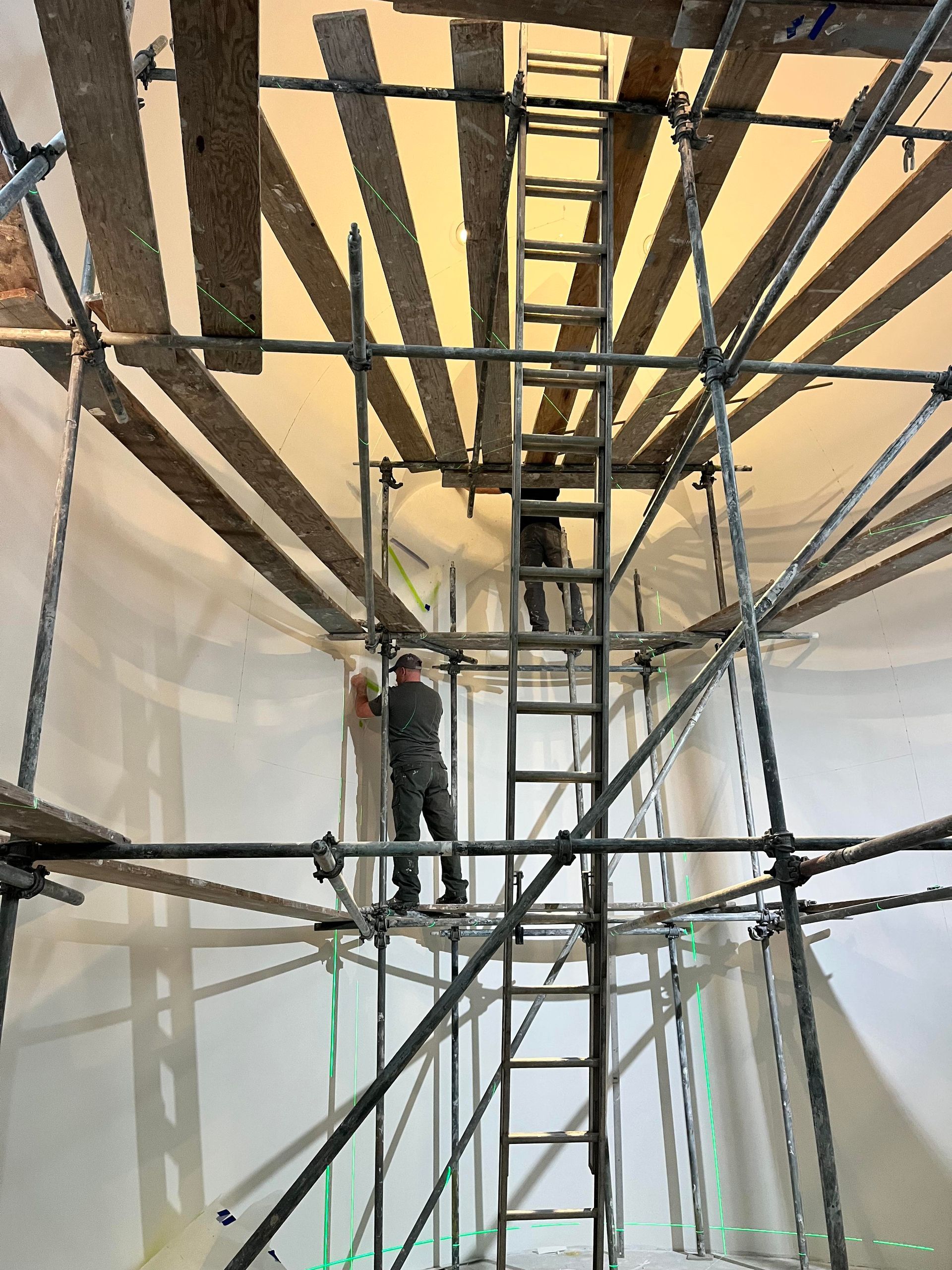

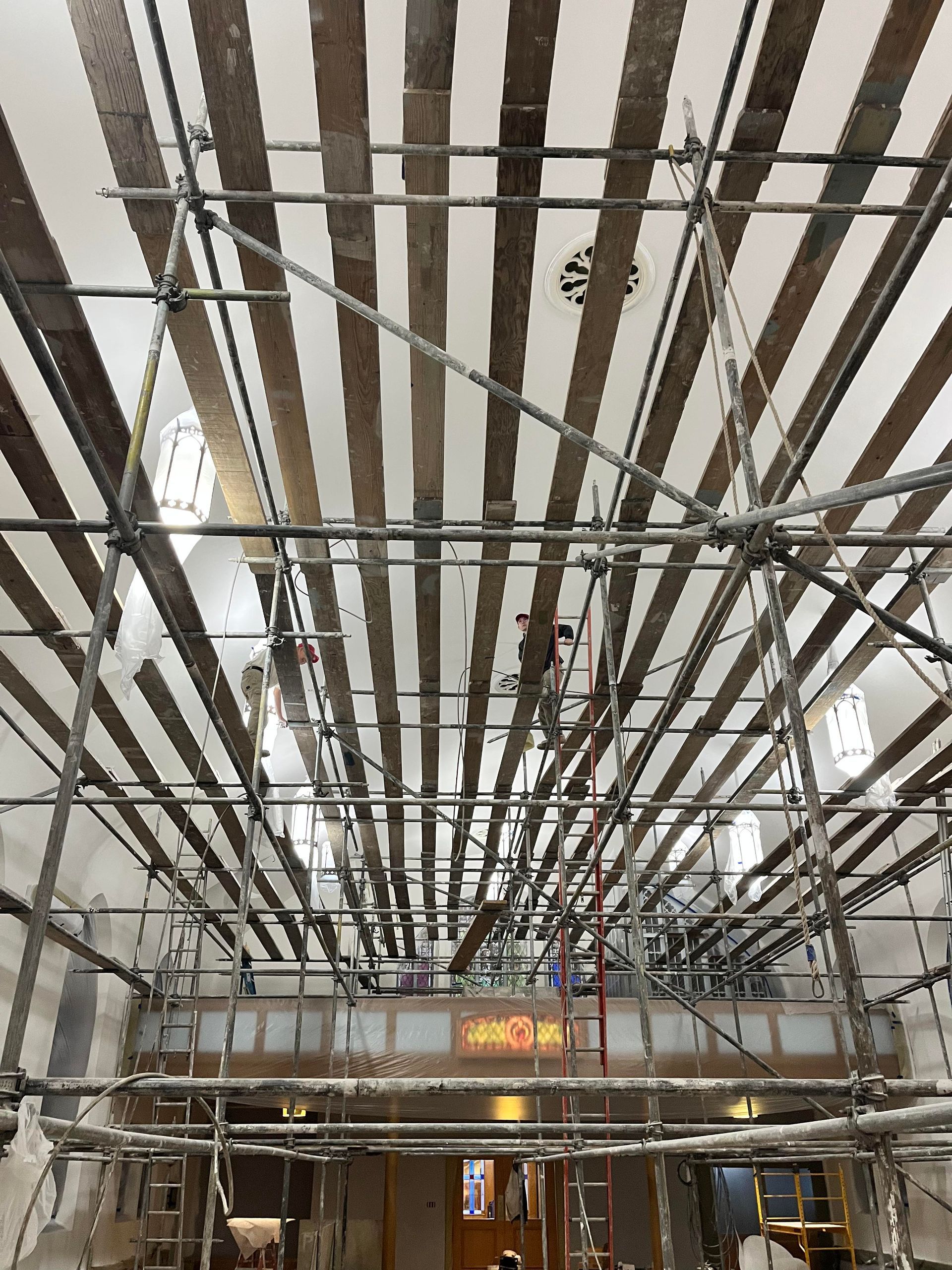

Completing the fiberglass layer - Dec. 22, 2025

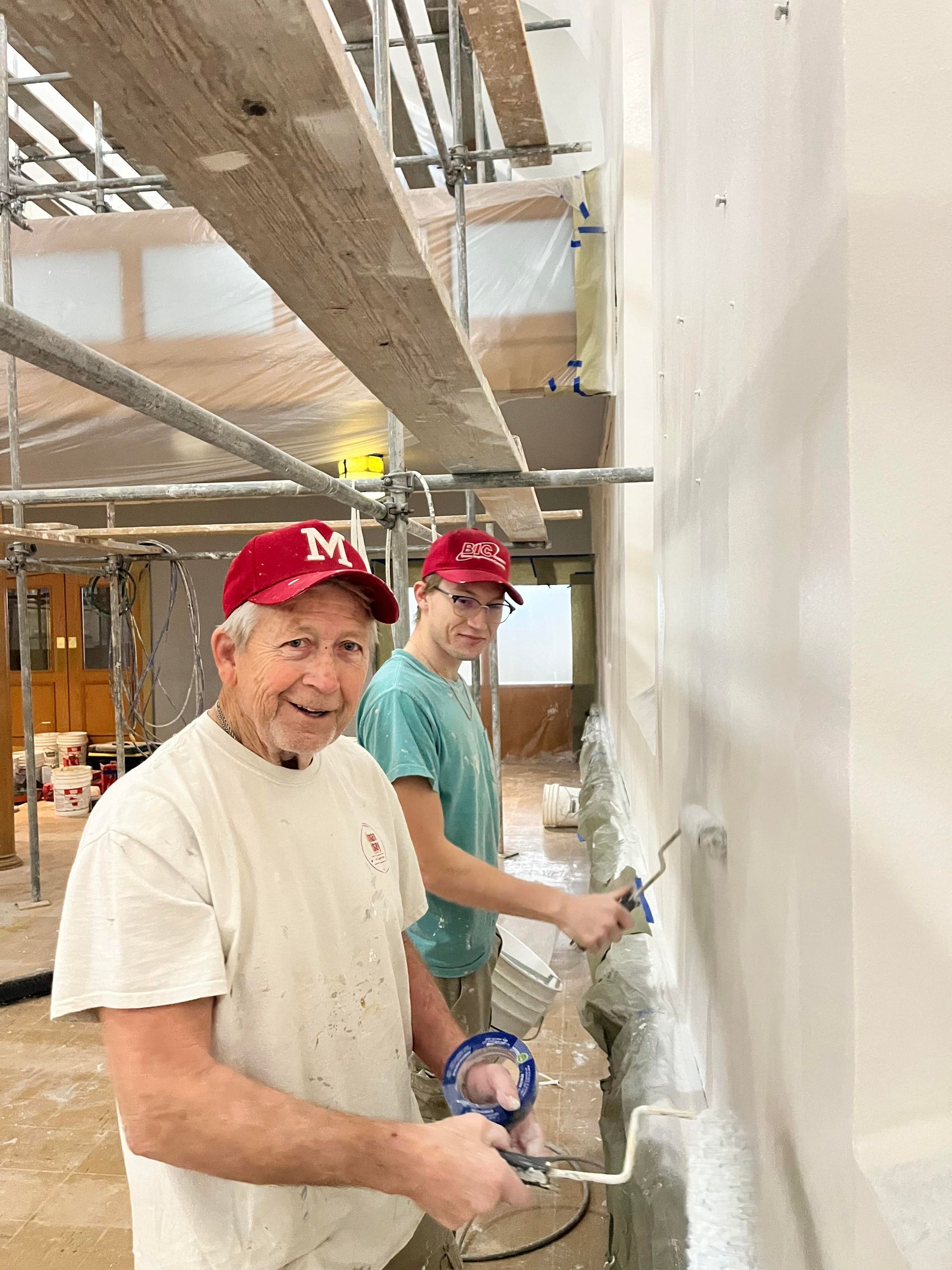

Pictured are Jerry Riehle and his grandson, Alex, who drove in from Ohio to visit his grandfather and is working with him while he's here!

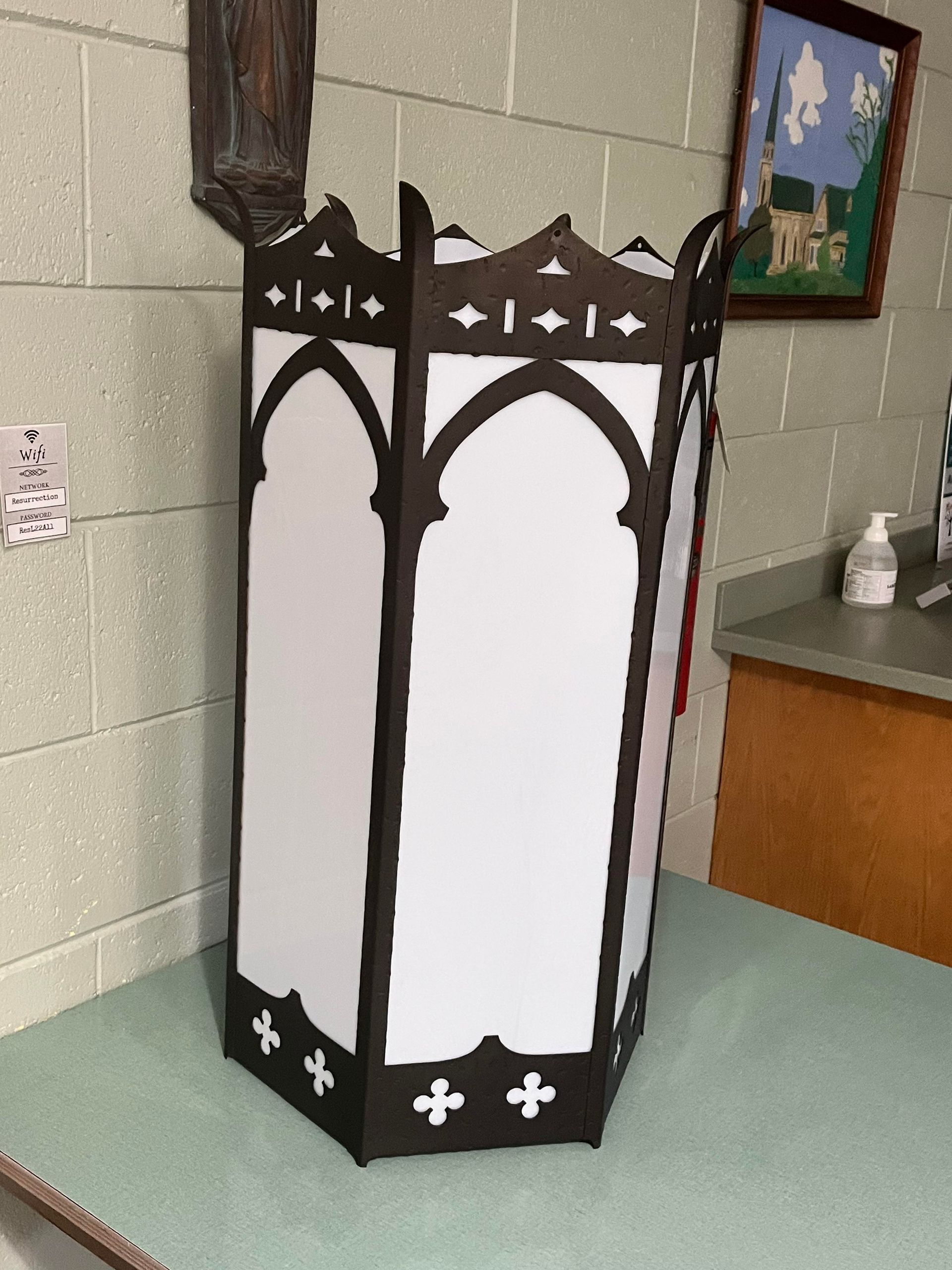

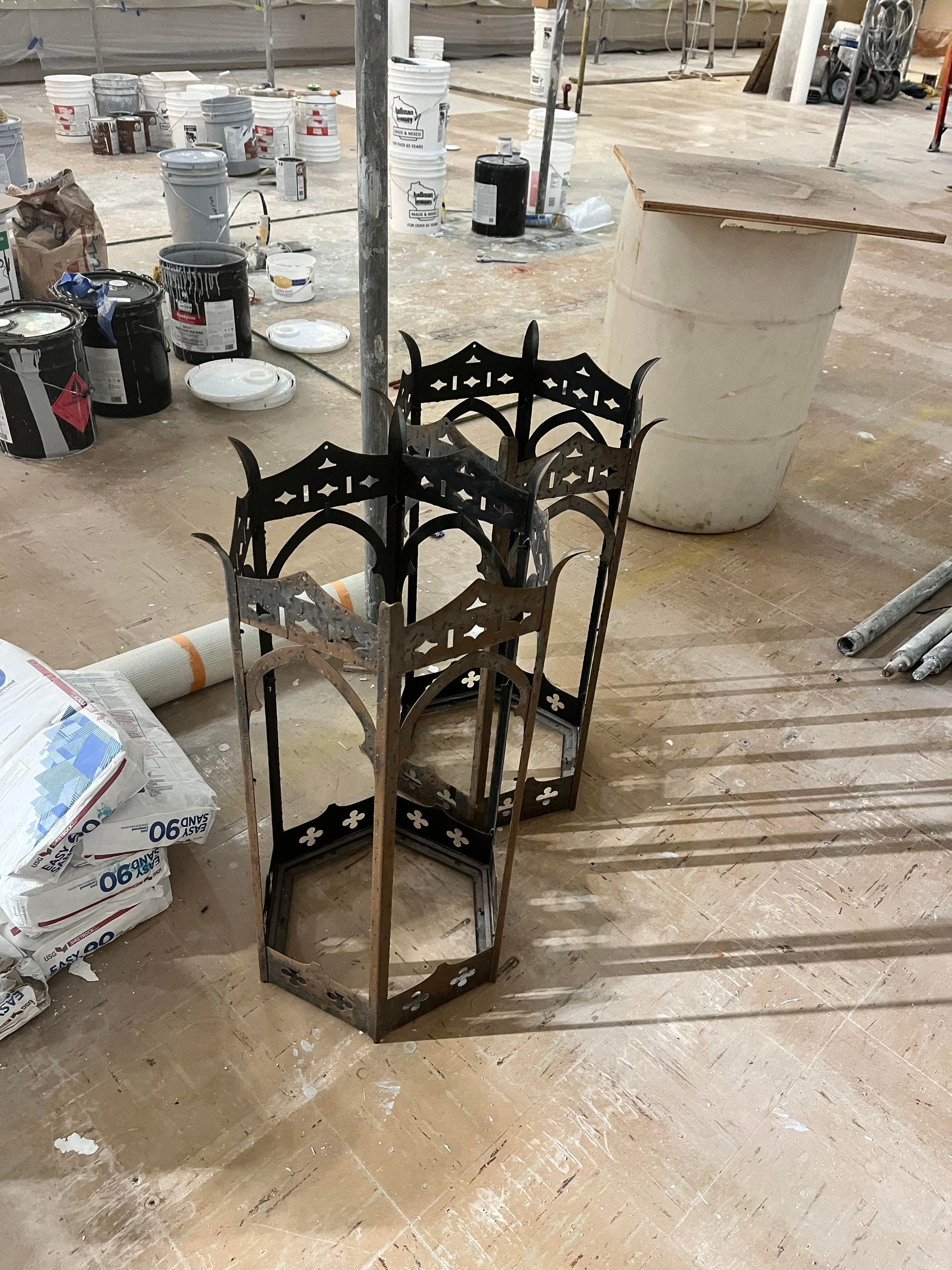

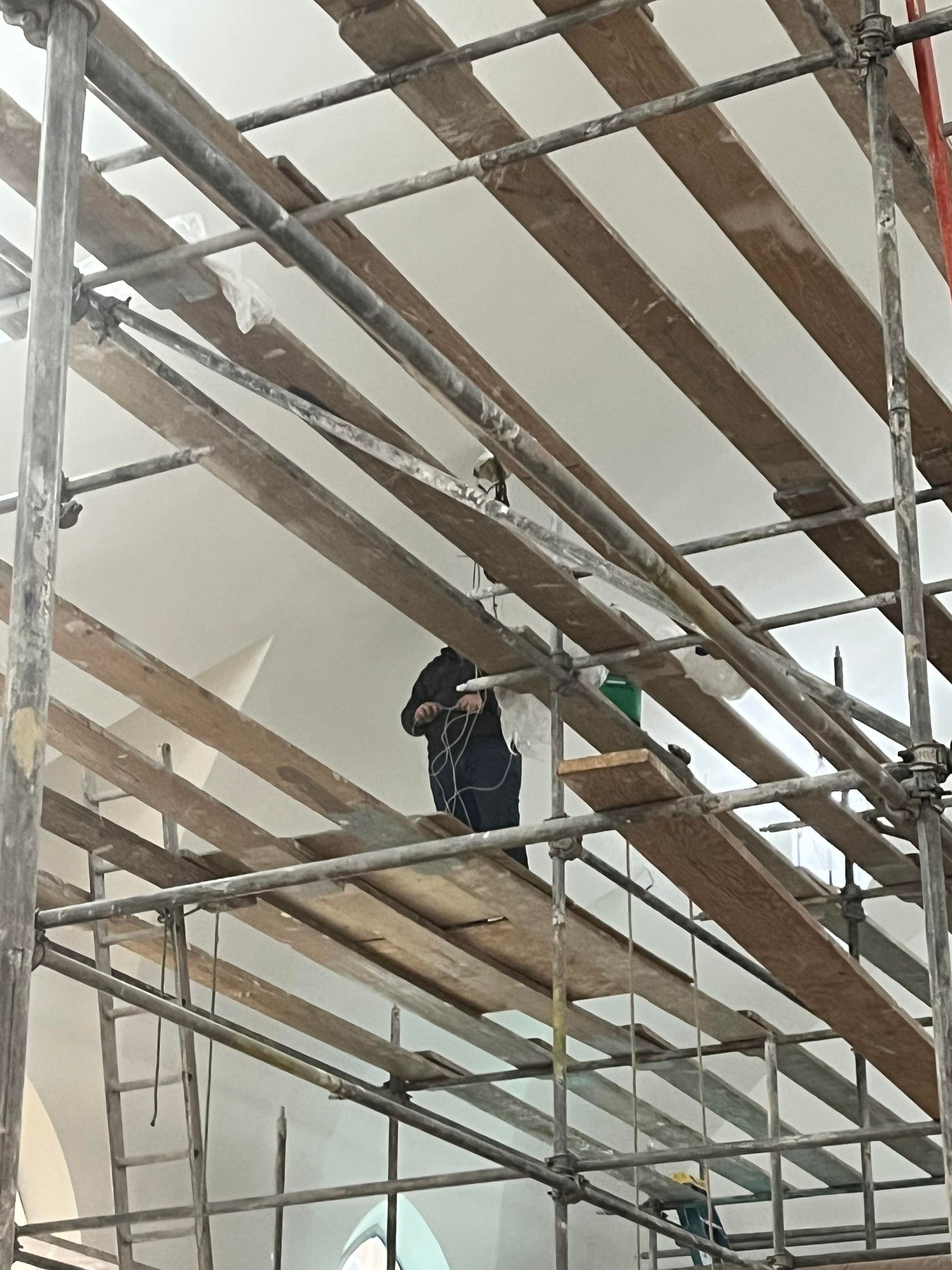

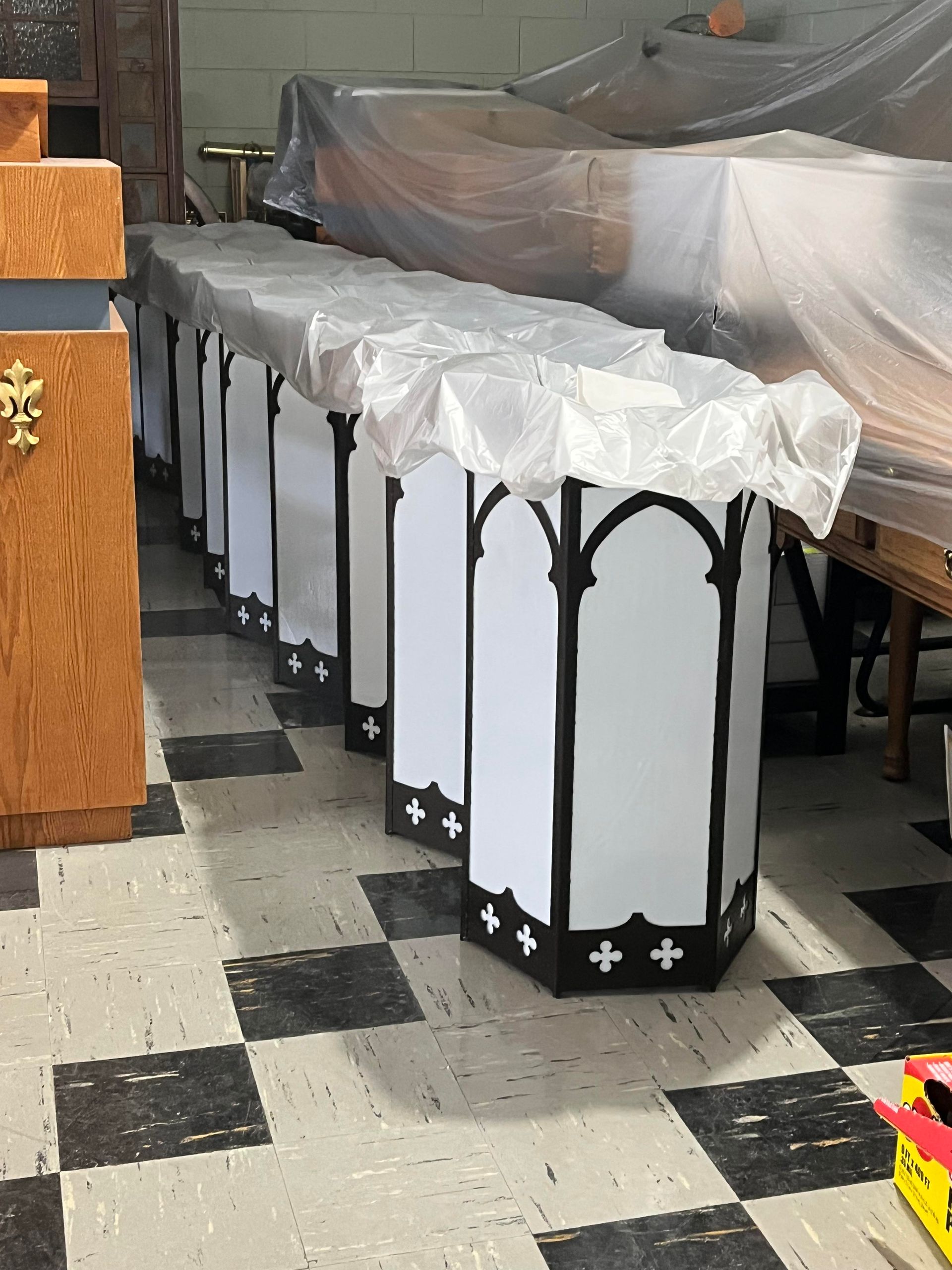

Tennies Electric worked on electrical updates to the church lights and the ceiling light fixtures were taken down for cleaning. - Week of Jan. 5, 2026

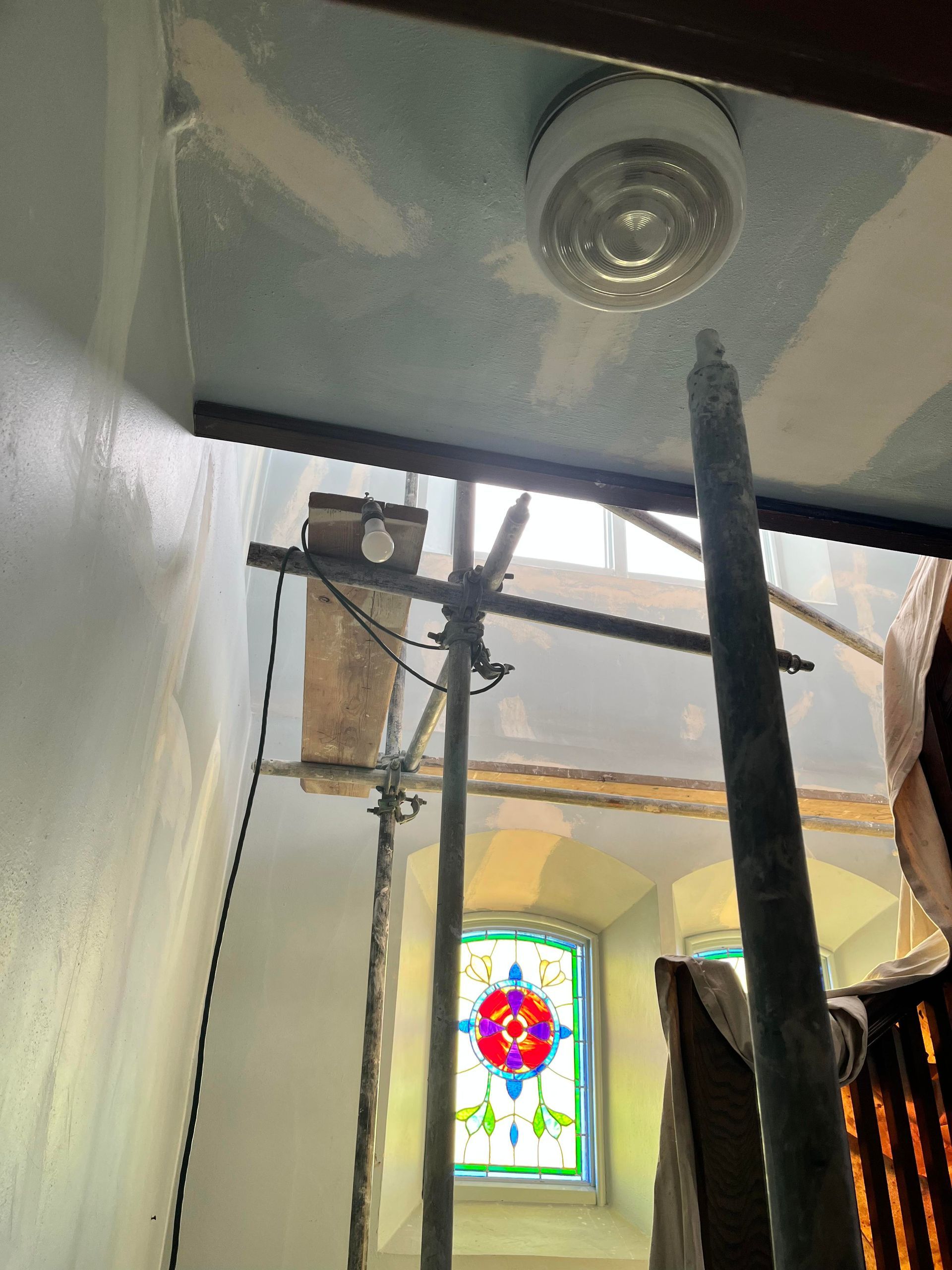

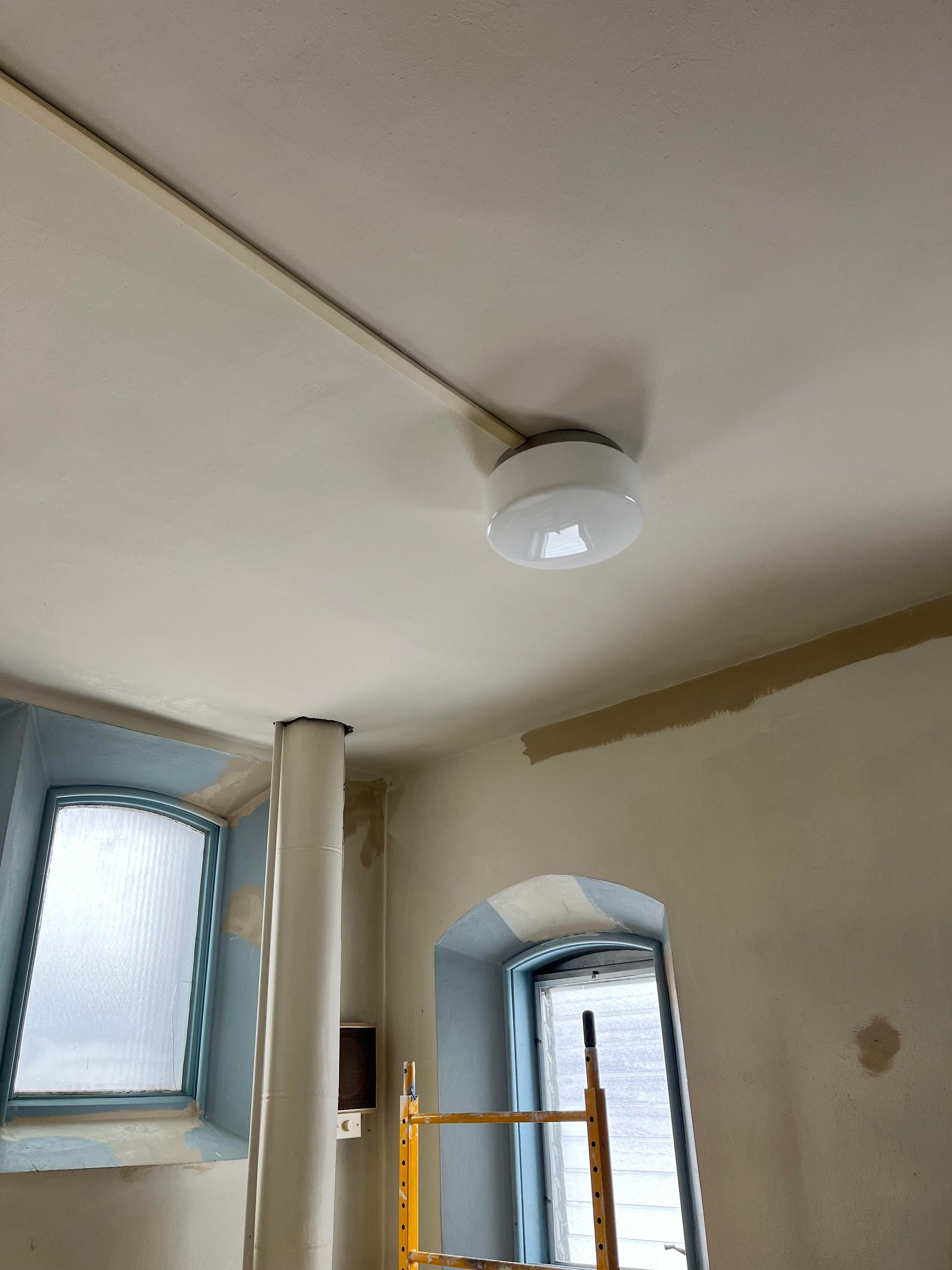

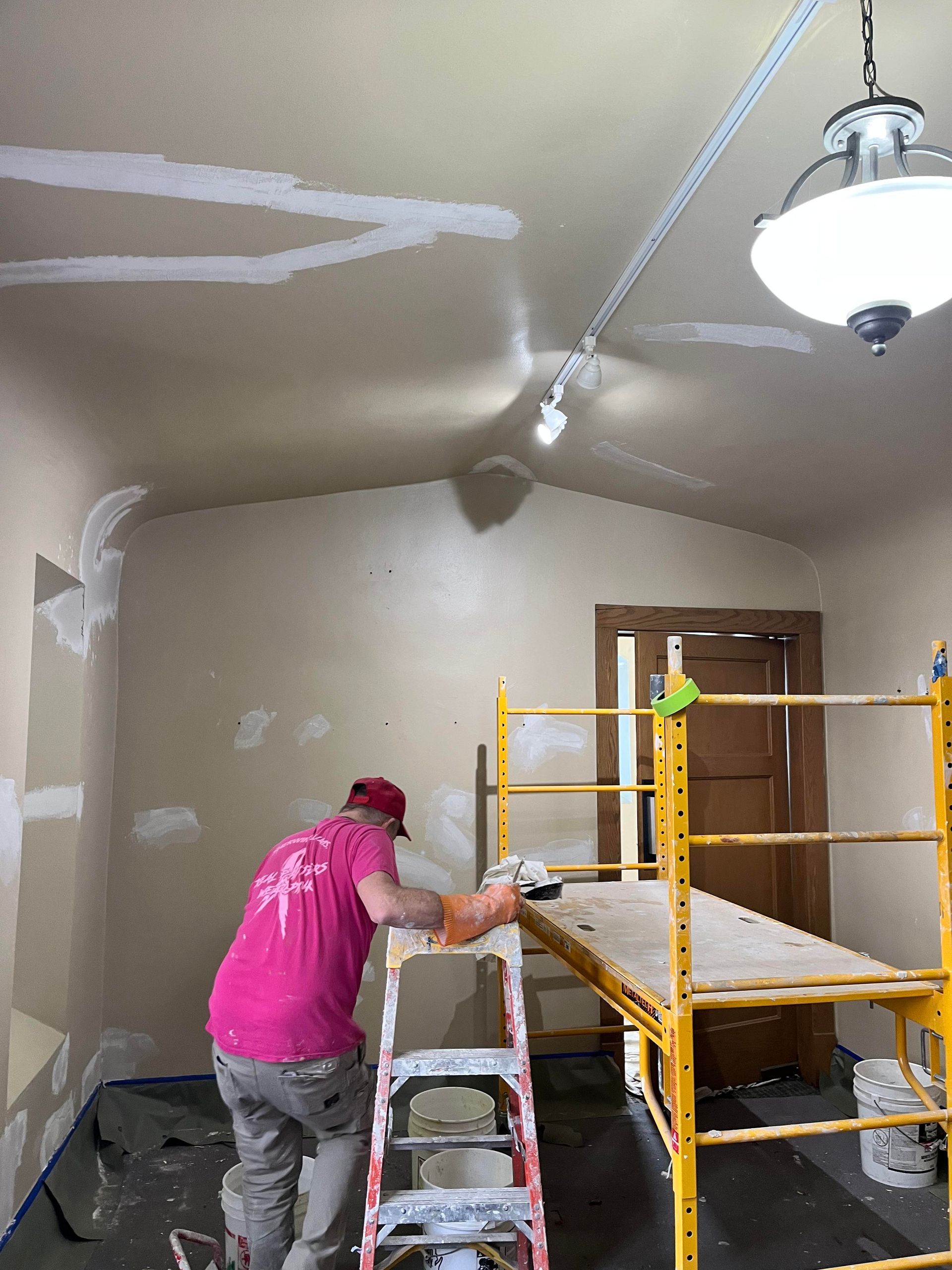

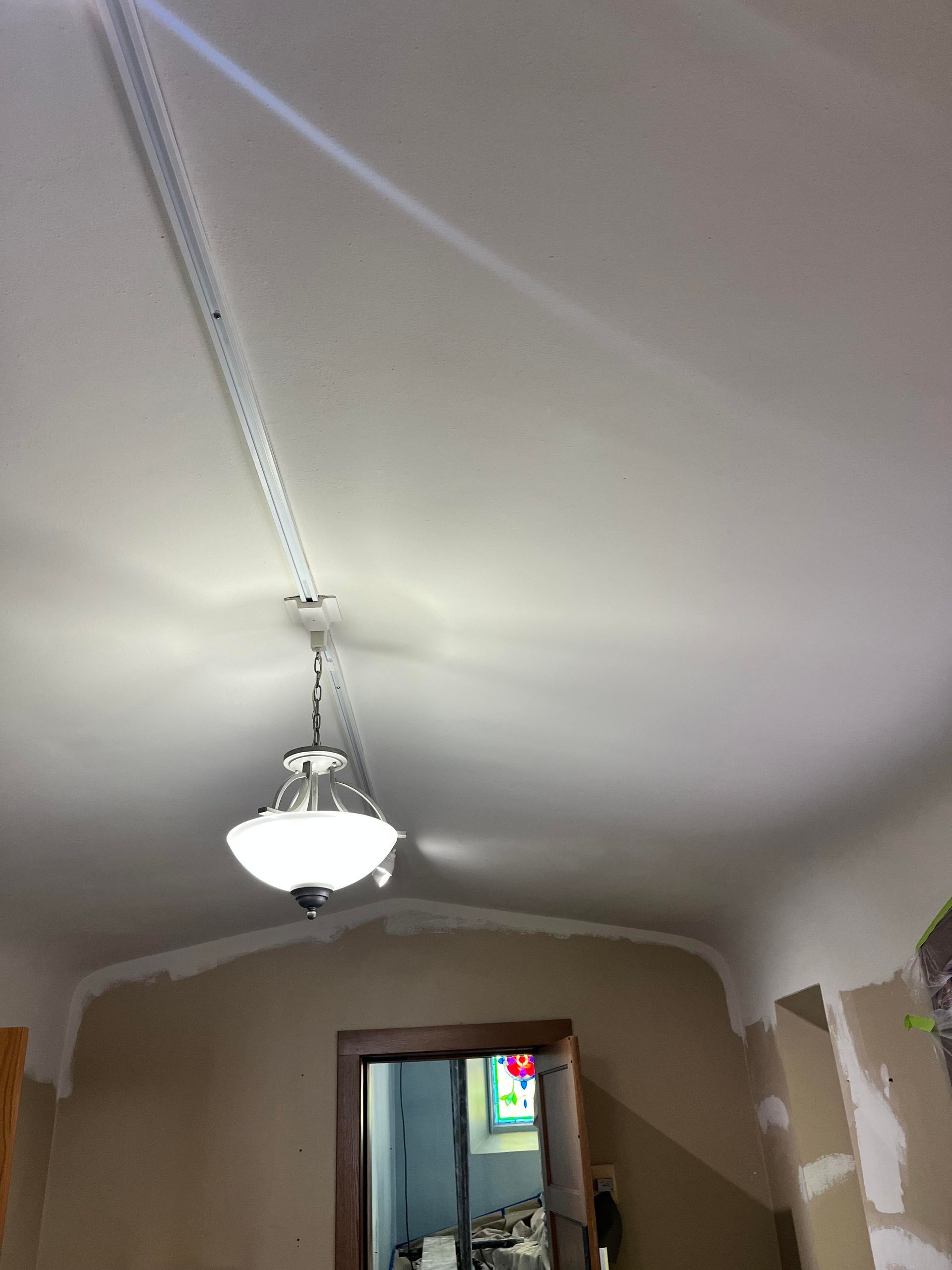

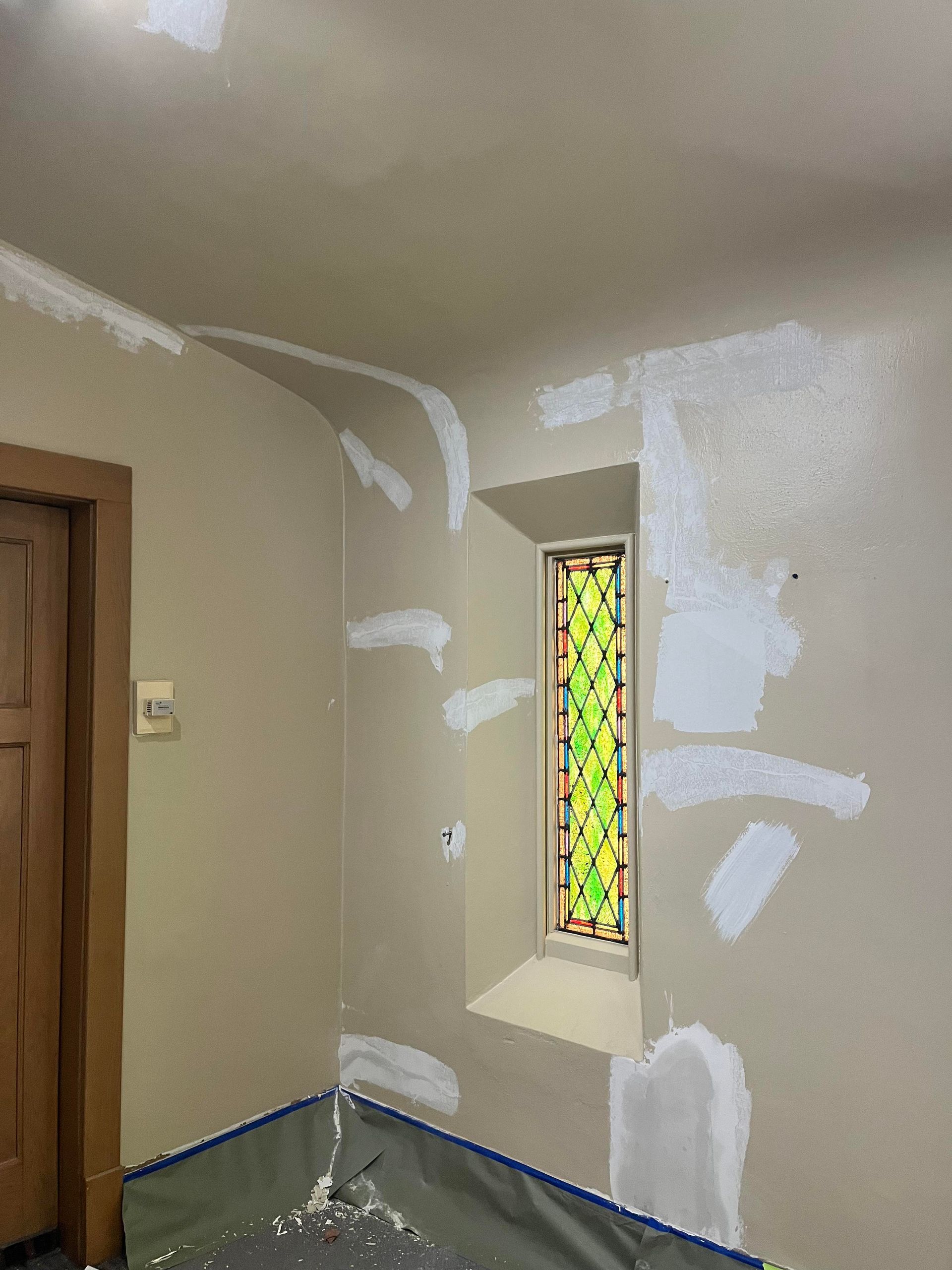

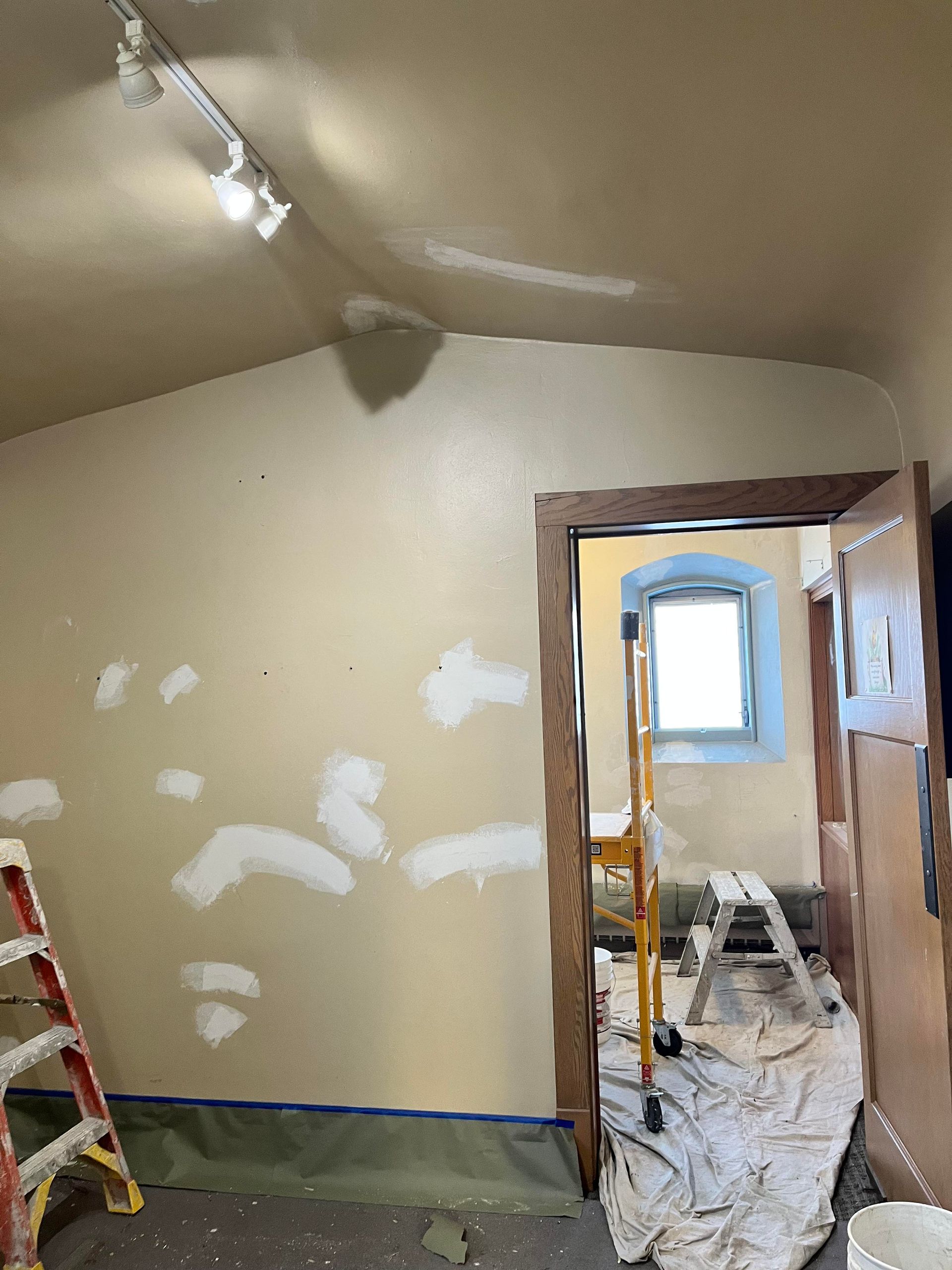

Painters working in the main entrance, cry room and stairwell to the choir; Ceiling lights refurbished and awaiting to be set back in place - Week of Jan. 12, 2026

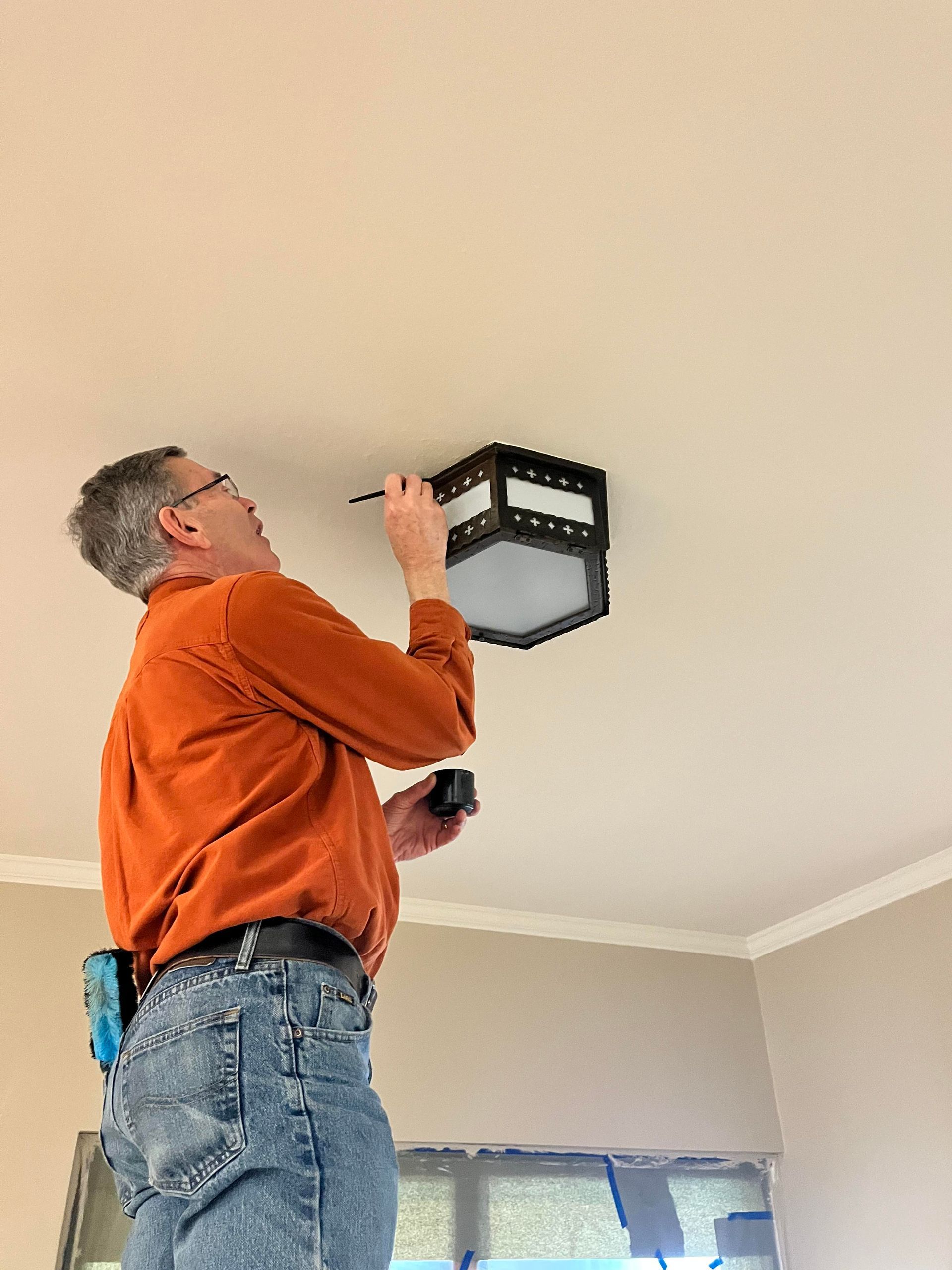

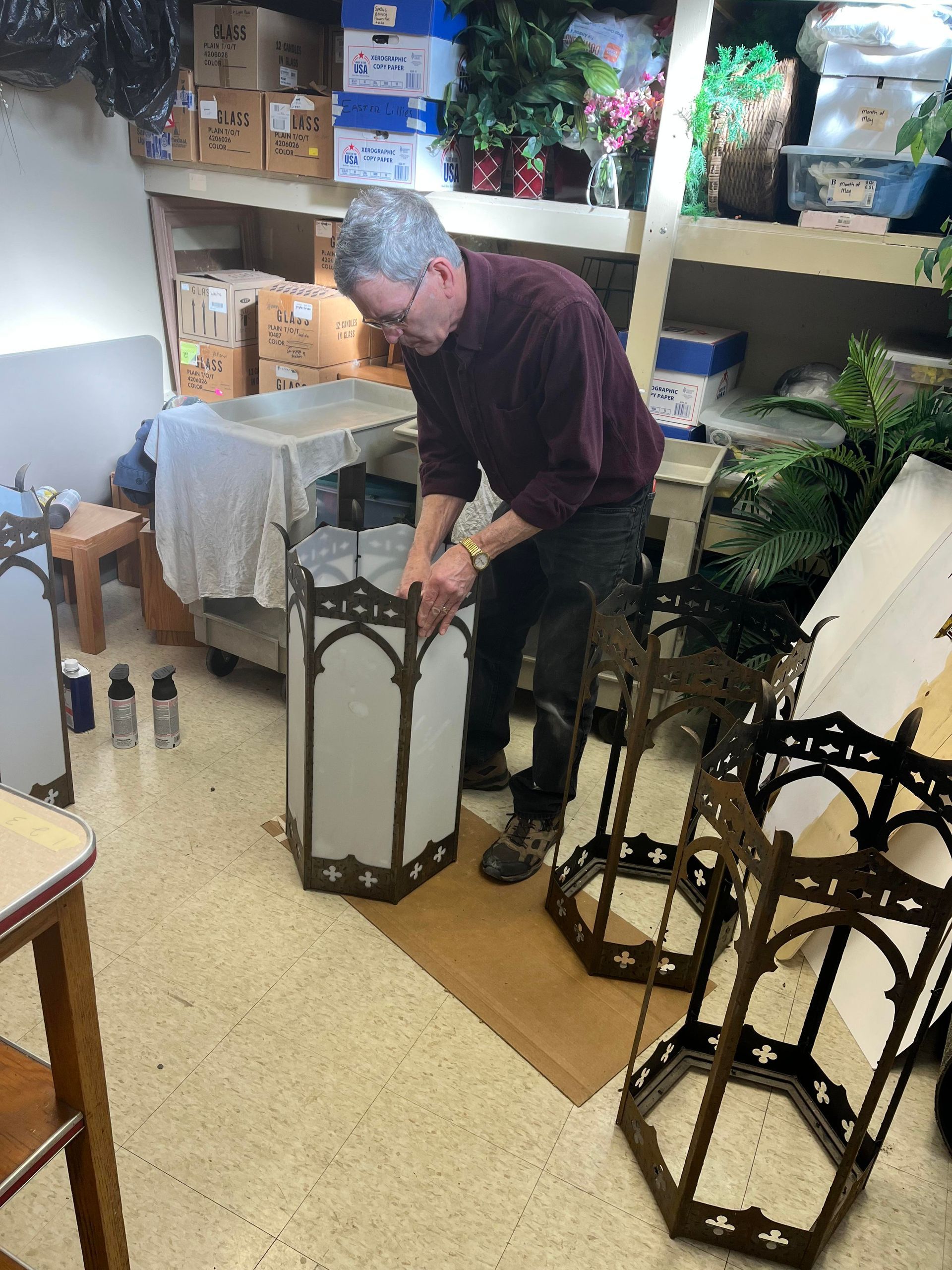

Tennies Electric on site for electrical updates, painting of the main church continues, and Gary Konrath doing his magic with cleaning up the light fixtures during our extreme cold spell - Week of Jan. 26, 2026

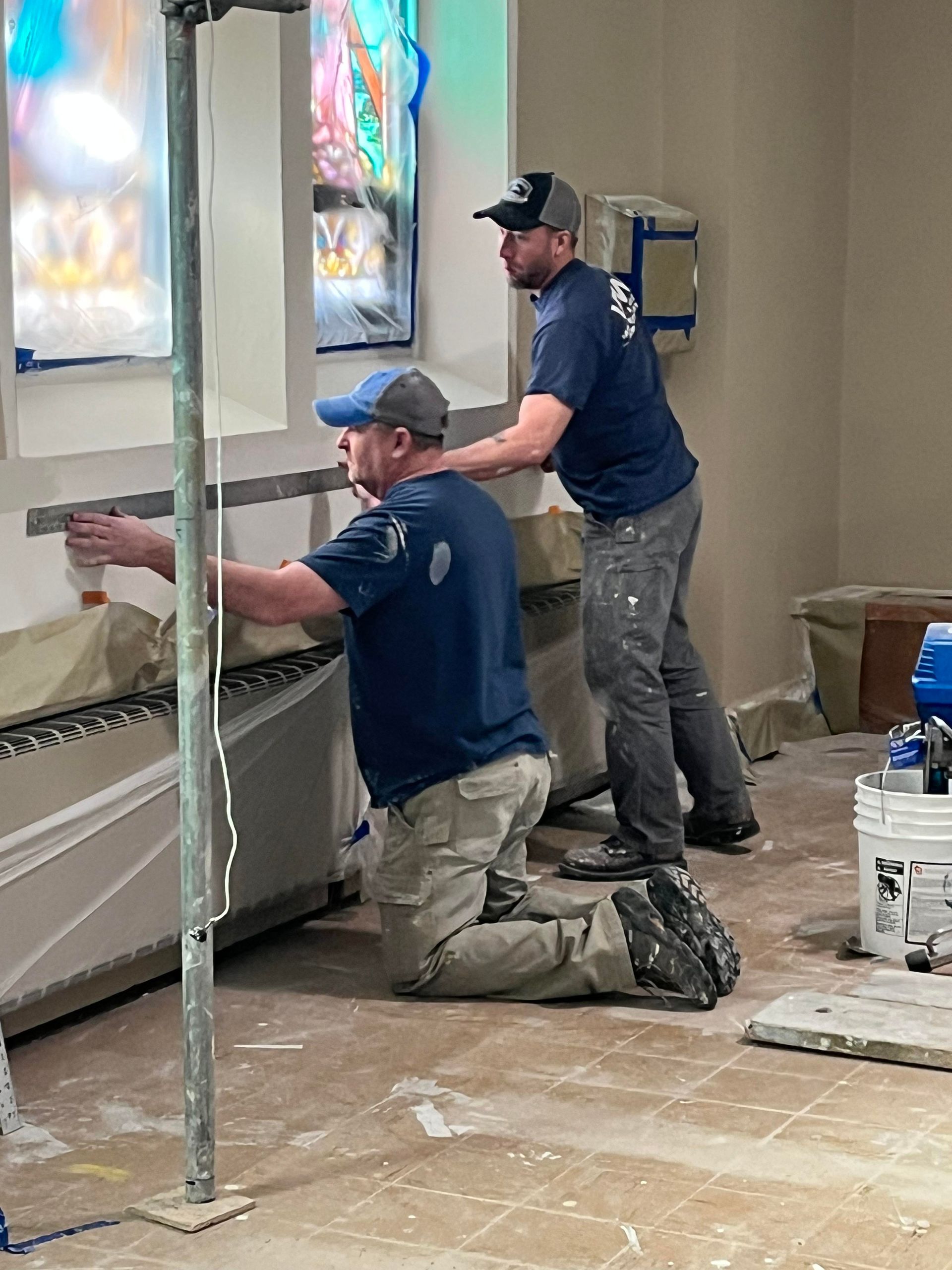

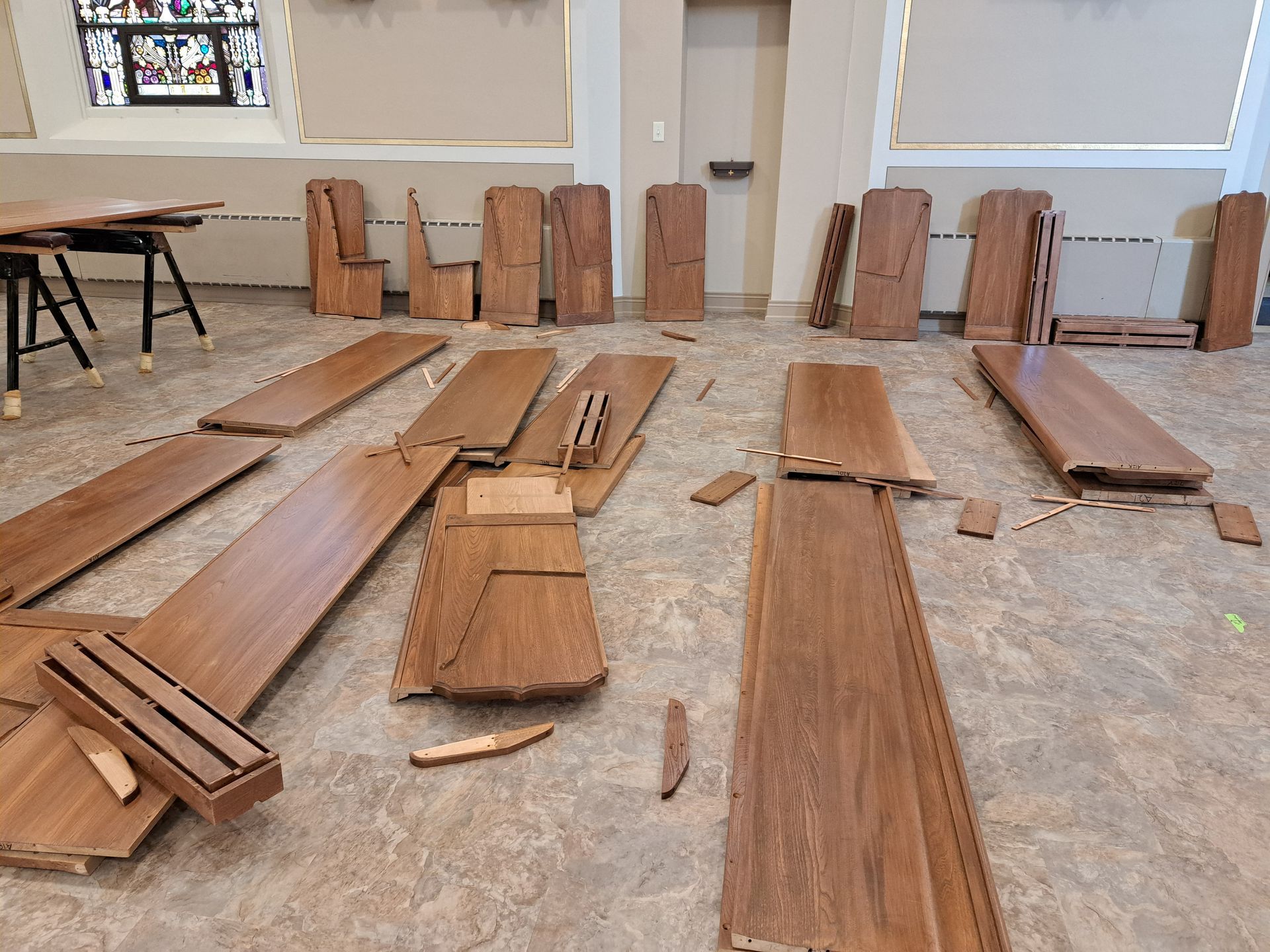

Dennis and Marg Wiedmeyer made a trip to Wood Renovators in Waupaca to check on the progress of refurbishment of the pews - Wed., Jan. 28, 2026

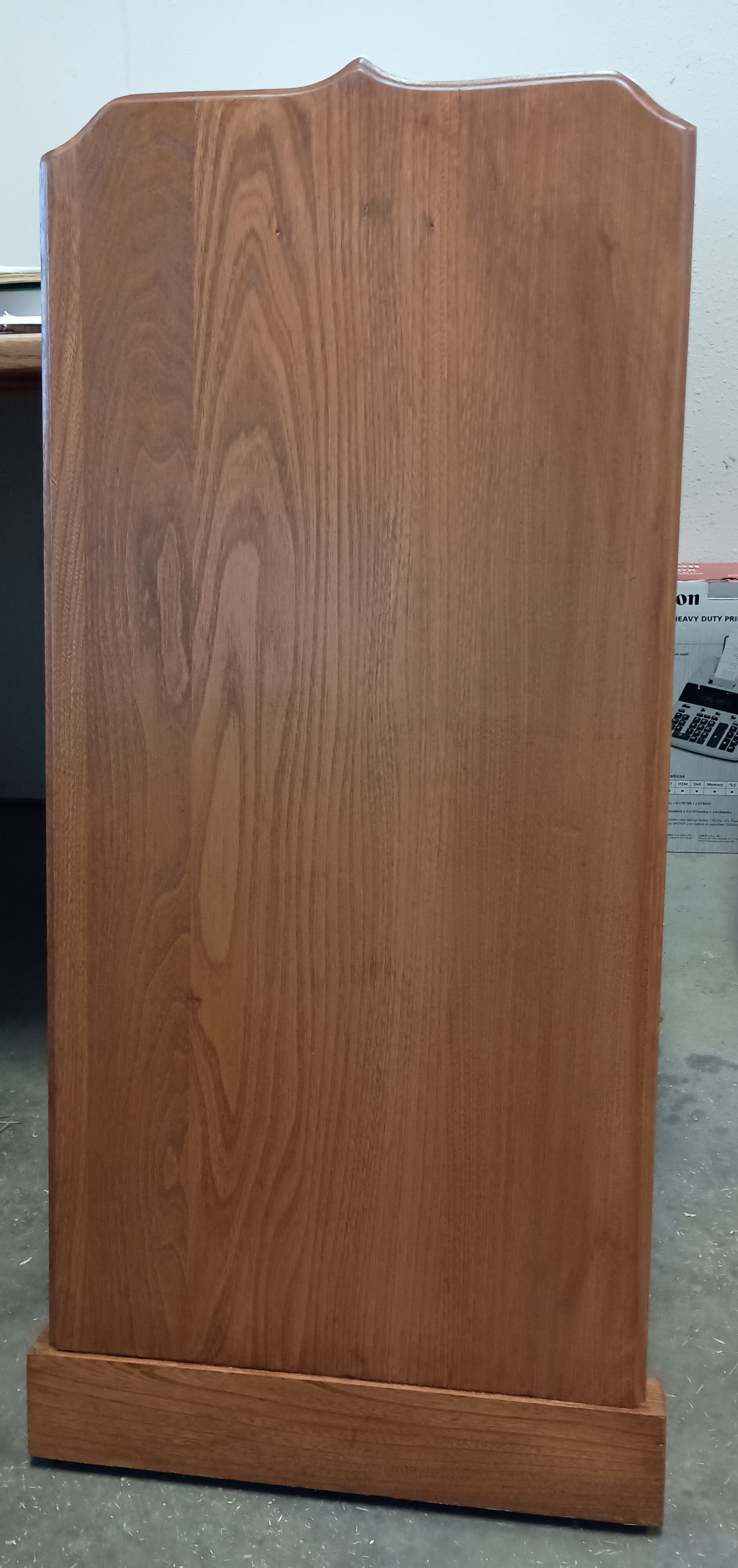

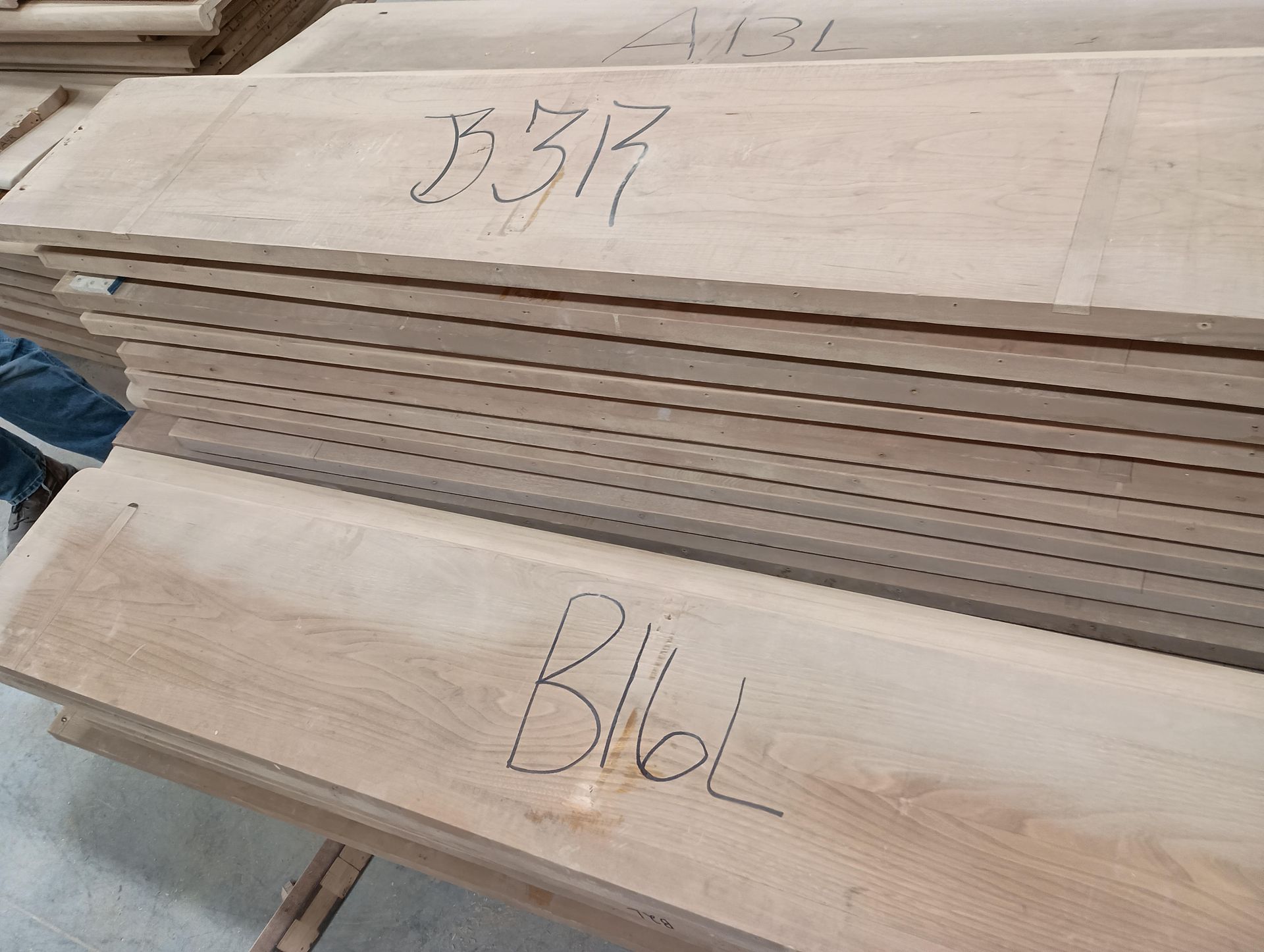

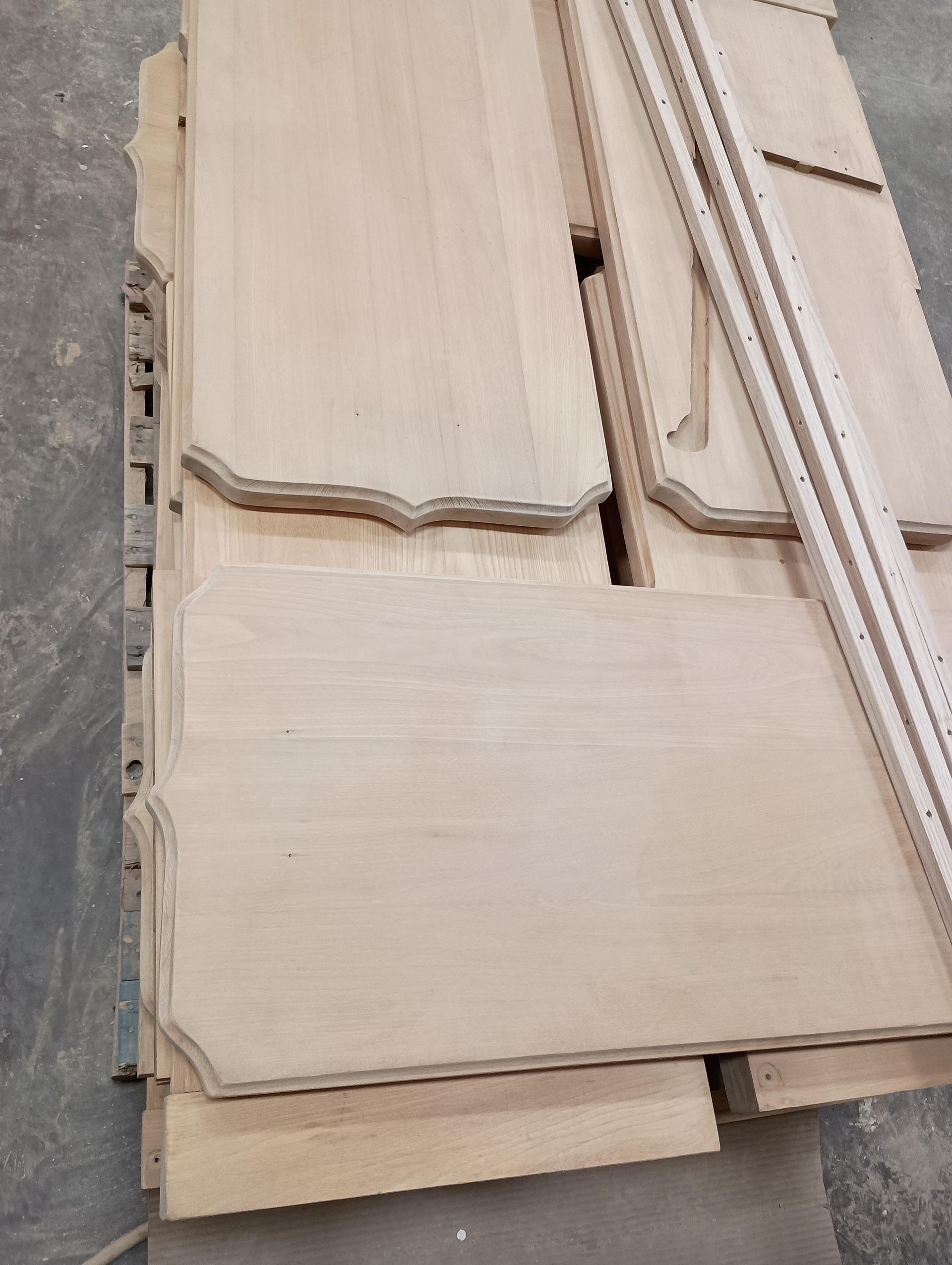

The pew pieces have been stripped. One of the pew ends shows the new stain color.

Riehle Decorating has completed their work - Week of Feb. 2, 2026

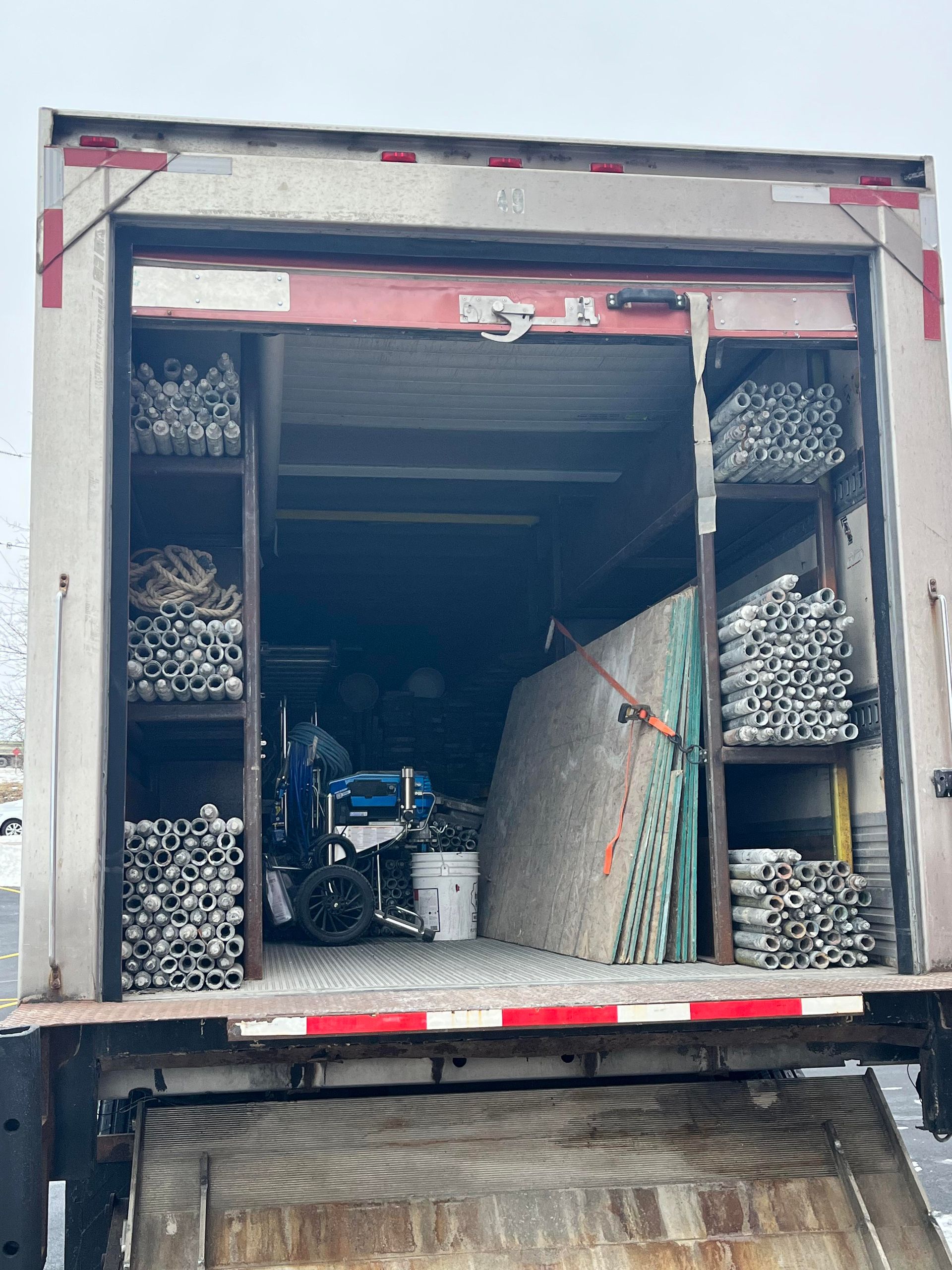

The painter's truck was loaded with the scaffolding with the help of several volunteers on Thurs., Feb. 5, 2026. With their work completed, the Riehle Decorating crew left for home on Friday, Feb. 6, 2026. Work has now begun on fixing the subfloor and rebuilding the steps in the sanctuary area.

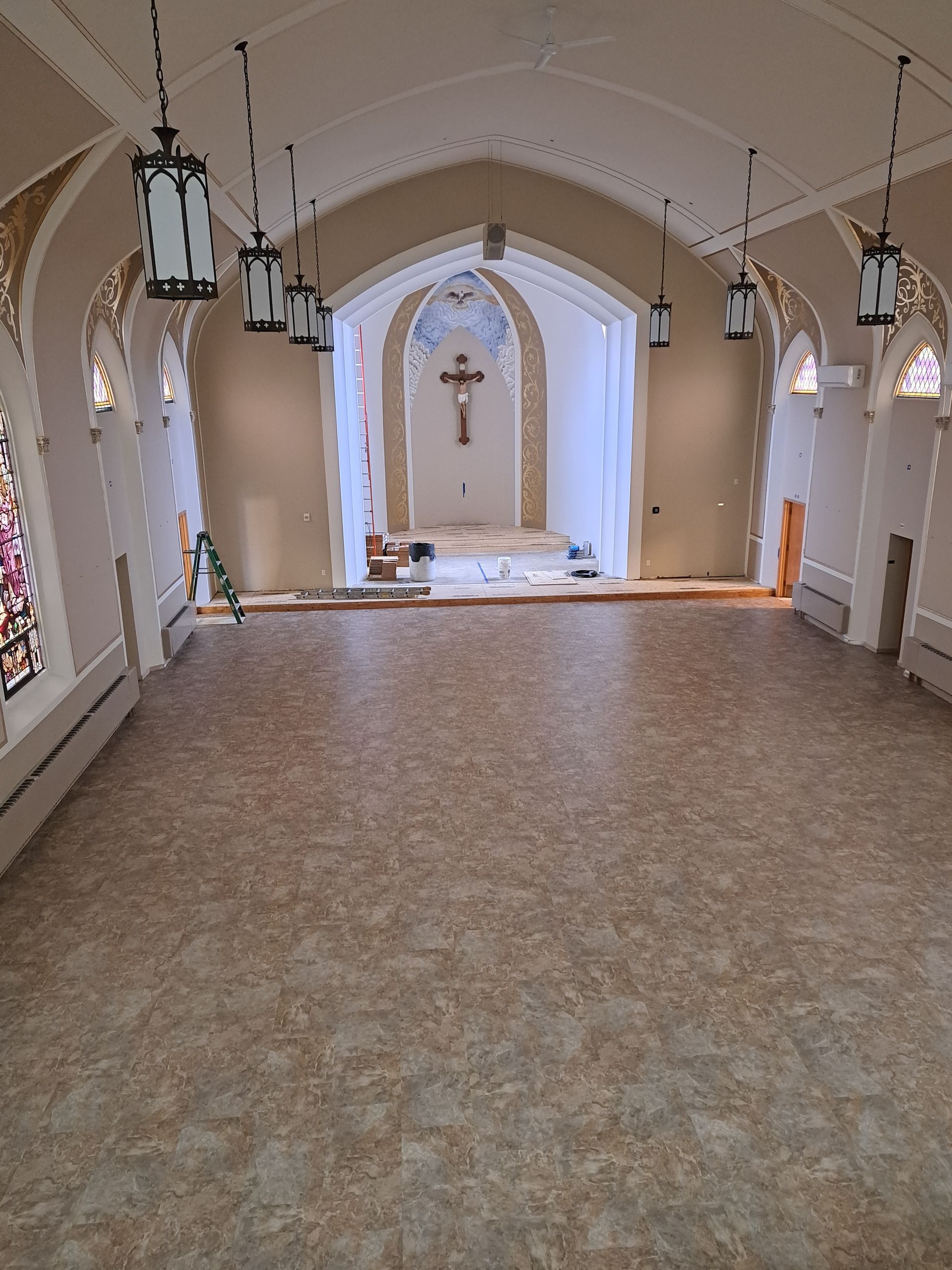

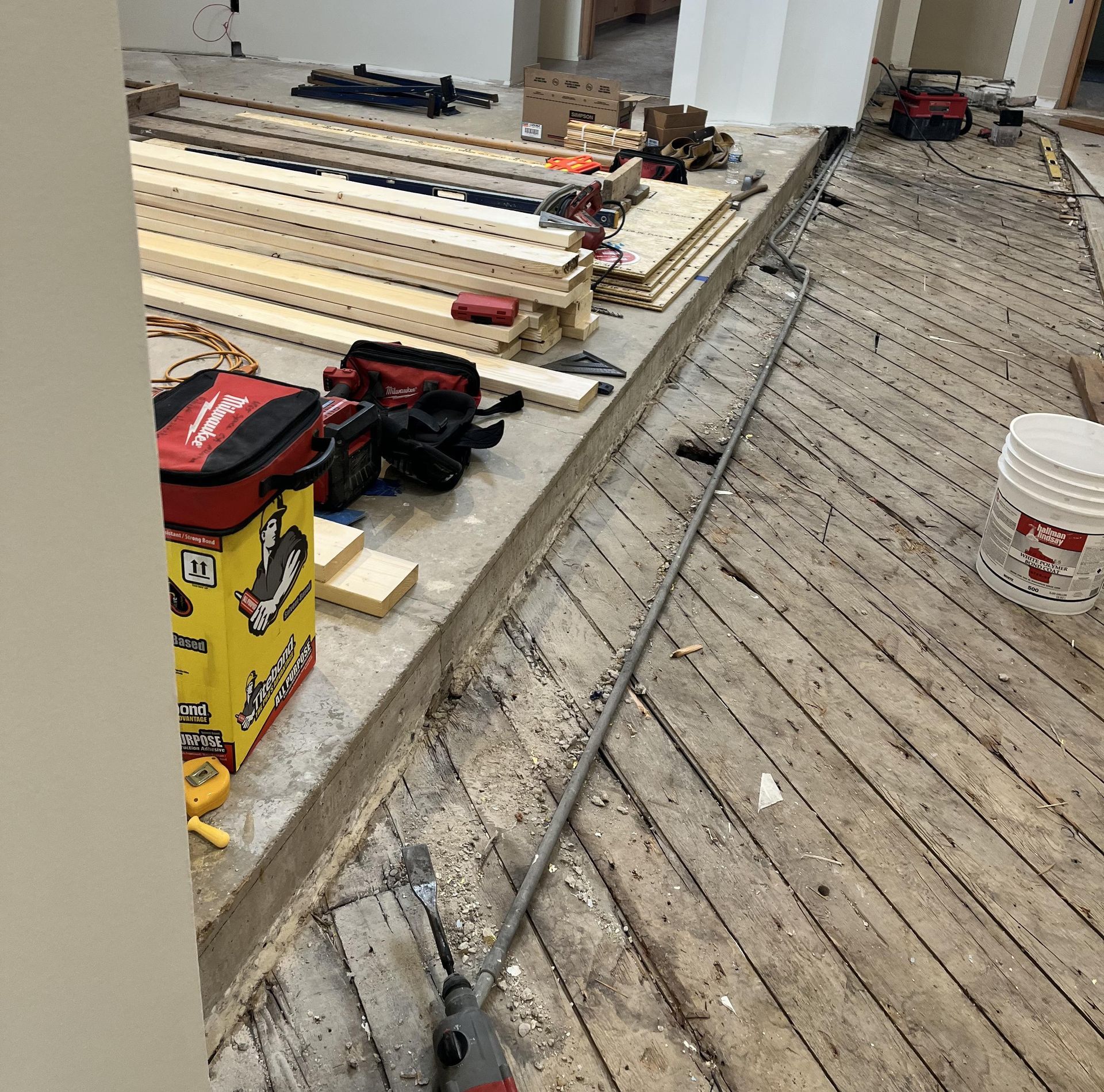

Flooring work continues - Week of Feb. 9, 2026

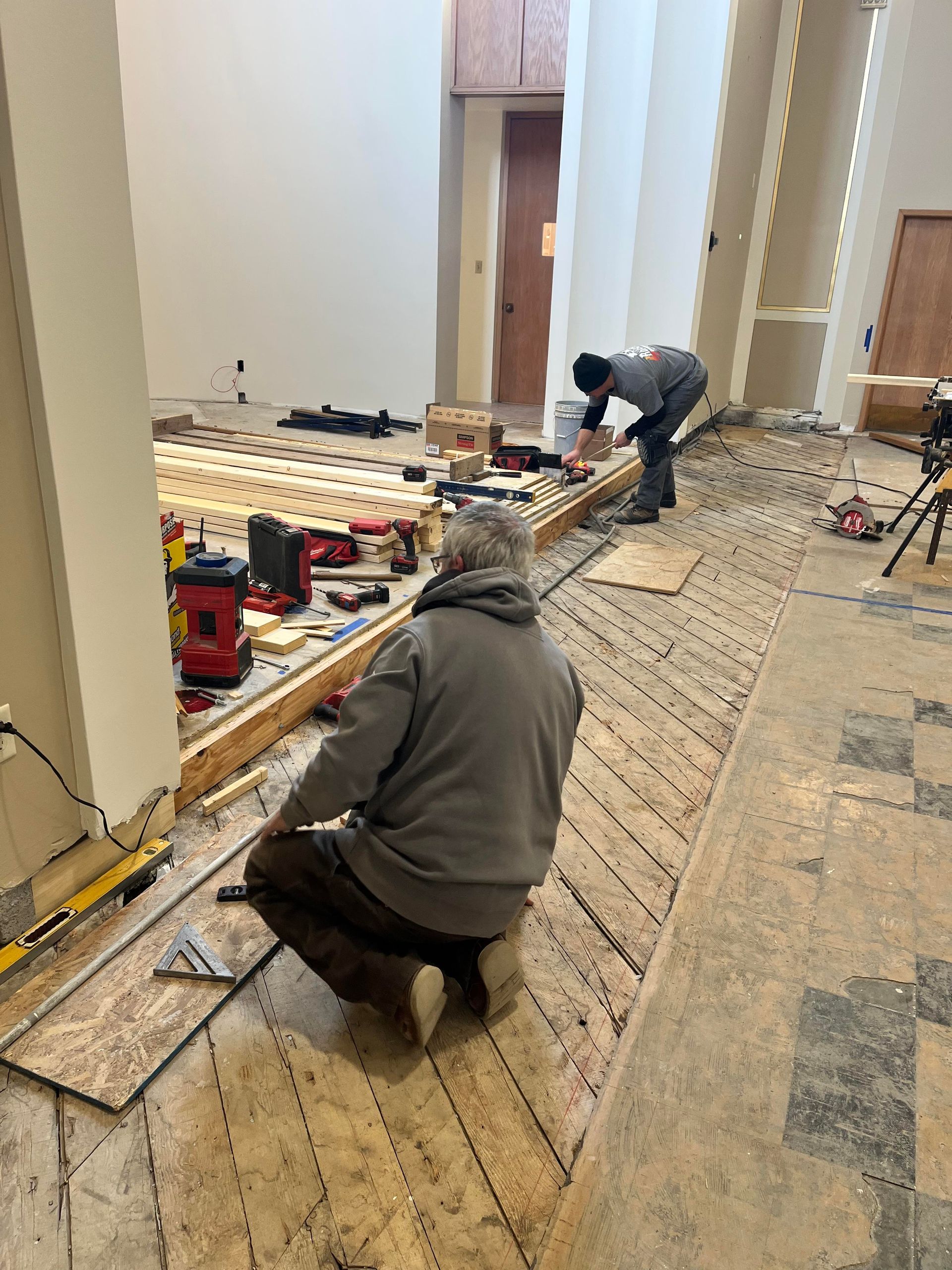

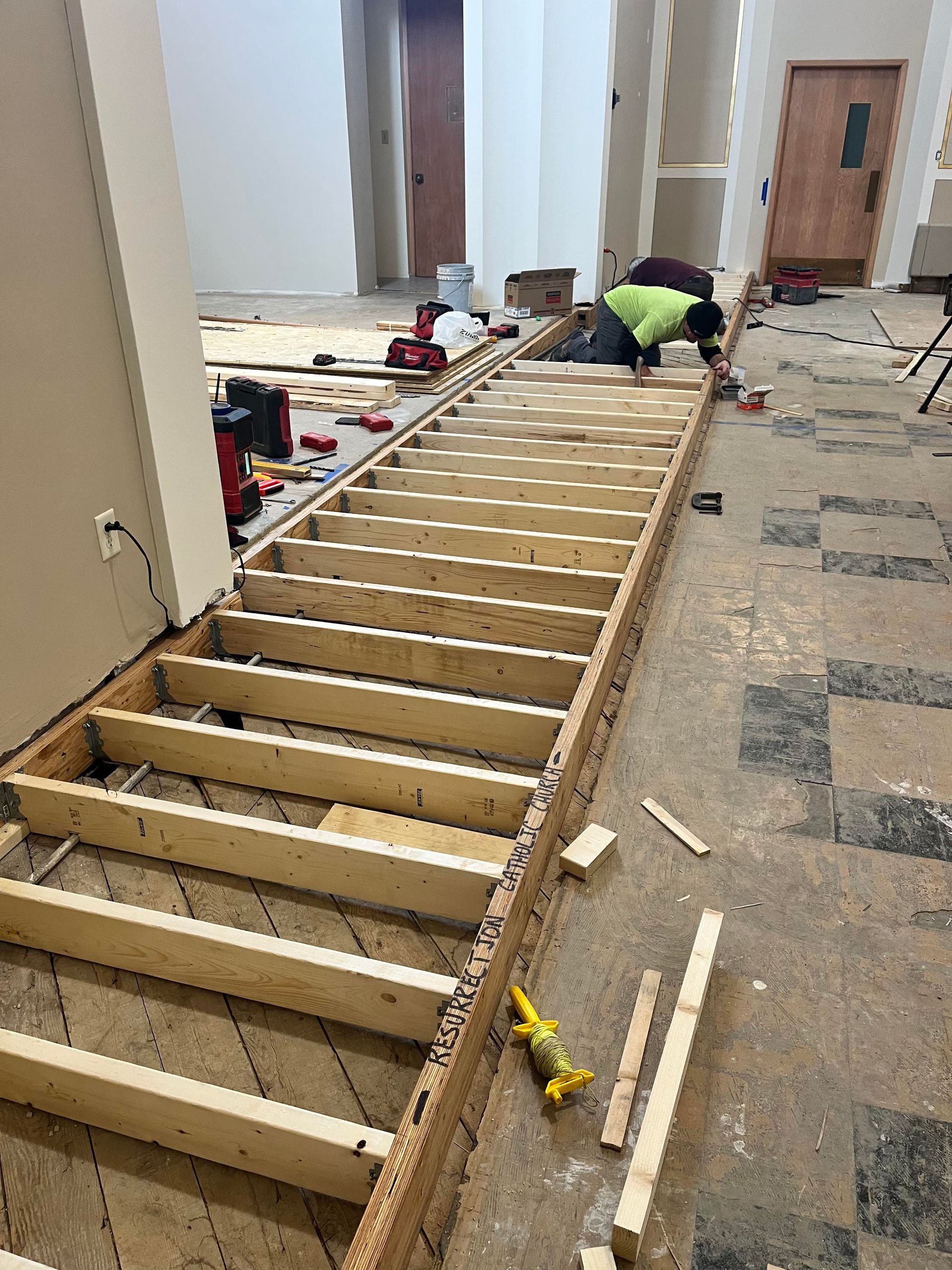

This week Randy Heinecke's crew continued to frame the steps for the sanctuary.

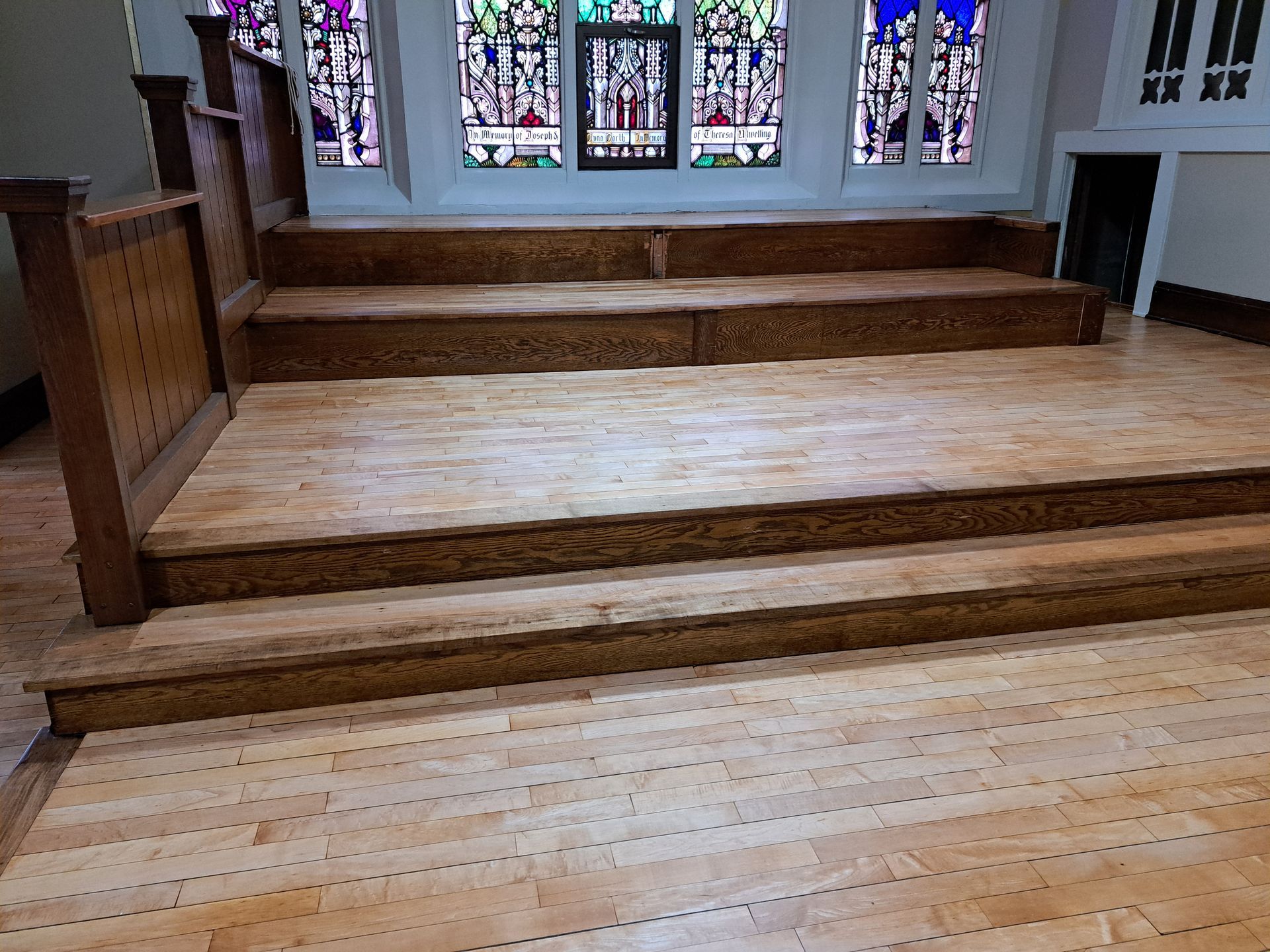

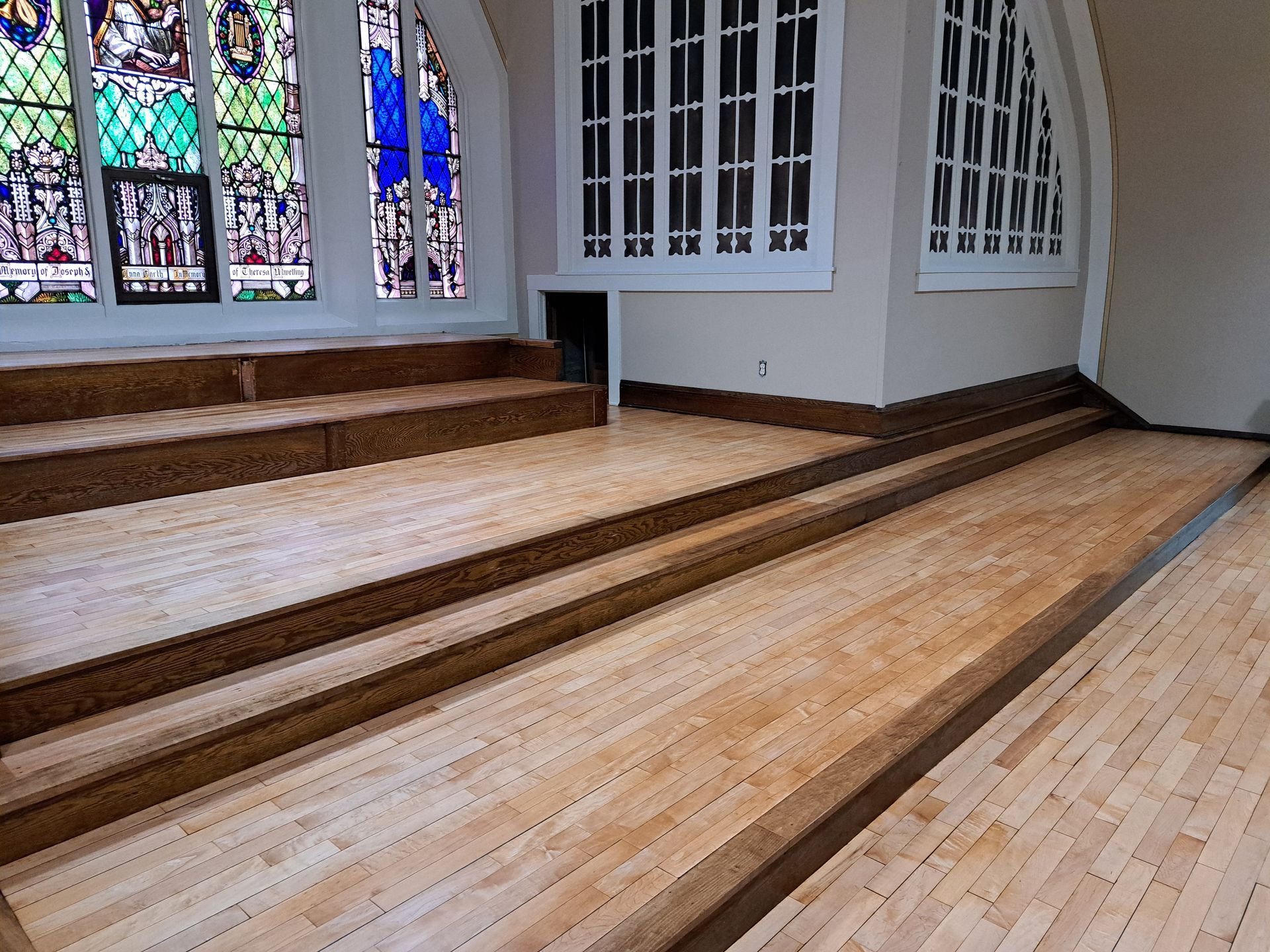

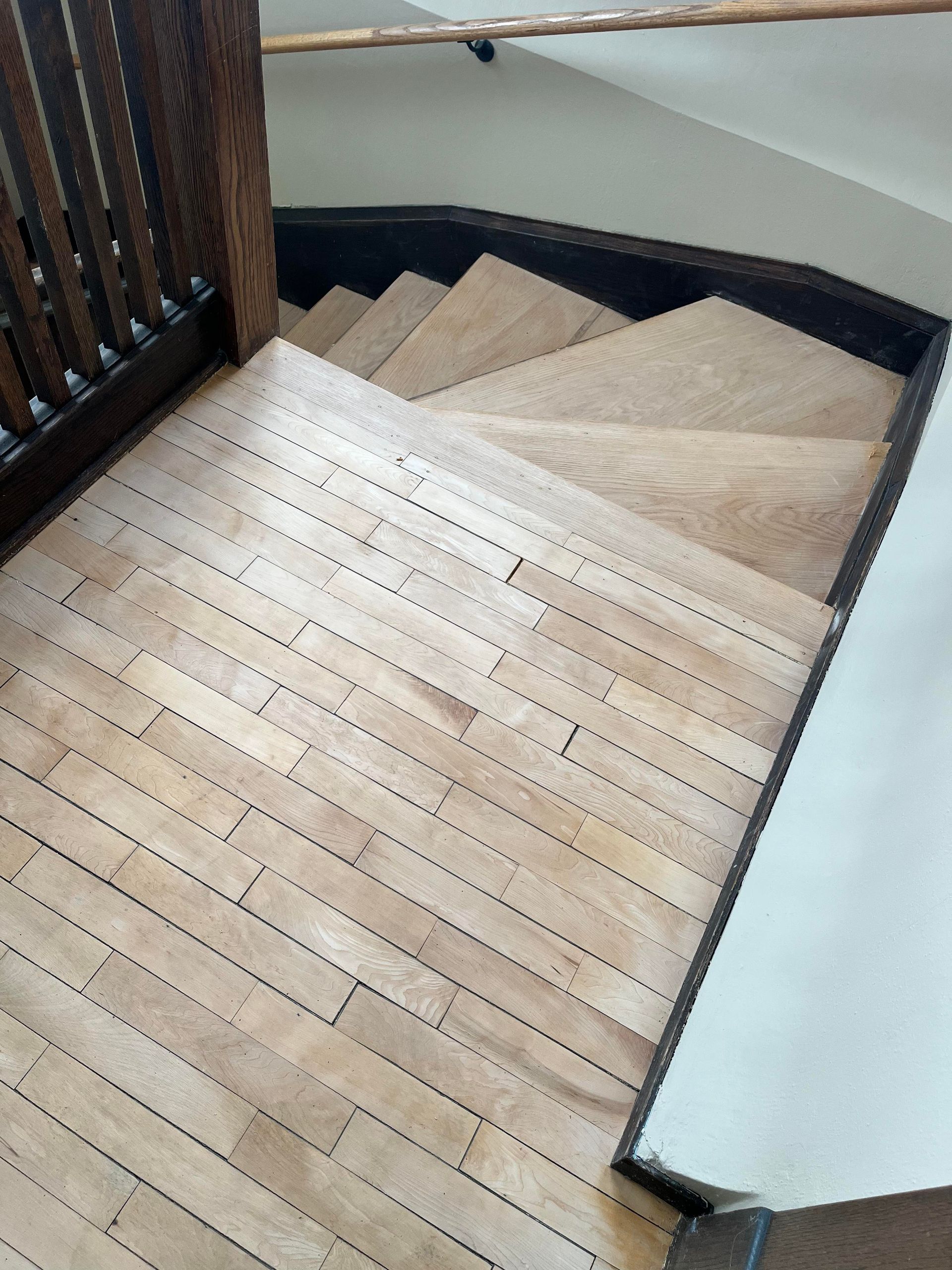

The stairs to the choir loft and the choir loft flooring were also sanded in preparation for new stain.

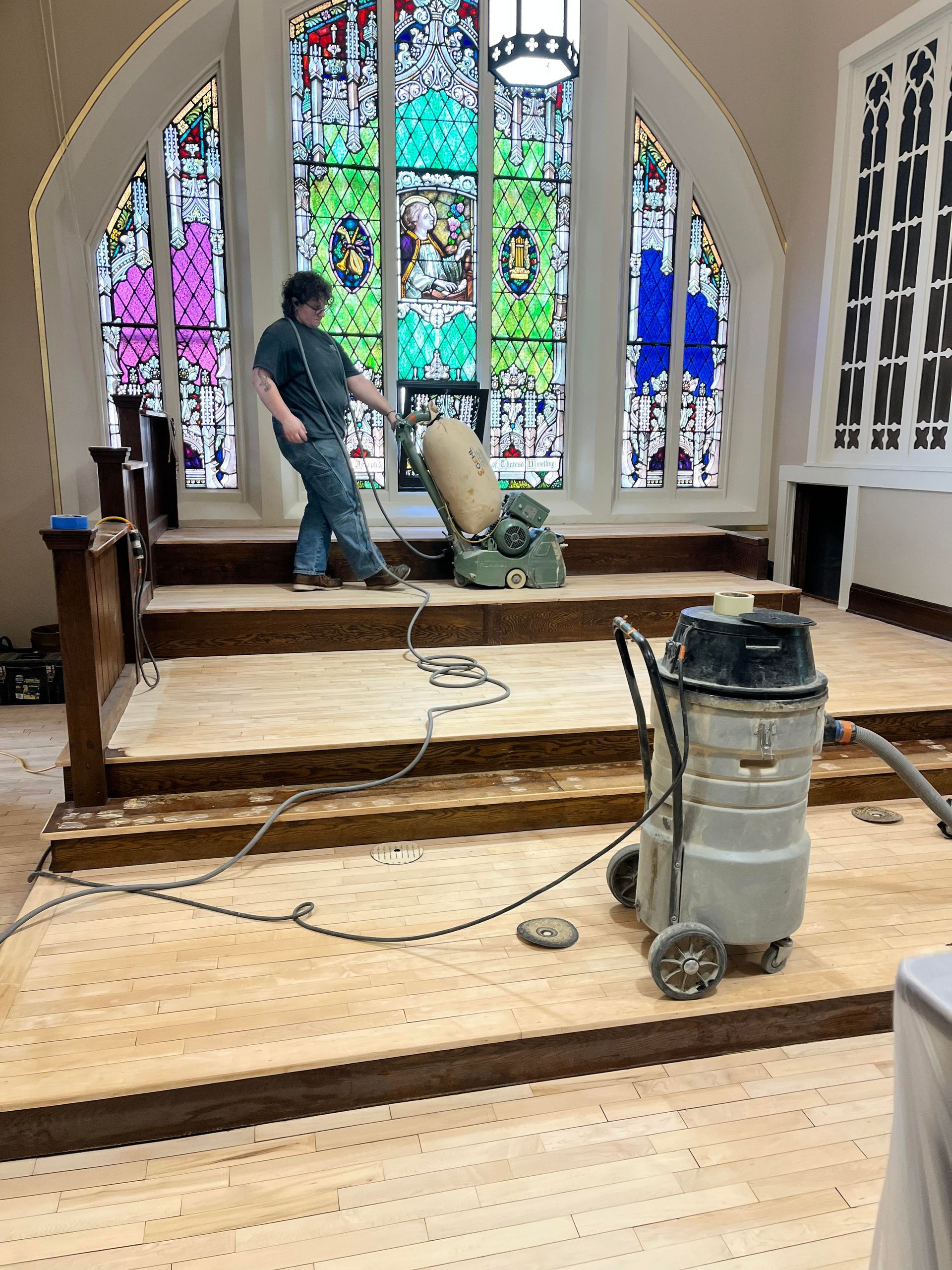

Week of Feb. 16, 2026

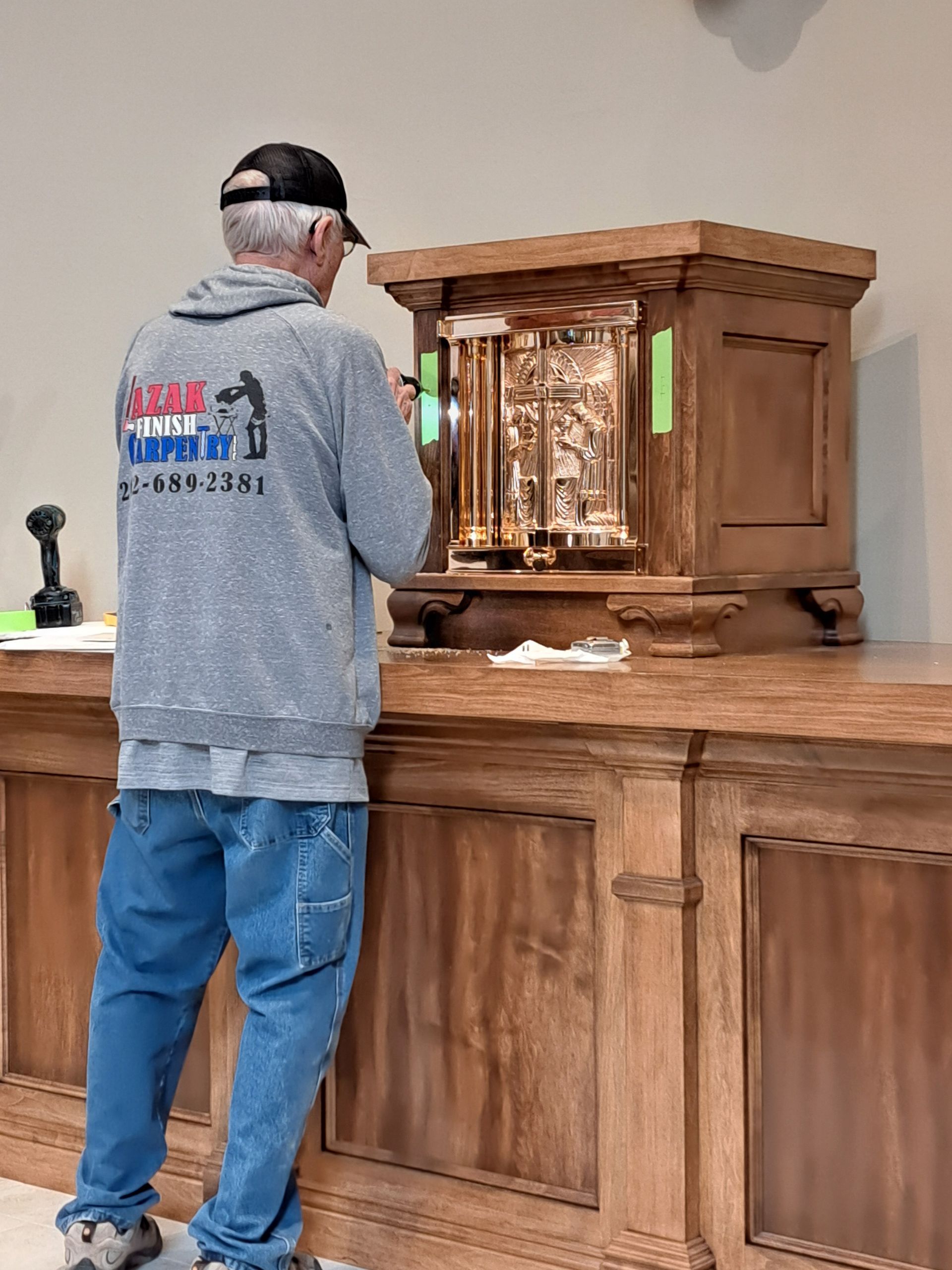

The work continues with two flooring companies, electrician and carpenters on site.
